Inspection |
Notes |
Performed By |
Date |
Passed: Electrical - Temporary Service |
Will Be Used As Temporary And Also Will Be Called In For A Permanent At Later Date |
Troy Crews |
9/21/2020 |
Release to power company |
|
Troy Crews |
9/21/2020 |
Release to power company |
Resent Temp Svc As Per Clay's Request....
sent Originally 09.21.20 |
Troy Crews |
9/23/2020 |
Passed: Building - Footer |
Partial North End Next To Existing House |
Troy Crews |
9/25/2020 |
Passed: Engineering - Setbacks |
|
Troy Crews |
9/25/2020 |

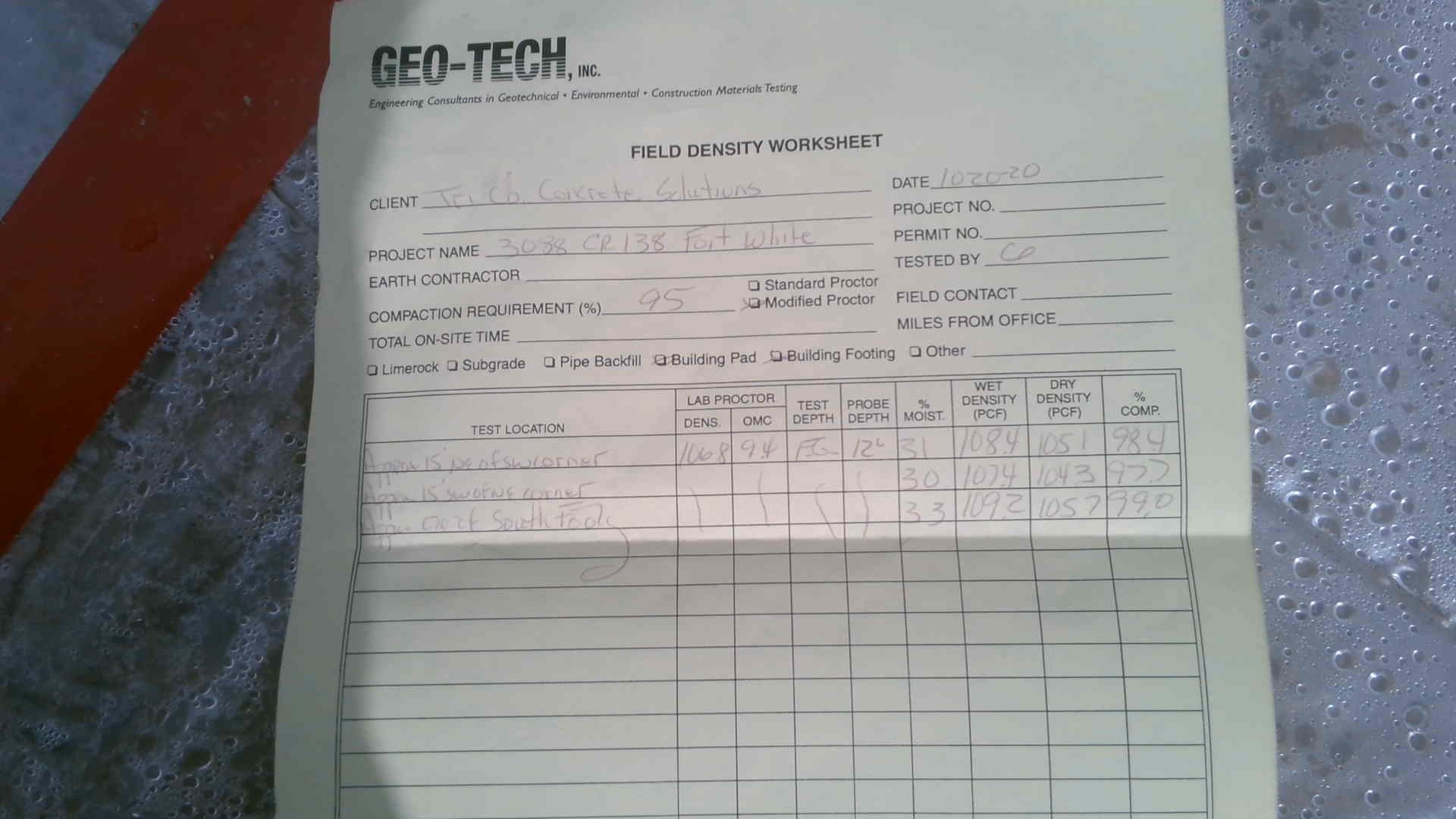

Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Troy Crews |
10/12/2020 |
Passed: Building - Monolithic Slab |
Slab Surrounding Existing House |
Troy Crews |
10/21/2020 |
Passed: Engineering - Setbacks |
|
Troy Crews |
10/21/2020 |
Septic Release Inspection |
|
Health Dept |
10/29/2020 |
Passed: Building - Strapping |
Strapping On Studs Next Inspection Nail Off On Sheathing |
Troy Crews |
12/21/2020 |
Failed: Building - Strapping |
Need Letter On Porch Post To Beam Detail For Strapping |
Anthony Aslan |
6/1/2021 |
Passed: Building - Wall Sheathing |
|
Anthony Aslan |
6/1/2021 |
Passed: Building - Framing |
|
Anthony Aslan |
7/23/2021 |
Passed: Building - Strapping |
|
Anthony Aslan |
7/23/2021 |
Passed: Electrical - 2nd Rough-In |
|
Anthony Aslan |
12/29/2021 |
Passed: Building - Insulation |
|
Anthony Aslan |
6/24/2022 |
Cancelled: Mechanical - Refrigeration |
|
Anthony Aslan |
9/23/2022 |
Passed: Mechanical - Rough In |
|
Anthony Aslan |
9/23/2022 |

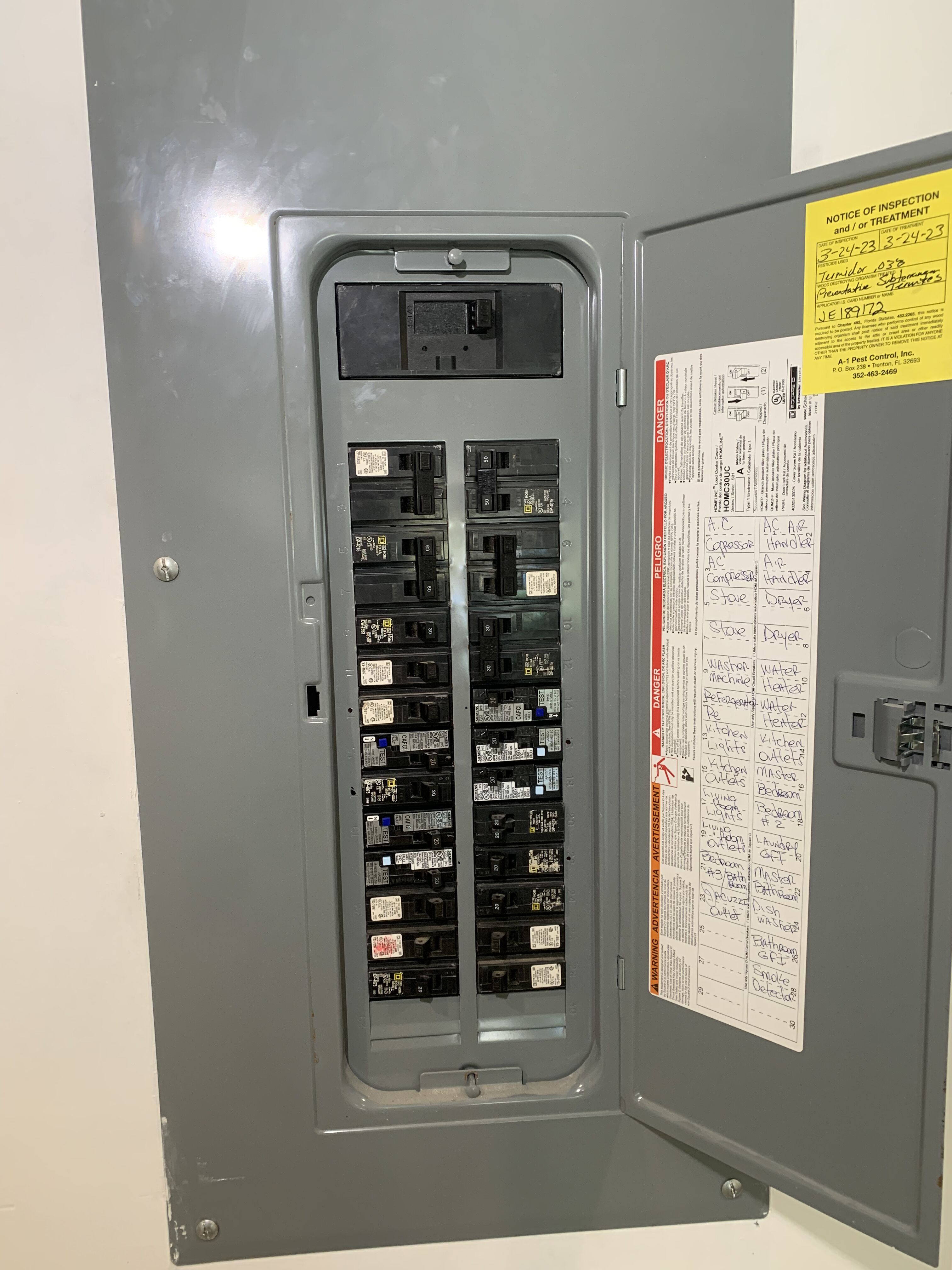

Passed: Building - Final |

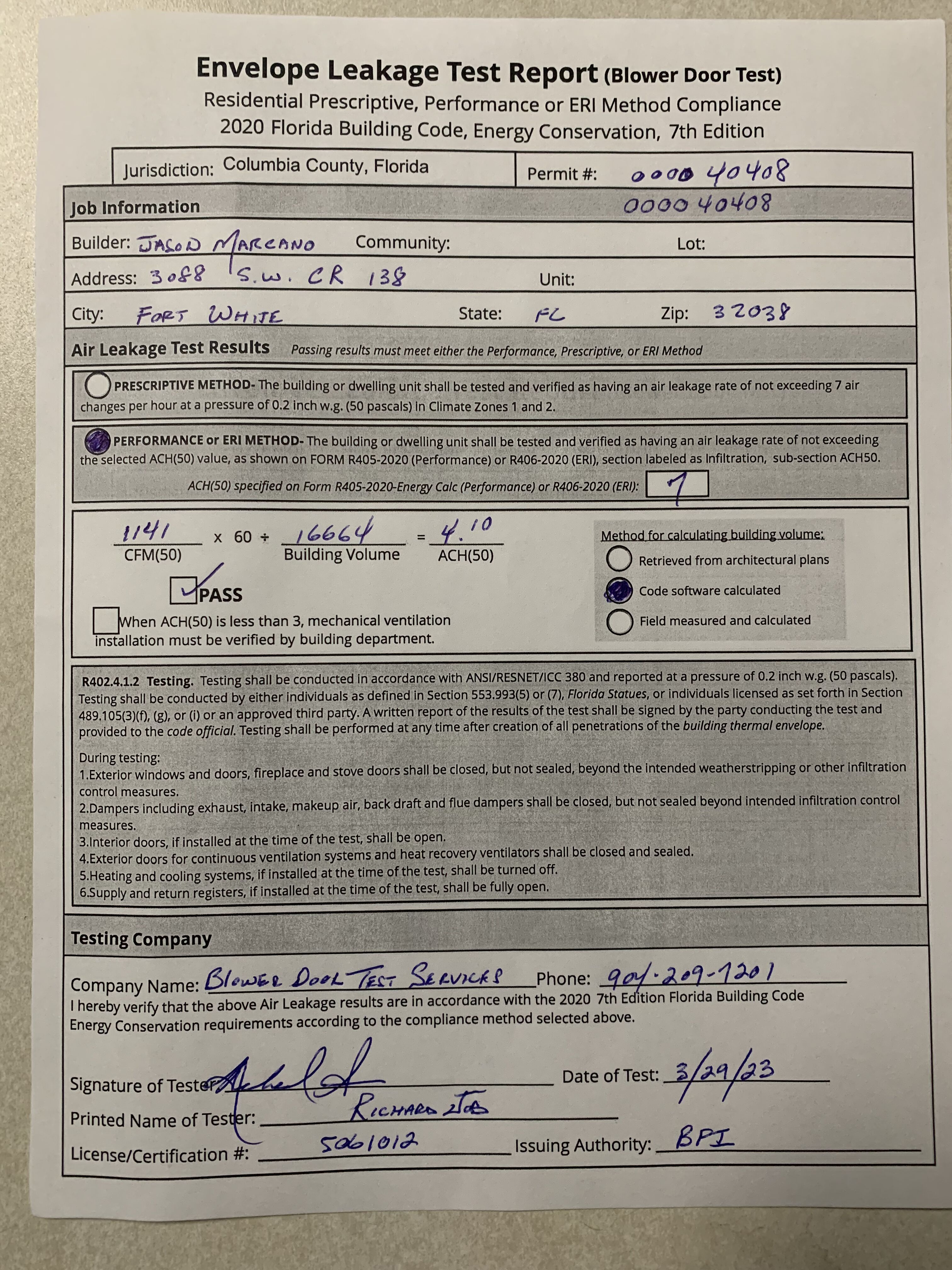

Blower Door Test
final Termite
gfci & Arc Breakers |
Anthony Aslan |
3/16/2023 |
Certificate-Release Certificate |
Recv'd Docs. |
Anthony Aslan |
3/30/2023 |
