| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Matt Forsyth |
9/8/2020 |
| Passed: Building - Monolithic Slab |
|
Matt Forsyth |
9/11/2020 |
| Passed: Engineering - Setbacks |
|
Matt Forsyth |
9/11/2020 |
| Passed: Electrical - Temporary Service |
|
Troy Crews |
9/16/2020 |
| Release to power company |
|
Troy Crews |
9/16/2020 |
| Passed: Building - Wall Sheathing |
|
Troy Crews |
9/28/2020 |
| Passed: Building - Roof Decking |
|
Troy Crews |
10/7/2020 |
| Passed: Building - Framing |
|
Matt Forsyth |
10/14/2020 |
| Passed: Electrical - 2nd Rough-In |
|
Matt Forsyth |
11/12/2020 |
| Passed: Mechanical - Rough In |
|
Matt Forsyth |
11/12/2020 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
11/12/2020 |
| Passed: Building - Insulation |
|
Matt Forsyth |
11/16/2020 |
| Release to power company |
|
Melissa Garber |
3/2/2021 |
| Passed: Electrical - Permanent Power |
Need Releases From Septic And Driveway To Release Power-- Both Rec'd 3/2/2021 |
Matt Forsyth |
3/2/2021 |
| Septic Release Inspection |
|
Health Dept |
3/2/2021 |
| Release to power company |
Driveway & Eh Rec'd. |
Matt Forsyth |
3/10/2021 |
| Failed: Building - Final |
Need Water Heater Wired And Piped To Outside Also Ventilation Fans In Bathrooms Need To Be Installed |
Matt Forsyth |
4/13/2021 |
| Failed: Building - Final |
Waiting On Hot Water Heater Piping |
Matt Forsyth |
4/15/2021 |

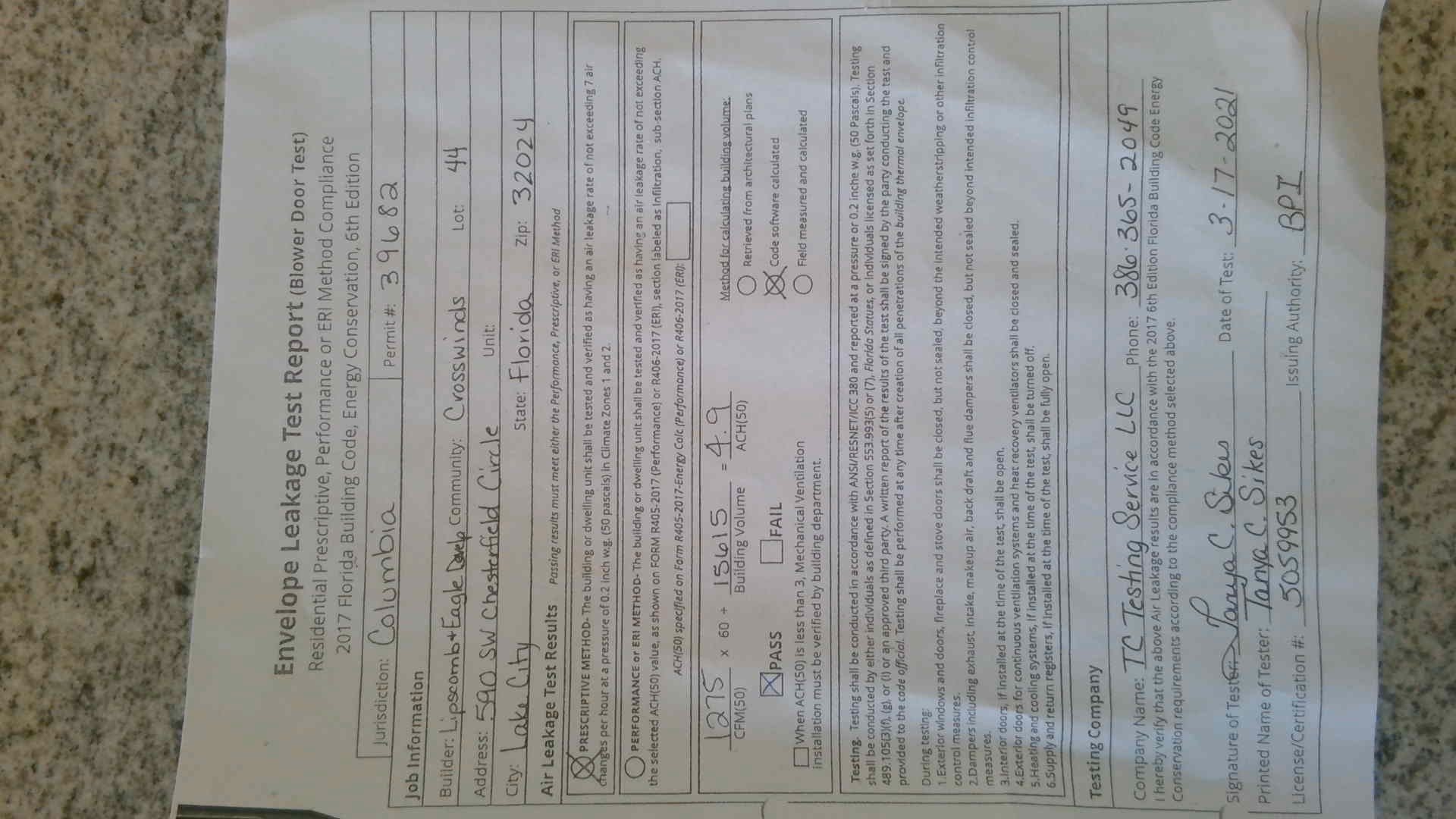

| Passed: Building - Final |
|
Matt Forsyth |
4/16/2021 |
