Inspection |
Notes |
Performed By |
Date |
Failed: Building - Footer |
No Plans Or Permit On Site |
Tommy Matthews |
1/13/2020 |
Failed: Engineering - Setbacks |
No Plans |
Tommy Matthews |
1/13/2020 |
Passed: Building - Footer |
|
Troy Crews |
1/14/2020 |
Passed: Engineering - Setbacks |
|
Troy Crews |
1/14/2020 |
Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Troy Crews |
1/21/2020 |
Passed: Building - Slab |
|
Troy Crews |
1/22/2020 |
Failed: Building - Roof Decking |
Not Ready. |
Tommy Matthews |
2/20/2020 |
Failed: Building - Ext Strapping/Wall Sheathing |
Not Complete. Gables Not Ready. No Strapping Installed. Porch Columns Not Installed With Strapping. Make Sure Engineering Plans Are Available. |
Tommy Matthews |
2/20/2020 |
Passed: Plumbing/Gas - 2nd Rough-In |
|
Troy Crews |
4/7/2020 |
Failed: Mechanical - Rough In |
Not Complete |
Troy Crews |
4/7/2020 |
Cancelled: Electrical - 1st Underground Rough–In |
|
Troy Crews |
4/7/2020 |
Passed: Building - Wall Sheathing |
|
Troy Crews |
4/7/2020 |
Failed: Building - Strapping |
Front Porch Post Not Strapped |
Troy Crews |
4/7/2020 |
Failed: Building - Roof Decking |
Check Areas Above Bonus Room |
Troy Crews |
4/7/2020 |
Cancelled: Building - Ext Strapping/Wall Sheathing |
|
Troy Crews |
4/7/2020 |
Failed: Building - Framing |
Check Strapping On Double Girder Trusses |
Troy Crews |
4/7/2020 |
Failed: Electrical - 2nd Rough-In |
Can Lights Disconnected In Master Bathroom And Open Wiring In Ceiling |
Troy Crews |
4/7/2020 |
Passed: Building - Framing |
|
Troy Crews |
4/13/2020 |
Cancelled: Building - Ext Strapping/Wall Sheathing |
|
Troy Crews |
4/13/2020 |
Failed: Electrical - 2nd Rough-In |
Can Lights Still Disconnected In North East Bathroom |
Troy Crews |
4/13/2020 |
Passed: Mechanical - Rough In |
|
Troy Crews |
4/13/2020 |
Cancelled: Plumbing/Gas - 2nd Rough-In |
|
Troy Crews |
4/13/2020 |
Passed: Building - Strapping |
|
Troy Crews |
4/13/2020 |
Passed: Building - Insulation |
|
Troy Crews |
4/21/2020 |
Passed: Electrical - 2nd Rough-In |
|
Troy Crews |
4/27/2020 |

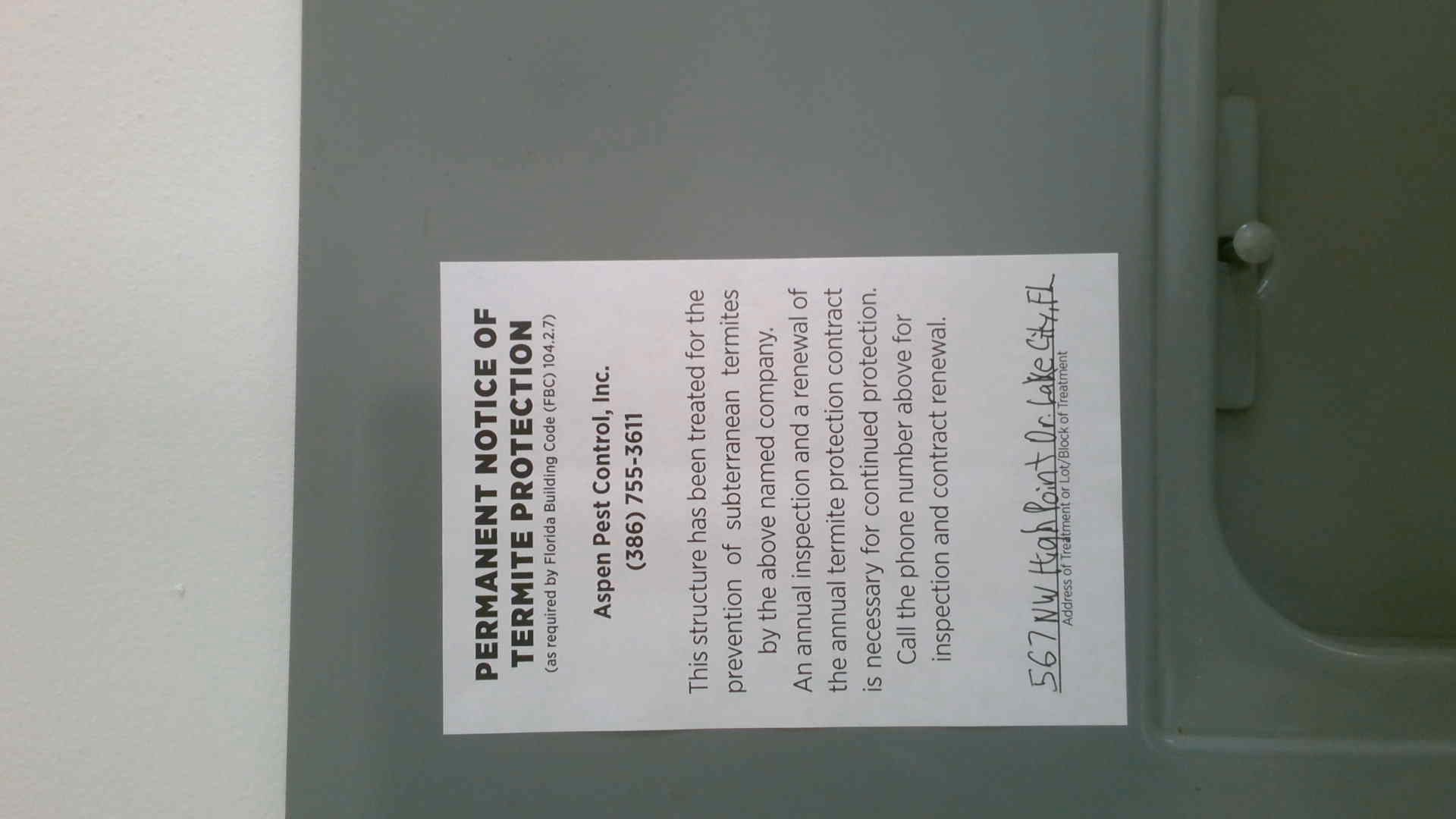

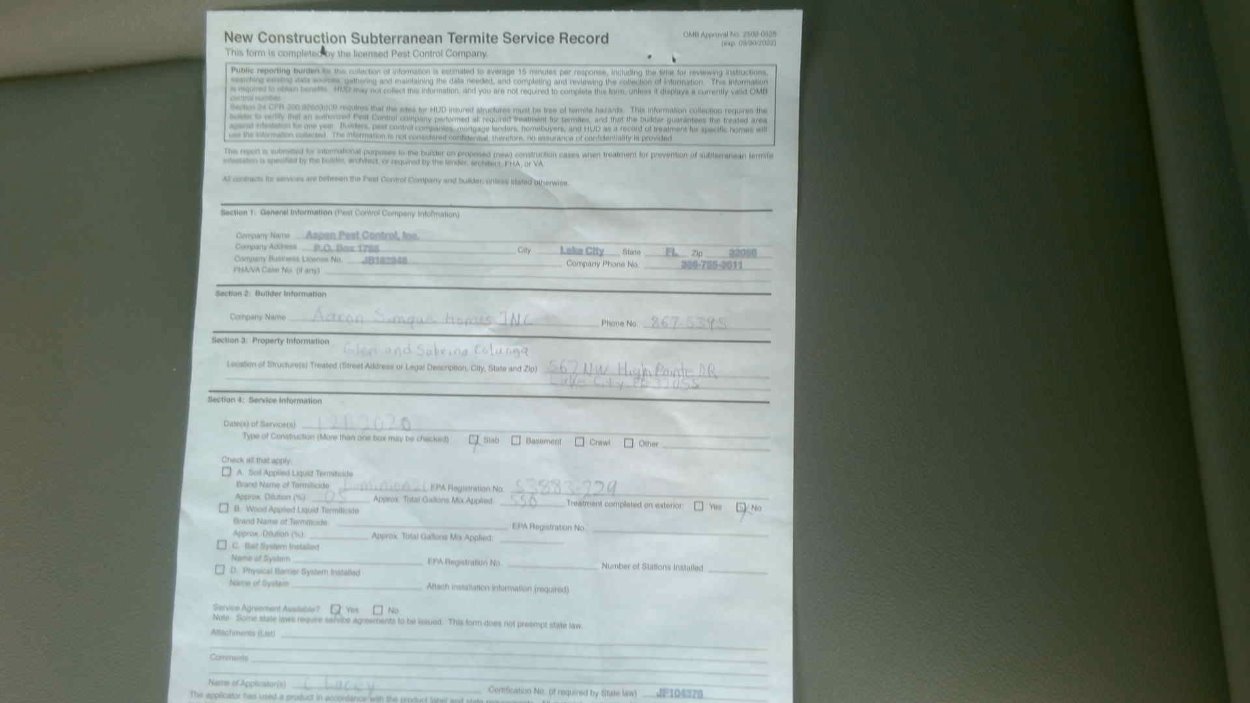

Failed: Building - Slab |
Prior To Approval, Need Structural Change Revision By Engineer. Need Porti Potti On Site. Need Correct Permit On Site. This Request Was Not The Correct Site Location. Termite Spray Not Approved. For Wrong Location. |
Tommy Matthews |
4/28/2020 |
Failed: Electrical - Permanent Power |
No Conduit Out Of Meter Can, Need Garage Doors, Need Final Drive Approval And Septic Approval. |
Troy Crews |
7/30/2020 |
Cancelled: Building - Slab |
Wrong Permit # |
Troy Crews |
8/3/2020 |
Passed: Electrical - Permanent Power |
Electric Panel Lock Temporarily Also Need Final Driveway Release And Final Septic Release |
Troy Crews |
8/7/2020 |
Septic Release Inspection |
|
Health Dept |
8/10/2020 |
Release to power company |
|
Melissa Garber |
8/13/2020 |
Failed: Building - Final |
Bad Receptacle In Garage And Waiting On Blower Door Test-rec'd |
Matt Forsyth |
9/25/2020 |
Passed: Building - Final |
Waiver Permit 39134 Finaled 8/13/20-lh |
Matt Forsyth |
9/29/2020 |
