Inspection |
Notes |
Performed By |
Date |
Passed: Engineering - Initial Driveway |
|
David Mccormick |
2/13/2019 |
Septic Release Inspection |
|
Health Dept |
3/8/2019 |
Release to power company |
|
Troy Crews |
3/8/2019 |
Passed: Electrical - Temporary Service |
|
Troy Crews |
3/11/2019 |
Failed: Electrical - Underground Rough-In |
Not Started |
Troy Crews |
3/11/2019 |
Failed: Plumbing/Gas - Underground Rough-In |
Not Started |
Troy Crews |
3/11/2019 |
Failed: Plumbing/Gas - Underground Rough-In |
Need Water In Head Pipe. |
Tommy Matthews |
3/18/2019 |
Passed: Electrical - Underground Rough-In |
|
Tommy Matthews |
3/19/2019 |
Passed: Plumbing/Gas - Underground Rough-In |
|
Tommy Matthews |
3/19/2019 |

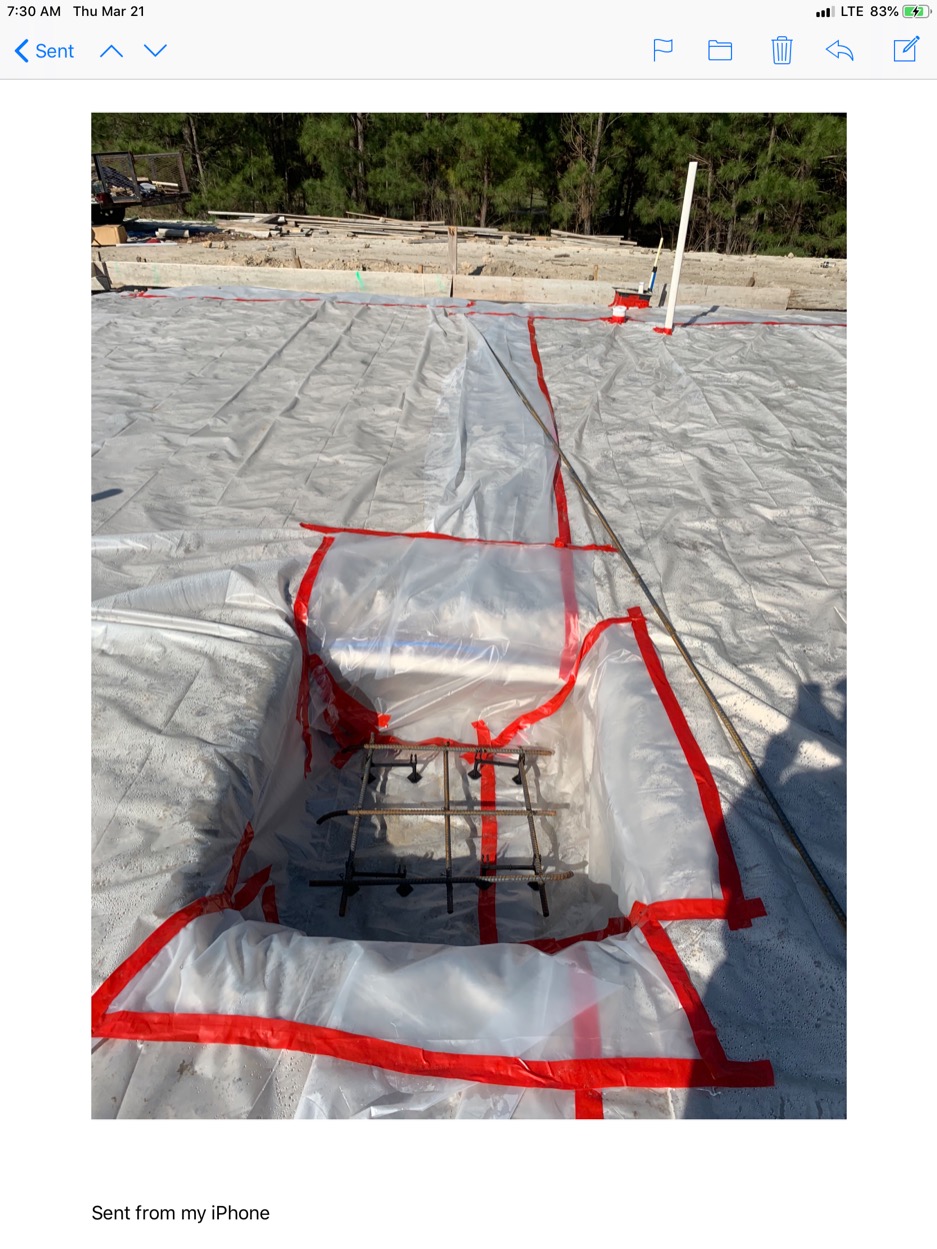

Passed: Building - Monolithic Slab |
|
Troy Crews |
3/20/2019 |
Passed: Engineering - Setbacks |
|
Troy Crews |
3/20/2019 |
Passed: Building - Roof Decking |
|
Troy Crews |
4/15/2019 |
Passed: Building - Ext Strapping/Wall Sheathing |
|
Troy Crews |
4/15/2019 |
Failed: Building - Framing |
Need Elevation Letter Prior To Any Further Inspections |
Troy Crews |
4/24/2019 |
Failed: Electrical - Rough In |
|
Troy Crews |
4/24/2019 |
Failed: Mechanical - Rough In |
|
Troy Crews |
4/24/2019 |
Failed: Electrical - Rough In |
Attic Fans Not Wired In |
Troy Crews |
5/2/2019 |
Passed: Mechanical - Rough In |
|
Troy Crews |
5/2/2019 |
Passed: Building - Framing |
|
Troy Crews |
5/2/2019 |
Passed: Electrical - Rough In |
|
Troy Crews |
5/28/2019 |
Passed: Plumbing/Gas - Rough In |
|
Troy Crews |
5/28/2019 |
Passed: Building - Insulation |
|
Matt Forsyth |
6/5/2019 |
Failed: Electrical - Permanent Power |
No Access To Inside. Service Panel Not Complete. Need Conduit For Underground Electric Provider. Need Garage Door So Panel Can Be Lockable. |
Tommy Matthews |
9/17/2019 |
Passed: Electrical - Permanent Power |
Need Final On Culvert For Release To Power Company |
Troy Crews |
10/3/2019 |
Release to power company |
Rec'd Dw Approval From David Mccormick
10.25.19 |
Tc |
10/25/2019 |
Passed: Engineering - Final Driveway |
|
Mccormick, David |
10/25/2019 |
Failed: Building - Final |

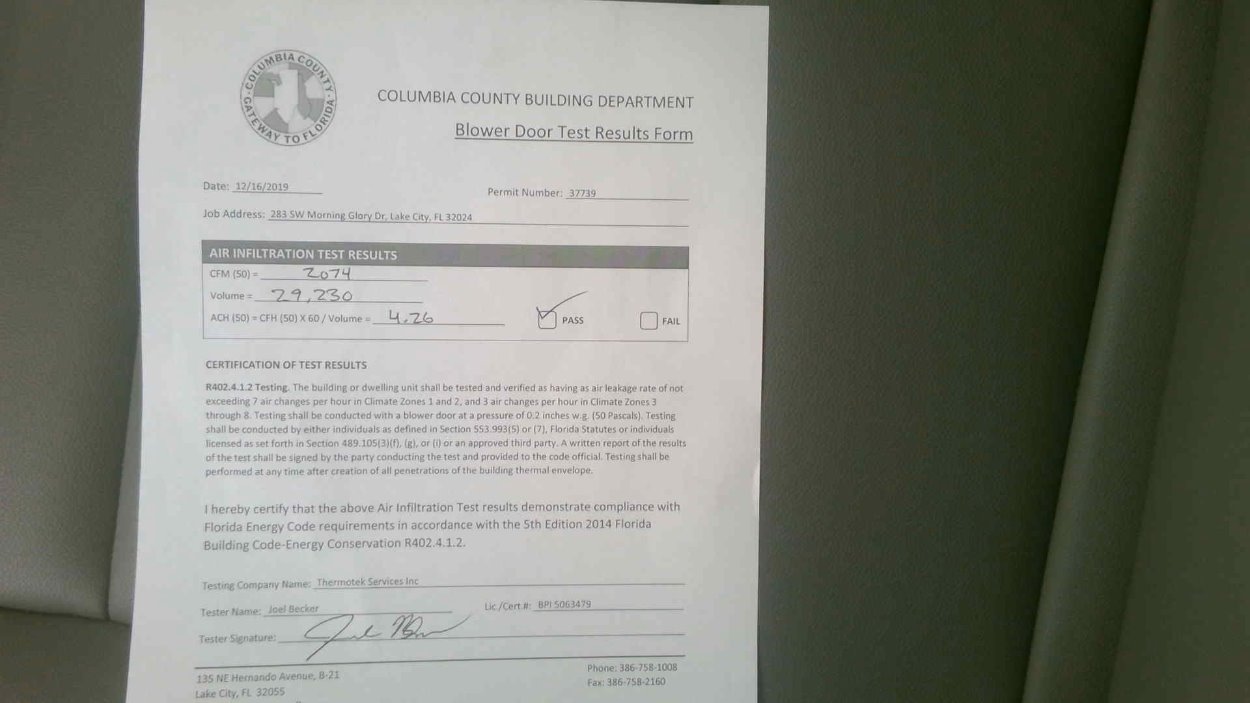

Outside Gfci Plugs Not Working Properly,also Gfci By Laundry Sink. Need Gfci Receptacle In Kitchen Island. Need Final Termite Certificate And Blower Door Test. |
Troy Crews |
12/12/2019 |
Passed: Building - Final |
Items Received And Corrected. |
Troy Crews |
12/17/2019 |
