New Residential Construction

374 NW AMBLESIDE DR
LAKE CITY, FL 32055

Permit #
000037533
Application #
39987
Status Completed
  1. Submitted Dec 12, 2018
  2. Issued Dec 12, 2018
  3. Expires Feb 25, 2020
  4. Completed Sep 5, 2019

Property

Parcel #
02275-127
Owner
W. Wes & Peggy Kent
Acres
2.03
Subdivision
Cobblestone
Zoning
RSF-2
Flood zone
X
District
1

Permit

Status
Completed
Septic release
Released
Related permit
—

Job Details

Finished floor requirement
Fema map number
12023C0283D
This is the construction of a
SFD/UTILITY
Setbacks Front
25.00
Setback Side 1
10.00
Setback Side 2
10.00
Setbacks Rear
15.00
Stories
2
Heated Area (Sqft)
2769.00
Total Area (Sqft)
4383.00
Building Code Edition
Florida Building Code 2017 6th Edition & 2014 National Electrical Code
Septic# (00-0000) or (X00-000)
18-0928

Status & Review History

No status updates yet.

Contractors

  • Isaiah Cully

    License
    CBC1259655
    Title
    —
    Role
    —

Inspections

  1. Dec 27, 2018

    Failed: Building - Footer

    Need Compaction Test

    Inspected by Randy Jones

  2. Dec 27, 2018

    Passed: Engineering - Setbacks

    Inspected by Randy Jones

  3. Jan 8, 2019

    Cancelled: Building - Footer

    Inspected by Tommy Matthews

  4. Jan 8, 2019

    Cancelled: Engineering - Setbacks

    Inspected by Tommy Matthews

  5. Jan 9, 2019

    Passed: Building - Footer

    Inspected by Tommy Matthews

  6. Jan 9, 2019

    Passed: Engineering - Setbacks

    Inspected by Tommy Matthews

  7. Jan 23, 2019

    Passed: Plumbing/Gas - Underground Rough-In

    Inspected by Troy Crews

  8. Jan 24, 2019

    Passed: Building - Slab

    Inspected by Troy Crews

  9. Jan 24, 2019

    Failed: Electrical - Temporary Service

    Not Installed

    Inspected by Troy Crews

  10. Jan 31, 2019

    Release to power company

    Corrected Power Company

    Inspected by Laurie Hodson

  11. Jan 31, 2019

    Passed: Electrical - Temporary Service

    Inspected by Tommy Matthews

  12. Jan 31, 2019

    Release to power company

    Inspected by Tommy Matthews

  13. Feb 15, 2019

    Passed: Building - Ext Strapping/Wall Sheathing

    Inspected by Troy Crews

  14. Apr 3, 2019

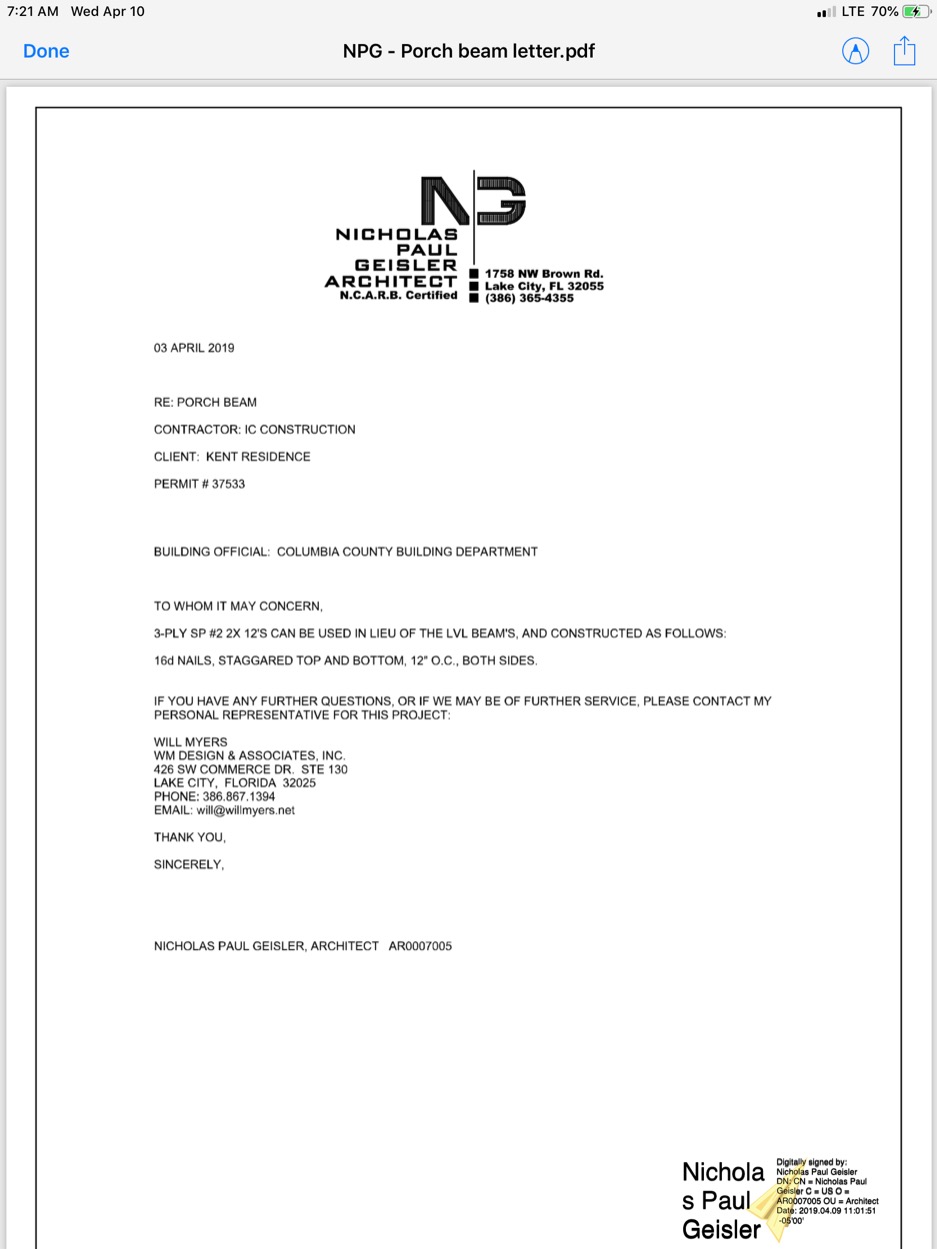

    Failed: Building - Framing

    Shearwall Headers Do Not Have Correct Jacks And Kings. garage Door Headers Not As Per Detail. beams On Front And Back Porch Should Be Lvls check Corner Brackets As Called For In Detail front Porch Not Completed As Per Plan.

    Inspected by Tommy Matthews

  15. Apr 10, 2019

    Failed: Building - Framing

    See Previous Comments From 4/3/19 Inspection. Need To Follow Up On Comments.

    Inspected by Tommy Matthews

  16. May 7, 2019

    Passed: Building - Framing

    Letters In File For Items Noted

    Inspected by Troy Crews

  17. May 7, 2019

    Passed: Electrical - Rough In

    Inspected by Troy Crews

  18. May 7, 2019

    Passed: Mechanical - Rough In

    Nail Plate On Top Plate Where Lines Passing Thru

    Inspected by Troy Crews

  19. May 7, 2019

    Passed: Plumbing/Gas - Rough In

    Inspected by Troy Crews

  20. May 20, 2019

    Passed: Building - Insulation

    Inspected by Matt Forsyth

  21. Aug 15, 2019

    Passed: Electrical - Permanent Power

    Need Septic And Driveway Released To Release Power

    Inspected by Matt Forsyth

  22. Aug 16, 2019

    Septic Release Inspection

    Inspected by Health Dept

  23. Aug 20, 2019

    Release to power company

    Driveway Completed By Dm On 08.20.19

    Inspected by Mf

  24. Aug 29, 2019

    Passed: Building - Final

    Inspected by Tommy Matthews
