Permit Details

Permit Search

Permit

New Residential Construction

243 SW WILSHIRE DR LAKE CITY FL 32024

Permit #
000036639
Application #
37600
Status Completed
  1. Submitted Apr 26, 2018
  2. Issued Apr 26, 2018
  3. Expires May 27, 2019
  4. Completed Dec 4, 2018

Property

Parcel #
03023-397
Owner
Roger Parish
Acres
0.50
Subdivision
Callaway
Zoning
RSF-2
Flood zone
X
District
3

Permit

Status
Completed
Septic release
Released
Related permit
—

Job Details

Finished floor requirement
Fema map number
12023C0289D
This is the construction of a
SFD/UTILITY
Setbacks Front
25.00
Setback Side 1
10.00
Setback Side 2
10.00
Setbacks Rear
15.00
Stories
1
Heated Area (Sqft)
1544.00
Total Area (Sqft)
1974.00
Building Code Edition
Florida Building Code 2017 6th Edition & 2014 National Electrical Code
Septic# (00-0000) or (X00-000)
18-0307

Status & Review History

No status updates yet.

Contractors

  • Jerry Castagna

    License
    CBC047842
    Title
    —
    Role
    —

    County License & State License & Liability Insurance & Workers Comp Expired.

Inspections

  1. May 1, 2018

    Passed: Electrical - Temporary Service

    Inspected by Tommy Matthews

  2. May 1, 2018

    Release to power company

    Inspected by Tommy Matthews

  3. May 21, 2018

    Passed: Plumbing/Gas - Rough In

    Inspected by Troy Crews

  4. May 24, 2018

    Passed: Building - Footer

    Inspected by Troy Crews

  5. May 24, 2018

    Passed: Engineering - Setbacks

    Inspected by Troy Crews

  6. May 24, 2018

    Passed: Building - Slab

    Inspected by Troy Crews

  7. Jun 15, 2018

    Cancelled: Building - Framing

    Inspected by Troy Crews

  8. Jun 15, 2018

    Passed: Building - Ext Strapping/Wall Sheathing

    No Strapping Walls Only

    Inspected by Troy Crews

  9. Jul 5, 2018

    Passed: Building - Framing

    Inspected by Troy Crews

  10. Jul 18, 2018

    Passed: Electrical - Rough In

    Inspected by Troy Crews

  11. Jul 18, 2018

    Failed: Mechanical - Rough In

    Connect Bath Fans

    Inspected by Troy Crews

  12. Jul 18, 2018

    Passed: Plumbing/Gas - Rough In

    Inspected by Troy Crews

  13. Jul 19, 2018

    Passed: Mechanical - Rough In

    Bath Fan Ducts Connected

    Inspected by Troy Crews

  14. Jul 20, 2018

    Passed: Building - Insulation

    Inspected by Troy Crews

  15. Oct 3, 2018

    Passed: Electrical - Permanent Power

    Inspected by Tommy Matthews

  16. Oct 25, 2018

    Release to power company

    Inspected by Laurie Hodson

  17. Oct 25, 2018

    Septic Release Inspection

    Inspected by Health Dept

  18. Nov 5, 2018

    Failed: Building - Final

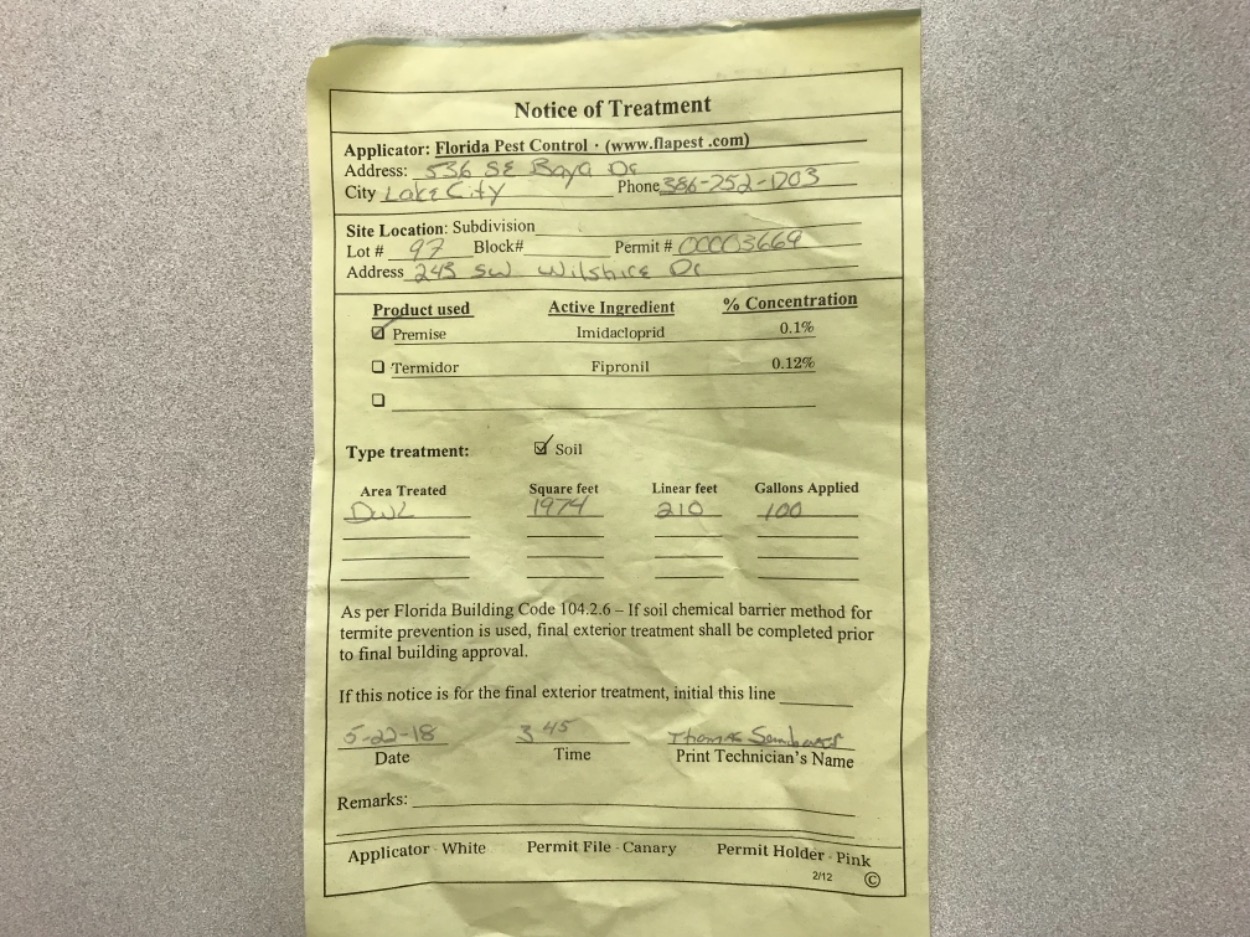

    Need Blower Door Test. need Final Termite Treatment Around Perimeter Of Home. gfi Does Not Work Properly In Kitchen.

    Inspected by Tommy Matthews

  19. Nov 28, 2018

    Passed: Building - Final

    Rec'd Blower Door Test 11/29/18

    Inspected by Tommy Matthews
