Inspection |
Notes |
Performed By |
Date |
Release to power company |
|
Troy Crews |
2/21/2018 |
Passed: Electrical - Temporary Service |
|
Troy Crews |
2/22/2018 |
Passed: Electrical - Underground Rough-In |
Main Conduits From Electric Room To Transformer |
Troy Crews |
3/2/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Per Notes |
Troy Crews |
3/5/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved Per Notes |
Troy Crews |
3/5/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved Per Notes |
Troy Crews |
3/5/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved Per Notes |
Troy Crews |
3/5/2018 |
Passed: Plumbing/Gas - Rain Leader |
Approved Per Notes |
Troy Crews |
3/5/2018 |
Passed: Building - Footer |
Approved As Requested |
Troy Crews |
3/7/2018 |
Passed: Engineering - Setbacks |
|
Troy Crews |
3/7/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/9/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
3/9/2018 |
Passed: Plumbing/Gas - Rain Leader |
Approved As Requested |
Troy Crews |
3/9/2018 |
Passed: Electrical - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/13/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/13/2018 |
Passed: Plumbing/Gas - Rain Leader |
Approved As Requested |
Troy Crews |
3/13/2018 |
Passed: Building - Footer |
Approved As Requested |
Troy Crews |
3/14/2018 |
Passed: Engineering - Setbacks |
|
Troy Crews |
3/14/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/14/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
3/14/2018 |
Cancelled: Building - Slab |
|
Troy Crews |
3/16/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested Sremwall |
Troy Crews |
3/19/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/19/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
3/19/2018 |
Passed: Building - Footer |
Approved As Requested |
Troy Crews |
3/21/2018 |
Passed: Engineering - Setbacks |
Approved As Requested |
Troy Crews |
3/21/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
3/22/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested Waste Lines |
Troy Crews |
3/23/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested Waste Lines |
Troy Crews |
3/23/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/26/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
3/26/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/27/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
3/27/2018 |
Passed: Electrical - Footer Steel & Grounding |
Approved As Requested |
Troy Crews |
3/28/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/28/2018 |
Passed: Plumbing/Gas - Sanitary |
|
Troy Crews |
3/28/2018 |
Passed: Building - Footer |
Approved As Requested |
Troy Crews |
3/29/2018 |
Passed: Engineering - Setbacks |
|
Troy Crews |
3/29/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
3/29/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
3/29/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
3/29/2018 |
Rescheduled 4/3/2018:Building - Masonry Wall Reinforcing |
|
Troy Crews |
4/2/2018 |
Rescheduled 4/3/2018:Plumbing/Gas - Rough In |
|
Troy Crews |
4/2/2018 |
Rescheduled 4/4/2018:Plumbing/Gas - Sanitary |
|
Troy Crews |
4/2/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
4/3/2018 |
Passed: Plumbing/Gas - Rough In |
Approved As Requested |
Troy Crews |
4/3/2018 |

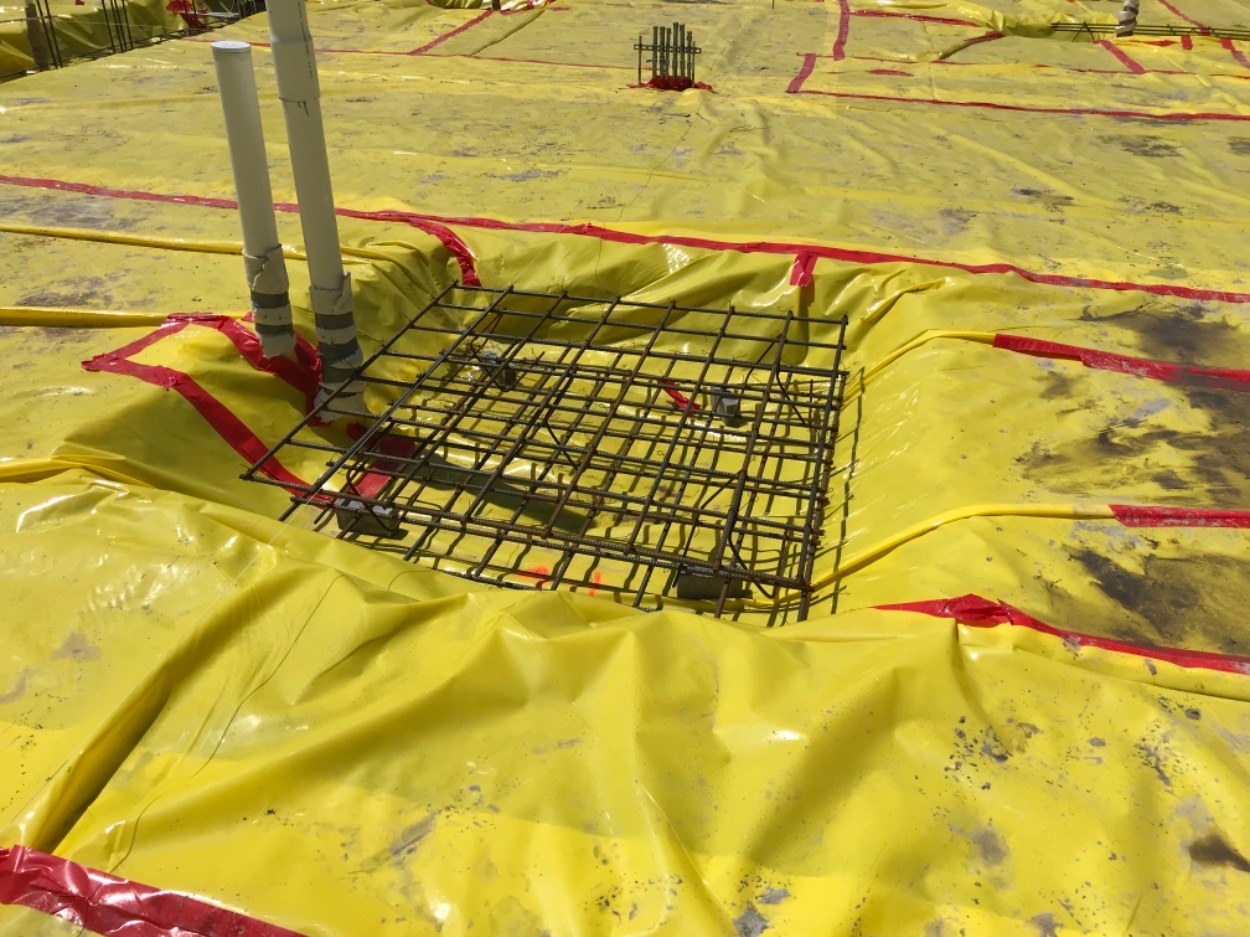

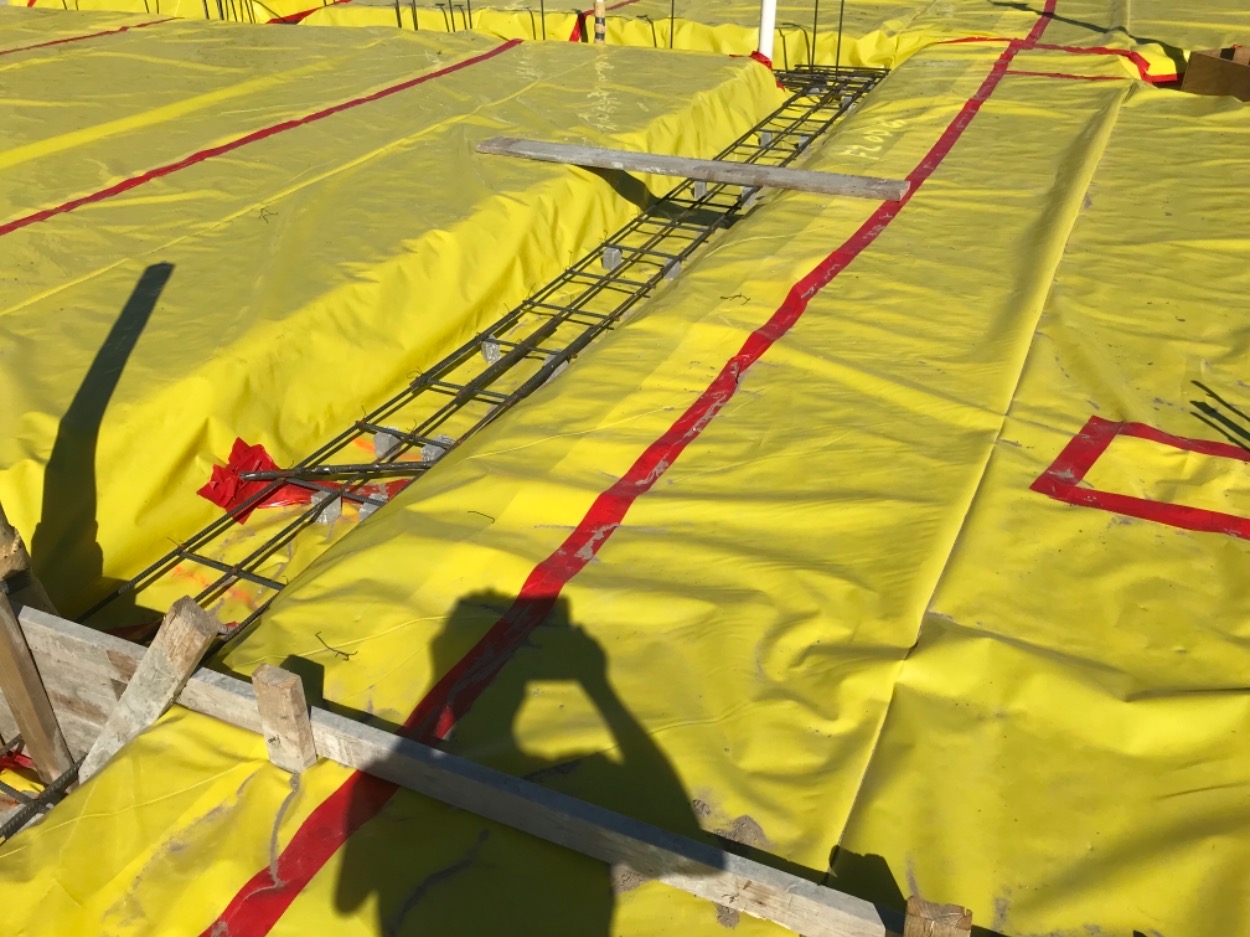

Passed: Building - Slab |
Approved As Requested |
Troy Crews |
4/4/2018 |
Cancelled: Plumbing/Gas - Underground Rough-In |
|
Troy Crews |
4/5/2018 |
Cancelled: Plumbing/Gas - Sanitary |
|
Troy Crews |
4/5/2018 |
Passed: Plumbing/Gas - Water Pipe |
Approved As Requested Domestic Water |
Troy Crews |
4/5/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
4/5/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
4/5/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
4/6/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
4/6/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
4/9/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
4/10/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
4/10/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
4/10/2018 |
Passed: Building - Slab |
Approved As Requested |
Troy Crews |
4/12/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
4/12/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
4/12/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
4/13/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
4/13/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
4/13/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
4/17/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
4/17/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
4/17/2018 |
Passed: Building - Slab |
Approved As Requested |
Troy Crews |
4/18/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
4/19/2018 |
Passed: Plumbing/Gas - Sanitary |
Approved As Requested |
Troy Crews |
4/19/2018 |
Passed: Plumbing/Gas - Underground Rough-In |
Approved As Requested |
Troy Crews |
4/20/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
4/24/2018 |
Passed: Building - Slab |
Approved As Requested |
Troy Crews |
4/25/2018 |
Passed: Building - Lintel/Tie Beam |
Approved As Requested |
Troy Crews |
4/26/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
5/4/2018 |
Passed: Building - Slab |
Approved As Requested |
Troy Crews |
5/8/2018 |
Passed: Building - Roof Decking |
Approved As Requested |
Troy Crews |
5/9/2018 |
Passed: Building - Slab |
Approved As Requested |
Troy Crews |
5/10/2018 |
Passed: Building - Lintel/Tie Beam |
Approved As Requested |
Troy Crews |
5/11/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
5/11/2018 |
Passed: Building - Roof Decking |
Approved As Requested |
Troy Crews |
5/14/2018 |
Passed: Building - Slab |
Approved As Requested |
Troy Crews |
5/23/2018 |
Passed: Building - Roof Decking |
Approved Zone 5 |
Troy Crews |
5/23/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
5/29/2018 |
Passed: Building - Vertical Cells/Columns |
Approved As Requested |
Troy Crews |
6/1/2018 |

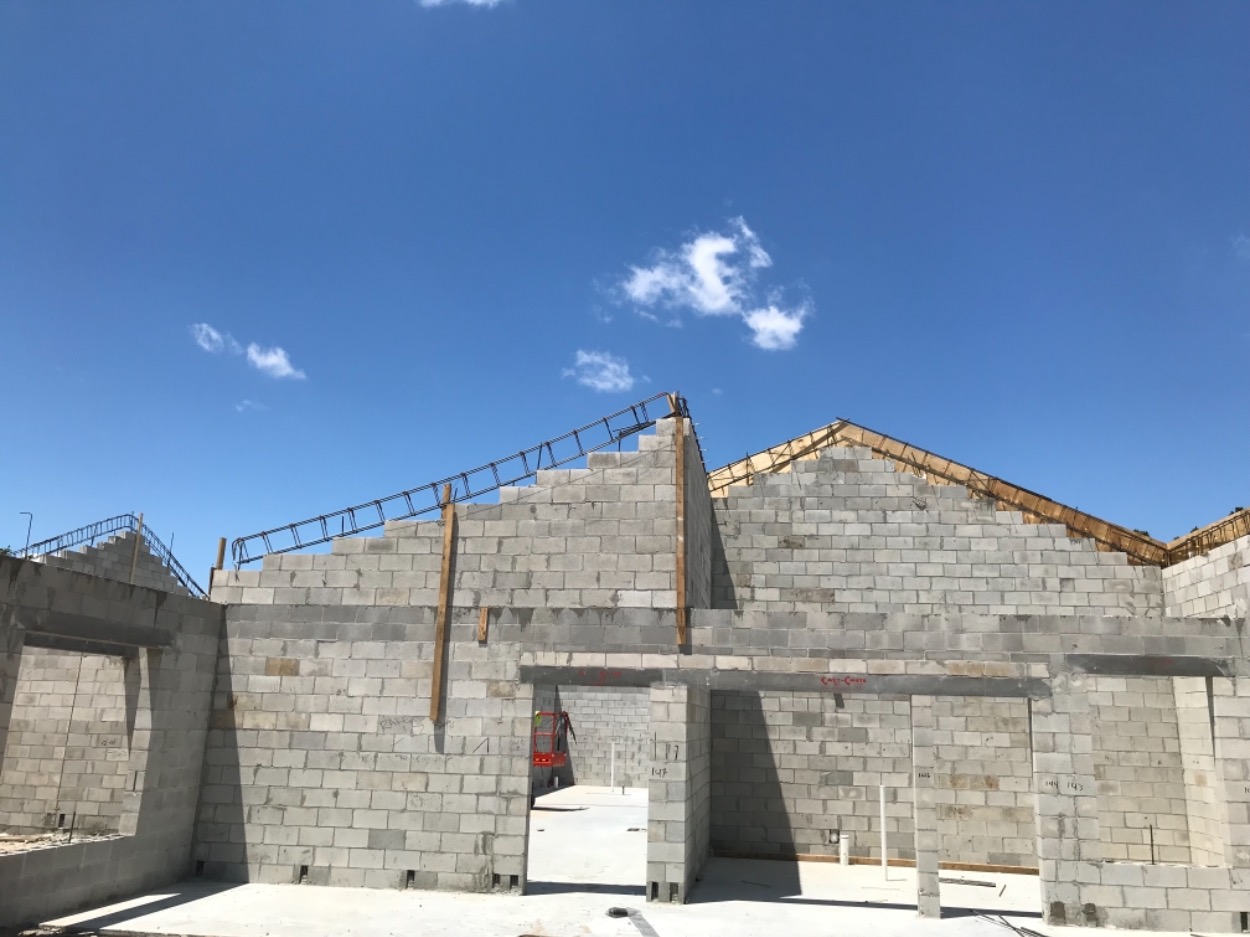

Passed: Building - Framing |
Approved As Requested |
Troy Crews |
6/1/2018 |
Passed: Building - Vertical Cells/Columns |
|
Troy Crews |
6/1/2018 |
Passed: Fire - Underground Main - Visual |
|
Josh Wehinger |
6/1/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
6/8/2018 |
Passed: Building - Roof Decking |
Approved As Requested |
Troy Crews |
6/8/2018 |
Passed: Building - Lintel/Tie Beam |
Approved As Requested |
Troy Crews |
6/11/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
6/13/2018 |
Passed: Building - Vertical Cells/Columns |
Approved As Requested |
Troy Crews |
6/15/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
6/15/2018 |
Passed: Plumbing/Gas - Interceptor |
Back To Back Grease Tanks Approved As Requested |
Troy Crews |
6/21/2018 |
Passed: Building - Vertical Cells/Columns |
Approved As Requested |
Troy Crews |
6/21/2018 |
Passed: Building - Lintel/Tie Beam |
Approved As Requested |
Troy Crews |
6/21/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
6/21/2018 |
Passed: Building - Rated Assembly Fastening |
Hallway And Partial Bathrooms Zone 1 And Partial Hallway Zone 2 |
Troy Crews |
6/28/2018 |
Passed: Building - Roof Decking |
Approved As Requested |
Troy Crews |
7/10/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
7/11/2018 |
Passed: Plumbing/Gas - Rain Leader |
Approved As Requested |
Troy Crews |
7/12/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
7/12/2018 |
Passed: Building - Lintel/Tie Beam |
Approved As Requested |
Troy Crews |
7/17/2018 |
Passed: Building - Masonry Wall Reinforcing |
Approved As Requested |
Troy Crews |
7/17/2018 |
Rescheduled 8/6/2018:Plumbing/Gas - Water Pipe |
|
Troy Crews |
8/3/2018 |
Passed: Plumbing/Gas - Water Pipe |
Approved As Requested 100 Psi |
Troy Crews |
8/6/2018 |
Passed: Fire - Operational Test - Chemical/Gaseous Agent |
|
Josh Wehinger |
8/13/2018 |
Passed: Electrical - Above Ceiling |
Rough In Tower Area Approved As Requested |
Troy Crews |
8/15/2018 |
Passed: Mechanical - Above Ceiling |
Rough In Tower Area Approved As Requested |
Troy Crews |
8/15/2018 |
Passed: Building - Insulation |
Approved As Requested Tower Area |
Troy Crews |
8/23/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
8/29/2018 |
Passed: Building - Rated Assembly Fastening |
Approved As Requested |
Troy Crews |
8/29/2018 |
Passed: Fire - Aboveground Sprinkler - Visual (On Site) |
|
Josh Wehinger |
8/29/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
8/30/2018 |
Passed: Building - Above Ceiling |
Approved As Requested |
Troy Crews |
8/30/2018 |
Passed: Electrical - Rough In |
Approved As Requested |
Troy Crews |
8/30/2018 |
Passed: Electrical - Above Ceiling |
Approved As Requested |
Troy Crews |
8/30/2018 |
Passed: Mechanical - Above Ceiling |
Approved As Requested |
Troy Crews |
8/30/2018 |
Passed: Mechanical - Rough In |
Approved As Requested |
Troy Crews |
8/30/2018 |
Passed: Building - Roof Decking |
Approved As Requested |
Troy Crews |
8/31/2018 |
Passed: Plumbing/Gas - Rain Leader |
Approved As Requested |
Troy Crews |
8/31/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
9/12/2018 |
Passed: Building - Above Ceiling |
|
Troy Crews |
9/12/2018 |
Passed: Building - Insulation |
|
Troy Crews |
9/12/2018 |
Passed: Electrical - Rough In |
Approved As Requested |
Troy Crews |
9/13/2018 |
Passed: Electrical - Above Ceiling |
Approved As Requested |
Troy Crews |
9/13/2018 |
Passed: Mechanical - Above Ceiling |
Approved As Requested |
Troy Crews |
9/13/2018 |
Passed: Mechanical - Rough In |
Approved As Requested |
Troy Crews |
9/13/2018 |
Passed: Plumbing/Gas - Water Pipe |
Approved As Requested |
Troy Crews |
9/13/2018 |
Passed: Fire - Aboveground Sprinkler - Visual (On Site) |
|
Josh Wehinger |
9/16/2018 |
Passed: Building - Rated Assembly Fastening |
Approved As Requested Zone 1 |
Troy Crews |
9/18/2018 |
Passed: Plumbing/Gas - Water Pipe |
Approved As Requested 100 P.si. |
Troy Crews |
9/20/2018 |
Passed: Building - Framing |
Nw Section |
Troy Crews |
9/21/2018 |
Passed: Building - Insulation |
Nw Section |
Troy Crews |
9/21/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
9/24/2018 |
Passed: Building - Rated Assembly Fastening |
Approved As Requested |
Troy Crews |
9/26/2018 |
Passed: Building - Rated Assembly Fastening |
Approved As Requested |
Troy Crews |
9/27/2018 |
Passed: Fire - Aboveground Sprinkler - Visual (On Site) |
|
Josh Wehinger |
9/27/2018 |
Passed: Building - Framing |
Hard Ceiling Areas |
Troy Crews |
10/3/2018 |
Passed: Building - Above Ceiling |
Hard Ceiling Areas |
Troy Crews |
10/3/2018 |
Passed: Electrical - Rough In |
Hard Ceiling Areas |
Troy Crews |
10/3/2018 |
Passed: Electrical - Above Ceiling |
Hard Ceiling Areas |
Troy Crews |
10/3/2018 |
Passed: Mechanical - Above Ceiling |
Hard Ceiling Areas |
Troy Crews |
10/3/2018 |
Passed: Plumbing/Gas - Rough In |
Hard Ceiling Areas |
Troy Crews |
10/3/2018 |
Failed: Plumbing/Gas - Water Pipe |
Leak 1st Hallway To Left From North Entrance By Bulkhead |
Troy Crews |
10/5/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
10/8/2018 |
Passed: Building - Insulation |
Approved As Requested |
Troy Crews |
10/8/2018 |
Passed: Plumbing/Gas - Rain Leader |
4 Primary’s 2 Secondary Full |
Troy Crews |
10/12/2018 |
Passed: Plumbing/Gas - Water Pipe |
90 P.si. |
Troy Crews |
10/16/2018 |
Passed: Building - Rated Assembly Fastening |
Approved As Requested |
Troy Crews |
10/18/2018 |
Passed: Building - Above Ceiling |
Patient Rooms And Center Core |
Troy Crews |
10/22/2018 |
Passed: Electrical - Rough In |
Patient Rooms And Center Core |
Troy Crews |
10/22/2018 |
Passed: Electrical - Above Ceiling |
Patient Rooms And Center Core |
Troy Crews |
10/22/2018 |
Passed: Mechanical - Above Ceiling |
Patient Rooms And Center Core |
Troy Crews |
10/22/2018 |
Passed: Mechanical - Rough In |
Patient Rooms And Center Core |
Troy Crews |
10/22/2018 |
Passed: Mechanical - Framing/Fire Damper |
Patient Rooms And Center Core |
Troy Crews |
10/22/2018 |
Passed: Plumbing/Gas - Rough In |
Patient Rooms And Center Core |
Troy Crews |
10/22/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
10/26/2018 |
Passed: Building - Insulation |
Approved As Requested |
Troy Crews |
10/26/2018 |
Passed: Building - Rated Assembly Fastening |
Approved As Requested |
Troy Crews |
10/30/2018 |
Passed: Fire - Aboveground Sprinkler - Visual (On Site) |
|
Josh Wehinger |
11/5/2018 |
Passed: Building - Framing |
Patient Rooms Hallway Not Complete |
Troy Crews |
11/7/2018 |
Passed: Building - Above Ceiling |
Patient Rooms Hallway Not Complete |
Troy Crews |
11/7/2018 |
Passed: Electrical - Rough In |
Patient Rooms Hallway Not Complete |
Troy Crews |
11/7/2018 |
Passed: Mechanical - Above Ceiling |
Patient Rooms Hallway Not Complete |
Troy Crews |
11/7/2018 |
Passed: Mechanical - Rough In |
Patient Rooms Hallway Not Complete |
Troy Crews |
11/7/2018 |
Passed: Plumbing/Gas - Rough In |
Patient Rooms Hallway Not Complete |
Troy Crews |
11/7/2018 |
Passed: Electrical - Above Ceiling |
Patient Rooms Hallway Not Complete |
Troy Crews |
11/7/2018 |
Rescheduled 11/14/2018:Plumbing/Gas - Water Pipe |
|
Troy Crews |
11/9/2018 |
Rescheduled 11/14/2018:Plumbing/Gas - Rough In |
|
Troy Crews |
11/9/2018 |
Passed: Plumbing/Gas - Water Pipe |
Approved As Requested |
Troy Crews |
11/14/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
11/14/2018 |
Passed: Building - Insulation |
Approved As Requested |
Troy Crews |
11/14/2018 |
Passed: Building - Rated Assembly Fastening |
Approved As Requested |
Troy Crews |
11/26/2018 |
Passed: Fire - Aboveground Sprinkler - Visual (On Site) |
|
Josh Wehinger |
11/30/2018 |
Passed: Building - Above Ceiling |
Kitchen Area Hard Ceiling |
Troy Crews |
11/30/2018 |
Passed: Electrical - Above Ceiling |
Kitchen Area Hard Ceiling |
Troy Crews |
11/30/2018 |
Passed: Fire - Kitchen Hood – Fire Suppression Test |
|
Josh Wehinger |
12/5/2018 |
Passed: Electrical - Permanent Power |
Temp Permanent City Sewer |
Troy Crews |
12/6/2018 |
Release to power company |
|
Troy Crews |
12/6/2018 |
Passed: Fire - Aboveground Sprinkler - Visual (On Site) |
|
Josh Wehinger |
12/10/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
12/11/2018 |
Passed: Building - Above Ceiling |
Approved As Requested |
Troy Crews |
12/11/2018 |
Passed: Electrical - Rough In |
Approved As Requested |
Troy Crews |
12/11/2018 |
Passed: Electrical - Above Ceiling |
Approved As Requested |
Troy Crews |
12/11/2018 |
Passed: Mechanical - Above Ceiling |
Approved As Requested |
Troy Crews |
12/11/2018 |
Passed: Mechanical - Rough In |
Approved As Requested |
Troy Crews |
12/11/2018 |
Passed: Plumbing/Gas - Water Pipe |
Approved As Requested |
Troy Crews |
12/11/2018 |
Passed: Building - Framing |
Approved As Requested |
Troy Crews |
12/18/2018 |
Passed: Building - Insulation |
Approved As Requested R-38 |
Troy Crews |
12/18/2018 |
Passed: Building - Rated Assembly Fastening |
Approved As Requested |
Troy Crews |
12/21/2018 |
Passed: Fire - Aboveground Sprinkler - Visual (On Site) |
|
Tad Cervantes |
1/18/2019 |
Passed: Fire - Aboveground Hydro - Sprinkler |
|
Tad Cervantes |
1/18/2019 |
Passed: Fire - Kitchen Hood – Fire Suppression Test |
Inspection Was Preformed On Friday, 1-18-19. |
Tad Cervantes |
1/22/2019 |
Passed: Building - Lath/Stucco |
Approved As Requested |
Troy Crews |
1/25/2019 |
Passed: Plumbing/Gas - Rough In |
Approved As Requested, Suggestion Let City Gas Dept. Look At It Also |
Troy Crews |
2/1/2019 |
Passed: Building - Above Ceiling |
Approved As Requested |
Troy Crews |
2/5/2019 |
Passed: Electrical - Above Ceiling |
Approved As Requested |
Troy Crews |
2/5/2019 |
Passed: Mechanical - Above Ceiling |
Approved As Requested |
Troy Crews |
2/5/2019 |
Passed: Fire - Aboveground Sprinkler - Visual (On Site) |
|
Tad Cervantes |
2/5/2019 |
Passed: Building - Above Ceiling |
Approved As Requested |
Troy Crews |
3/12/2019 |
Passed: Electrical - Above Ceiling |
Approved As Requested |
Troy Crews |
3/12/2019 |
Passed: Mechanical - Above Ceiling |
Approved As Requested |
Troy Crews |
3/12/2019 |
Passed: Building - Above Ceiling |
|
Troy Crews |
3/15/2019 |
Failed: Electrical - Above Ceiling |
Few Boxes Still Open |
Troy Crews |
3/15/2019 |
Passed: Mechanical - Above Ceiling |
|
Troy Crews |
3/15/2019 |
Passed: Building - Above Ceiling |
Approved As Requested |
Troy Crews |
4/5/2019 |
Passed: Electrical - Above Ceiling |
Approved As Requested |
Troy Crews |
4/5/2019 |
Passed: Mechanical - Above Ceiling |
Approved As Requested |
Troy Crews |
4/5/2019 |
Passed: Building - Above Ceiling |
Approved As Requested |
Troy Crews |
4/11/2019 |
Passed: Electrical - Above Ceiling |
Approved As Requested |
Troy Crews |
4/11/2019 |
Passed: Mechanical - Above Ceiling |
Approved As Requested |
Troy Crews |
4/11/2019 |
Passed: Building - Above Ceiling |
Approved As Requested |
Troy Crews |
4/16/2019 |
Passed: Electrical - Above Ceiling |
|
Troy Crews |
4/16/2019 |
Passed: Mechanical - Above Ceiling |
|
Troy Crews |
4/16/2019 |
Cancelled: Mechanical - Above Ceiling |
|
Troy Crews |
4/26/2019 |
Cancelled: Mechanical - Rough In |
|
Troy Crews |
4/26/2019 |
Cancelled: Mechanical - Pipe Pressure Test |
|
Troy Crews |
4/26/2019 |
Failed: Fire - Fire Final |
Inspection Was Not Performed On This Day. A Walk-thru With Supervisor Was Performed On Life Safety Issues That He Had. Issues Are Being Resolved And A Final Inspection Will Follow Shortly. Tjc |
Tad Cervantes |
4/29/2019 |
Passed: Fire - Kitchen Hood – Fire Suppression Test |
|
Tad Cervantes |
5/3/2019 |
Passed: Fire - Fire Final |
|
Tad Cervantes |
5/3/2019 |
Passed: Building - Final |
Rooftop Areas A.c. Units And Service Plugs |
Troy Crews |
5/9/2019 |
Passed: Building - Final |
Release Of C.o. Pending Site Final, And Final Walkthrough |
Troy Crews |
5/15/2019 |
Passed: Engineering - Zoning Final |
Meets Revisions Inspected On 5/3/19 |
Brandon Stubbs |
5/24/2019 |
