Right-of-Way Access/Driveway
Permit
| Application #: | 73253 |
| Permit #: |
000054131 |
| Related Permit: |
Mobile Home: 000054194 |
| Submitted: | Friday, September 12, 2025 |
| Issued: | Tuesday, September 23, 2025 |
| Expires: | Friday, November 7, 2025 |
| Completed: | Friday, November 7, 2025 |
| Status: |
Completed |
| Septic Release? |
N/A |
Job Details
| Finished floor requirement |
|
| Fema map number |
12023C0513C |
| Standards |

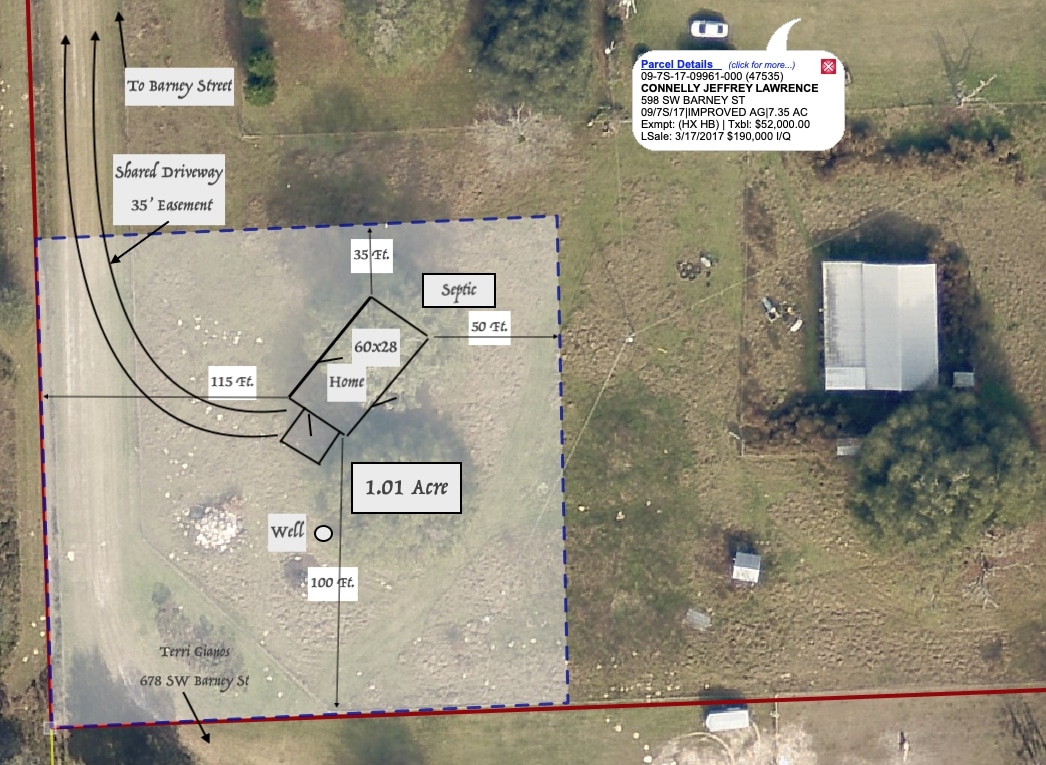

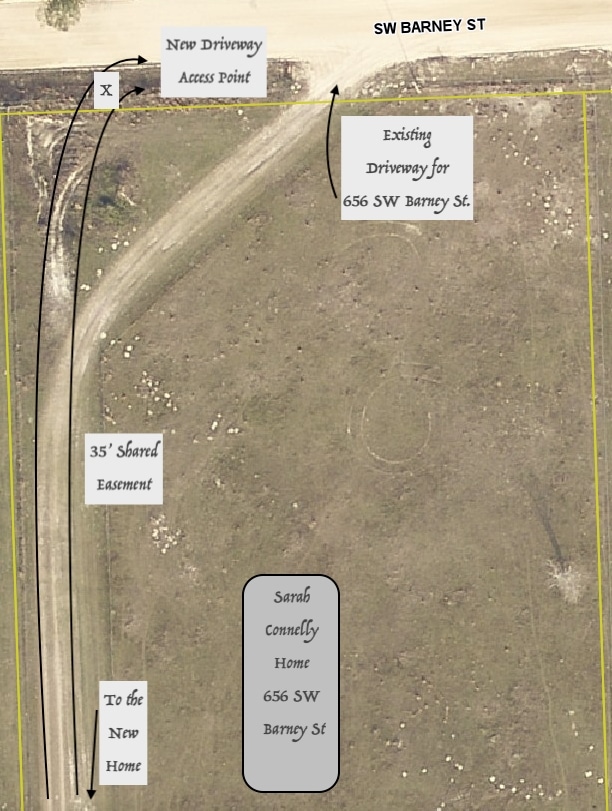

Driveway construction shall conform to the approved plan |
| Status |
Permanent |
| Type of connection for access road |
Rural Driveway |
| Type of construction of property |
Mobile Home |
| Normal vehicle usage: |
Automobiles;Trucks |
| Side Drain required |
No |
| Study Required |
No |
| Estimated Number of Vehicle trips per day |
4 |
| Is the access for commercial or residential use? |
Residential |
| County Road Type |
Unpaved |
Review Notes
| 9/12/2025 |
Application submitted by applicant. |
| 9/12/2025 |
Pending Public Works Application Approval |
| 9/12/2025 |
Final Review - Processing |
| 9/15/2025 |
Final Review - Processing |
| 9/16/2025 |
Application Approved by Public Works |
| 9/16/2025 |
Final Review - Payment Needed |
| 9/18/2025 |
Final Review - Payment Needed |
| 9/21/2025 |
Final Review - Payment Needed |
| 9/22/2025 |
Pending initial driveway inspection |
| 9/22/2025 |
Final Review - Complete |
| 9/22/2025 |
Final Review - Processing |
| 9/23/2025 |
Final Review - Processing |
| 9/23/2025 |
Permit Issued |
Contractors
| Name / Business |
License |
Title |
Role |
Inspections
| Inspection |
Notes |
Performed By |
Date |
| Passed: Engineering - Verify Easement Requirements |
|
Chad Williams |
9/12/2025 |
| Passed: Engineering - ROW Access/Driveway connects to county maintained road |
|
Chad Williams |
9/12/2025 |
| Passed: Engineering - Initial Driveway |
|
Smith, Blake |
9/23/2025 |
| Passed: Engineering - Final Driveway |
|
Beach, Garrett |
11/7/2025 |
