Inspection |
Notes |
Performed By |
Date |
Passed: Building - Footer |
|
Troy Crews |
1/3/2025 |
Passed: Engineering - Setbacks |
|
Troy Crews |
1/3/2025 |
Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Anthony Aslan |
1/21/2025 |
Passed: Building - Slab |
Emailing Initial Termite |
Anthony Aslan |
1/31/2025 |
Passed: Building - Wall Sheathing |
|
Gary Pitzer |
3/4/2025 |
Failed: Building - Ext Strapping/Wall Sheathing |
1.several Shinners Thru-out Roof Sheathing Need Removed And Possibly Renailed, 2. Post Hold Down Bracelets Have Wrong Size Nails, ( Paper Still On Nails From Gun ) And Also The Heavy Boot Style Hold Downs |
Gary Pitzer |
3/4/2025 |
Passed: Building - Framing |
Windows And Doors On Site, Not Installed |
Anthony Aslan |
3/7/2025 |
Passed: Building - Roof Decking |
|
Anthony Aslan |
3/7/2025 |
Passed: Building - Wall Sheathing |
|
Anthony Aslan |
3/7/2025 |
Passed: Electrical - Temporary Service |
|
Anthony Aslan |
3/10/2025 |
Release to power company |
|
Anthony Aslan |
3/10/2025 |
Failed: Mechanical - Rough In |
No Gasket On Supply And Return Boots
dryer Vent Not Installed |
Anthony Aslan |
4/10/2025 |
Failed: Plumbing/Gas - 2nd Rough-In |
Nail Guards Missing On Vent Stacks |
Anthony Aslan |
4/10/2025 |
Failed: Electrical - 2nd Rough-In |
Nail Guard Missing On Service Wire, Living Room Wire Not Made Up Or Stapled Off. |
Anthony Aslan |
4/10/2025 |
Cancelled: Electrical - 1st Underground Rough–In |
|
Anthony Aslan |
4/10/2025 |
Passed: Electrical - 2nd Rough-In |
|
Anthony Aslan |
4/16/2025 |

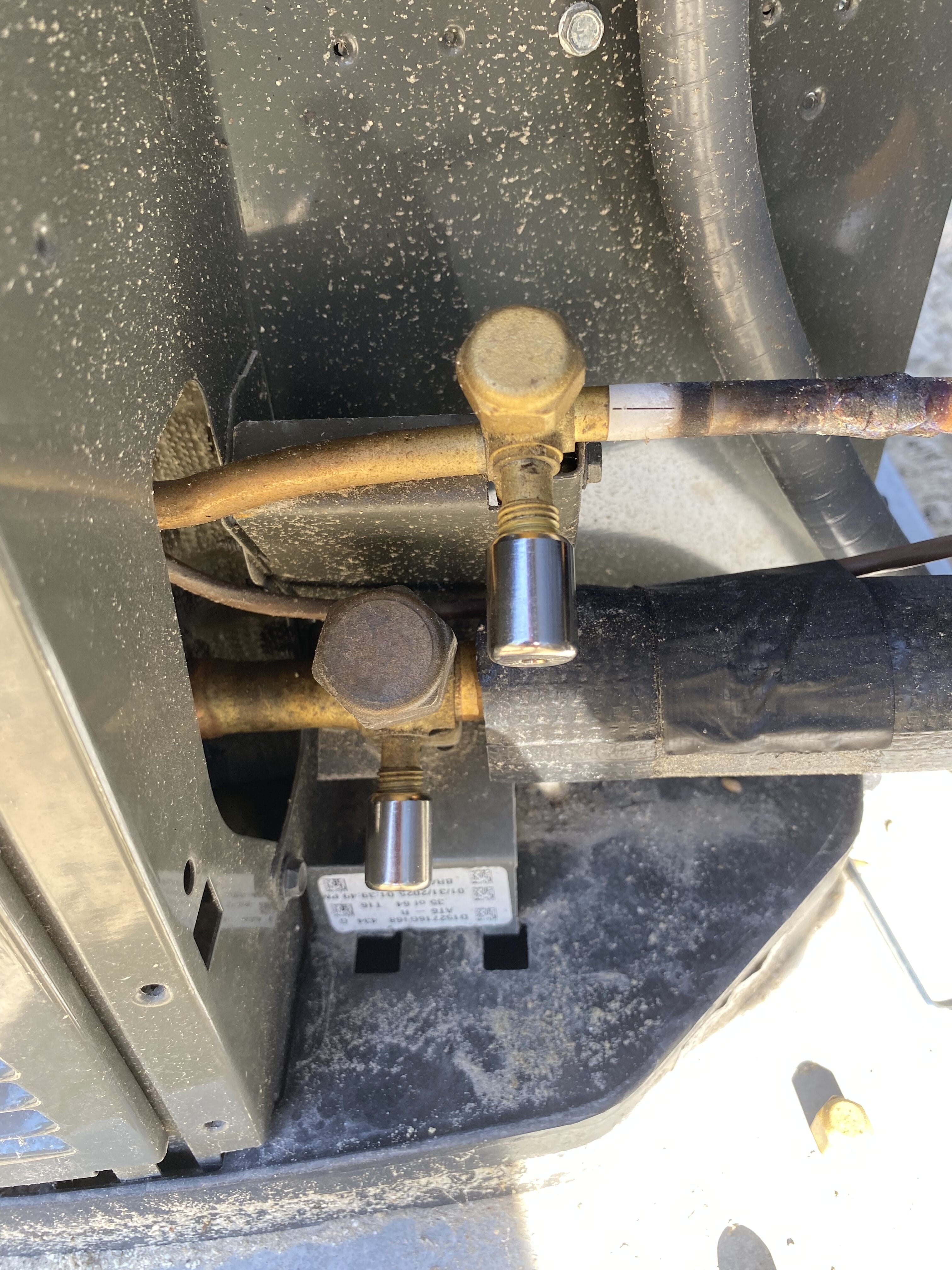

Passed: Mechanical - Rough In |
Need Pictures Of Boots Sealed To Sheet Rock Before Final |
Anthony Aslan |
4/16/2025 |
Failed: Plumbing/Gas - 2nd Rough-In |
Still Missing Nail Guards On Vent Stacks |
Anthony Aslan |
4/16/2025 |
Passed: Plumbing/Gas - 2nd Rough-In |
Corrections Made |
Anthony Aslan |
4/22/2025 |
Passed: Building - Insulation |
Walls And Ceiling Batted |
Anthony Aslan |
4/22/2025 |
Passed: Electrical - Permanent Power |
Need Septic Release |
Anthony Aslan |
8/5/2025 |
