| Inspection |
Notes |
Performed By |
Date |

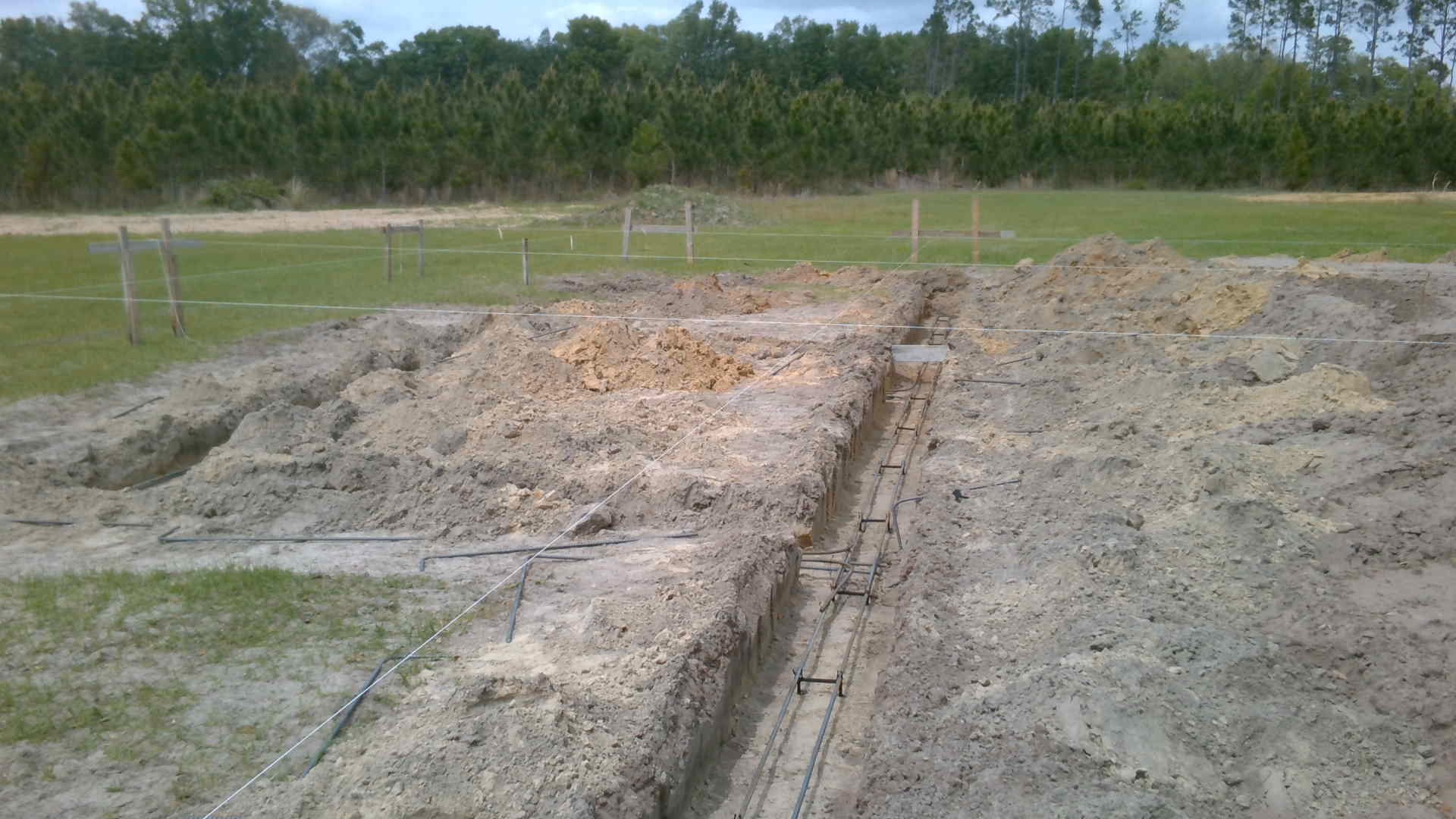

| Passed: Building - Footer |
This Will Be A Stem Wall Foundation Footing Will Be Passed Off Picture Of Grade In File |
Matt Forsyth |
4/1/2024 |
| Passed: Engineering - Setbacks |
|
Matt Forsyth |
4/1/2024 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Matt Forsyth |
4/17/2024 |
| Passed: Building - Slab |
|
Troy Crews |
4/23/2024 |
| Passed: Building - Ext Strapping/Wall Sheathing |
|
Matt Forsyth |
5/15/2024 |
| Passed: Building - Roof Decking |
|
Matt Forsyth |
5/15/2024 |
| Passed: Building - Framing |
|
Matt Forsyth |
5/15/2024 |
| Passed: Electrical - 2nd Rough-In |
Nail Plate Missing Behind Electrical Panel Box Top Plate Will Check On Insulation Inspection |
Matt Forsyth |
5/23/2024 |
| Passed: Mechanical - Rough In |
|
Matt Forsyth |
5/23/2024 |
| Passed: Plumbing/Gas - 2nd Rough-In |
Tub Water Tested For Leaks |
Matt Forsyth |
5/23/2024 |
| Passed: Building - Rated Assembly Fastening |
Make Up Air |
Matt Forsyth |
6/3/2024 |
| Passed: Building - Roof Decking |
Master Rib Metal Panels |
Matt Forsyth |
6/3/2024 |
| Cancelled: Building - Insulation |
|
Neonta Anderson |
6/5/2024 |
| Passed: Building - Insulation |
|
Matt Forsyth |
6/10/2024 |
| Passed: Electrical - Permanent Power |
Need Septic Release For Permanent Power Release |
Matt Forsyth |
8/15/2024 |
| Release to power company |
Rec'd Septic |
Emaleigh Williams |
8/20/2024 |
| Septic Release Inspection |
|
Health Dept |
8/20/2024 |
| Cancelled: Electrical - Permanent Power |
|
Troy Crews |
8/26/2024 |
| Failed: Building - Final |

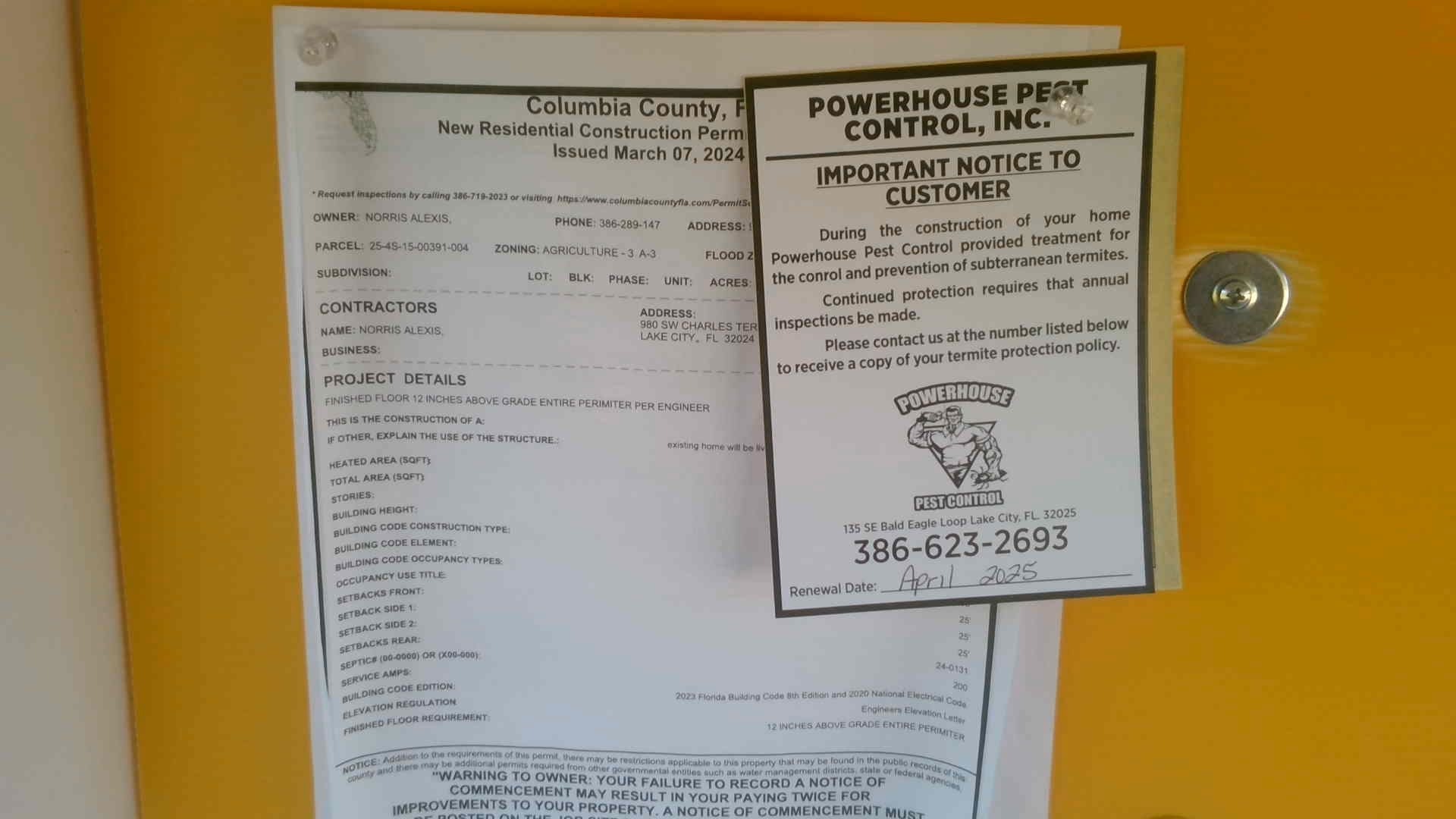

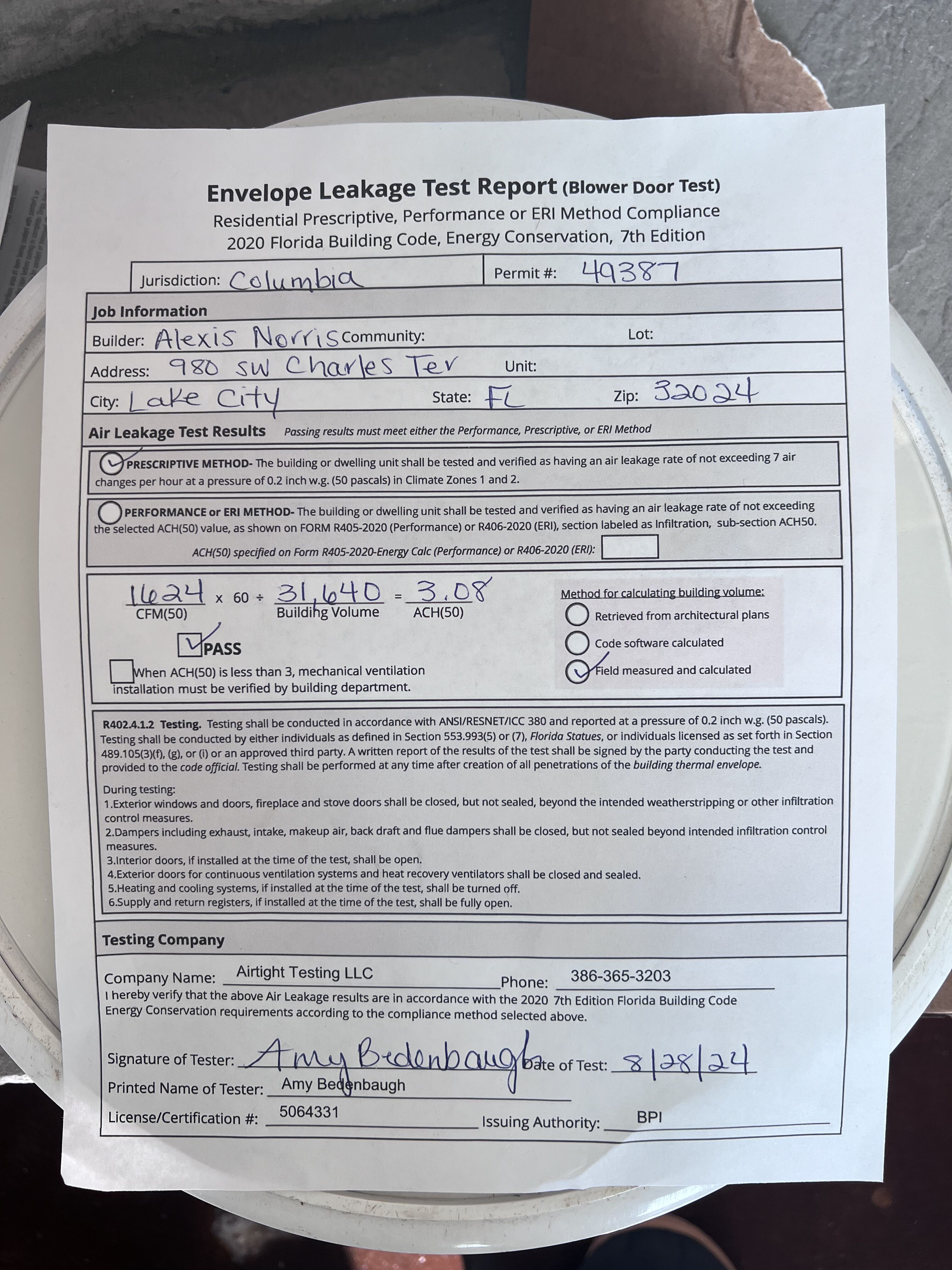

#1 Seal Floor.#2 Provide Landing At Back Door Or Step.#3 Receive And Review Blower Door Test.#4 Final Termite Treatment |
Matt Forsyth |
8/27/2024 |
| Building-Final |
|
Matt Forsyth |
9/3/2024 |
