| Inspection |
Notes |
Performed By |
Date |
| Passed: Building - Footer |
Nice Work |
Matt Forsyth |
2/27/2024 |
| Passed: Engineering - Setbacks |
|
Matt Forsyth |
2/27/2024 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
4/4/2024 |
| Failed: Building - Slab |
Missing Rebar And Corner Bar |
Matt Forsyth |
4/25/2024 |
| Passed: Building - Slab |
Items Have Been Addressed |
Matt Forsyth |
4/25/2024 |
| Passed: Building - Roof Decking |
|
Matt Forsyth |
8/16/2024 |
| Passed: Building - Wall Sheathing |
|
Matt Forsyth |
8/16/2024 |
| Rescheduled 8/19/2024:Electrical - 2nd Rough-In |
|
Matt Forsyth |
8/16/2024 |
| Rescheduled 8/19/2024:Mechanical - Rough In |
|
Matt Forsyth |
8/16/2024 |
| Rescheduled 8/19/2024:Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
8/16/2024 |
| Rescheduled 8/19/2024:Plumbing/Gas - Tub Set/Shower Pan |
|
Matt Forsyth |
8/16/2024 |
| Passed: Electrical - 2nd Rough-In |
|
Matt Forsyth |
8/19/2024 |
| Passed: Mechanical - Rough In |
|
Matt Forsyth |
8/19/2024 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
8/19/2024 |
| Passed: Plumbing/Gas - Tub Set/Shower Pan |
|
Matt Forsyth |
8/19/2024 |
| Passed: Building - Framing |
Will Need Another Inspection For Windows And Doors To Complete Envelope |
Matt Forsyth |
8/19/2024 |
| Passed: Building - Insulation |
|
Matt Forsyth |
8/30/2024 |

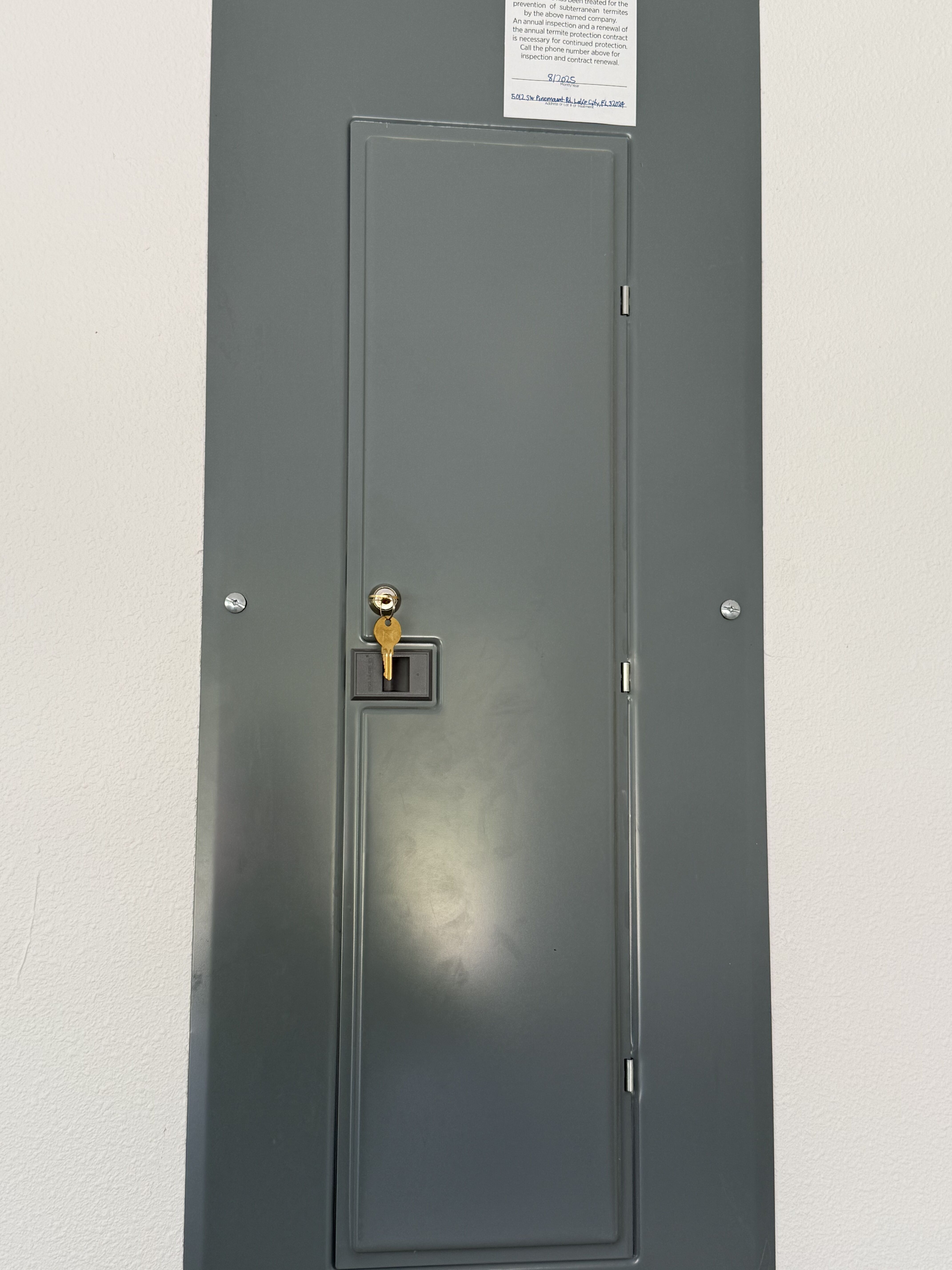

| Passed: Electrical - Permanent Power |
Septic Release Rec'd 7.15.25 - Mg |
Matt Forsyth |
7/1/2025 |
| Release to power company |
|
Mgarber |
7/15/2025 |
| Septic Release Inspection |
|
Health Dept |
7/16/2025 |
| Release to power company |
|
Ewilliams |
7/18/2025 |

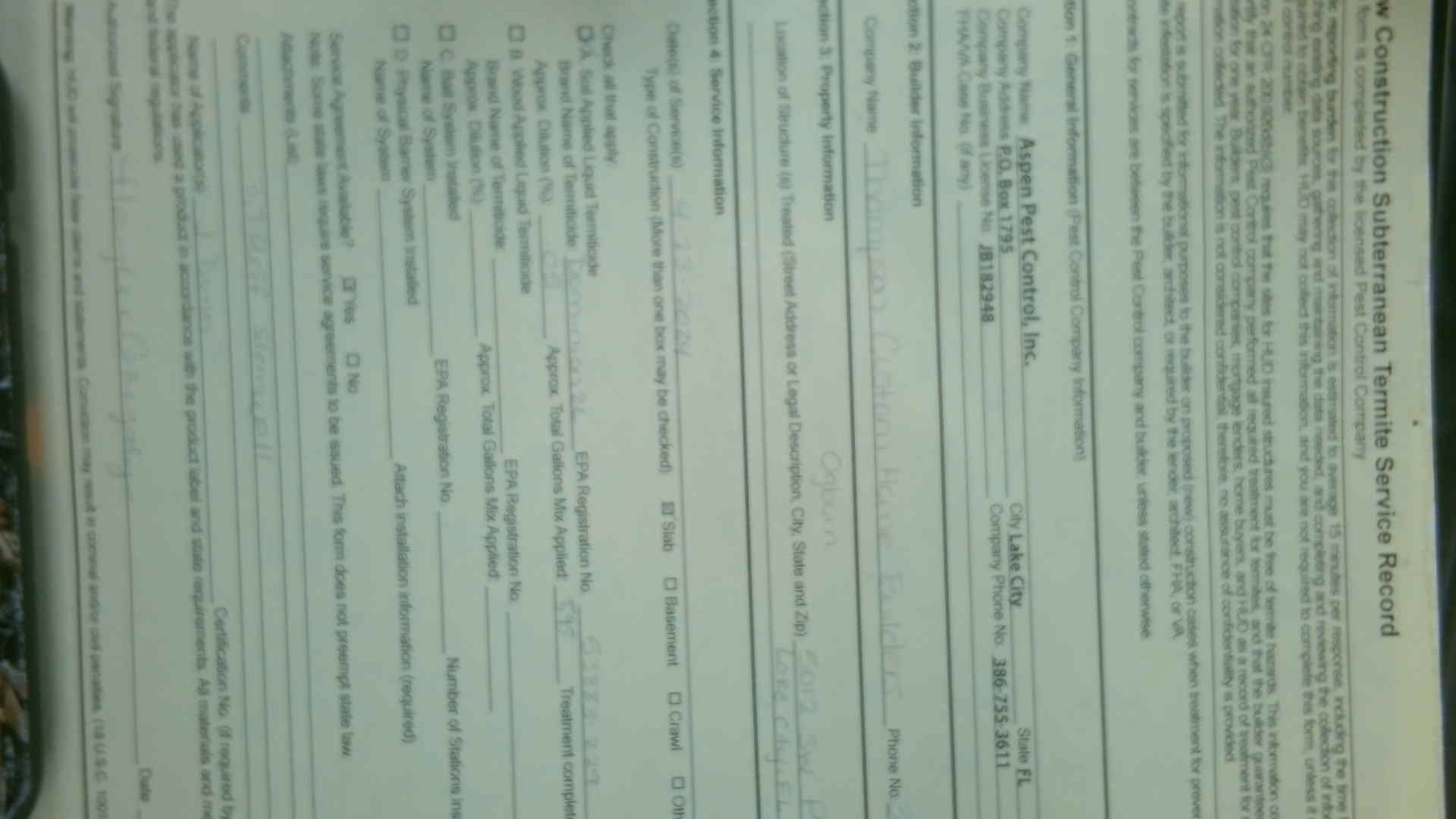

| Release to power company |
Change To Fpl |
Ewilliams |
7/18/2025 |
| Submitted Power Release through FPL Portal |
|
Ward, Emaleigh C. |
7/18/2025 |

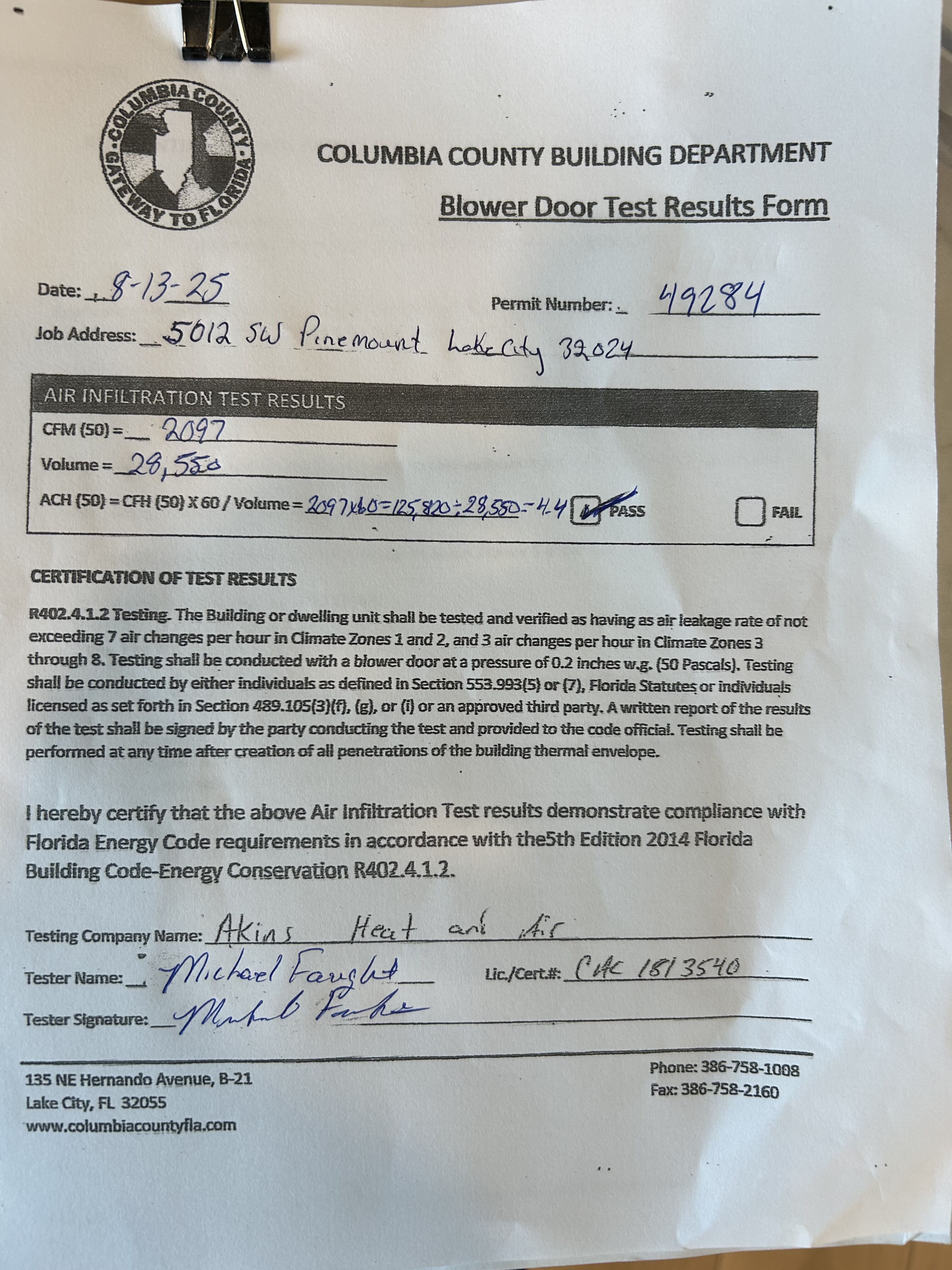

| Passed: Building - Final |
Blower Door And Termite Final Required Prior To Release Of Co |
Matt Forsyth |
8/11/2025 |
| Passed: Certificate-Release Certificate |
Rec'd Docs That Inspector Asked For - Ew |
Matt Forsyth |
8/14/2025 |
