| Inspection |
Notes |
Performed By |
Date |
| Passed: Building - Framing |
Window And Door Attachment |
Anthony Aslan |
1/30/2024 |
| Failed: Plumbing/Gas - 1st Underground Rough–In |
Waste Lines Test Not Full, Plumbing Covered And Slab Prepared Prior To Inspection. Need To Fill Test And Plumber Needs To Provide Letterhead With Signature That Plumbing Correct To Code. Also Need Compaction Test On Fill Dirt Prior To Slab. |
Troy Crews |
2/2/2024 |
| Failed: Building - Slab |

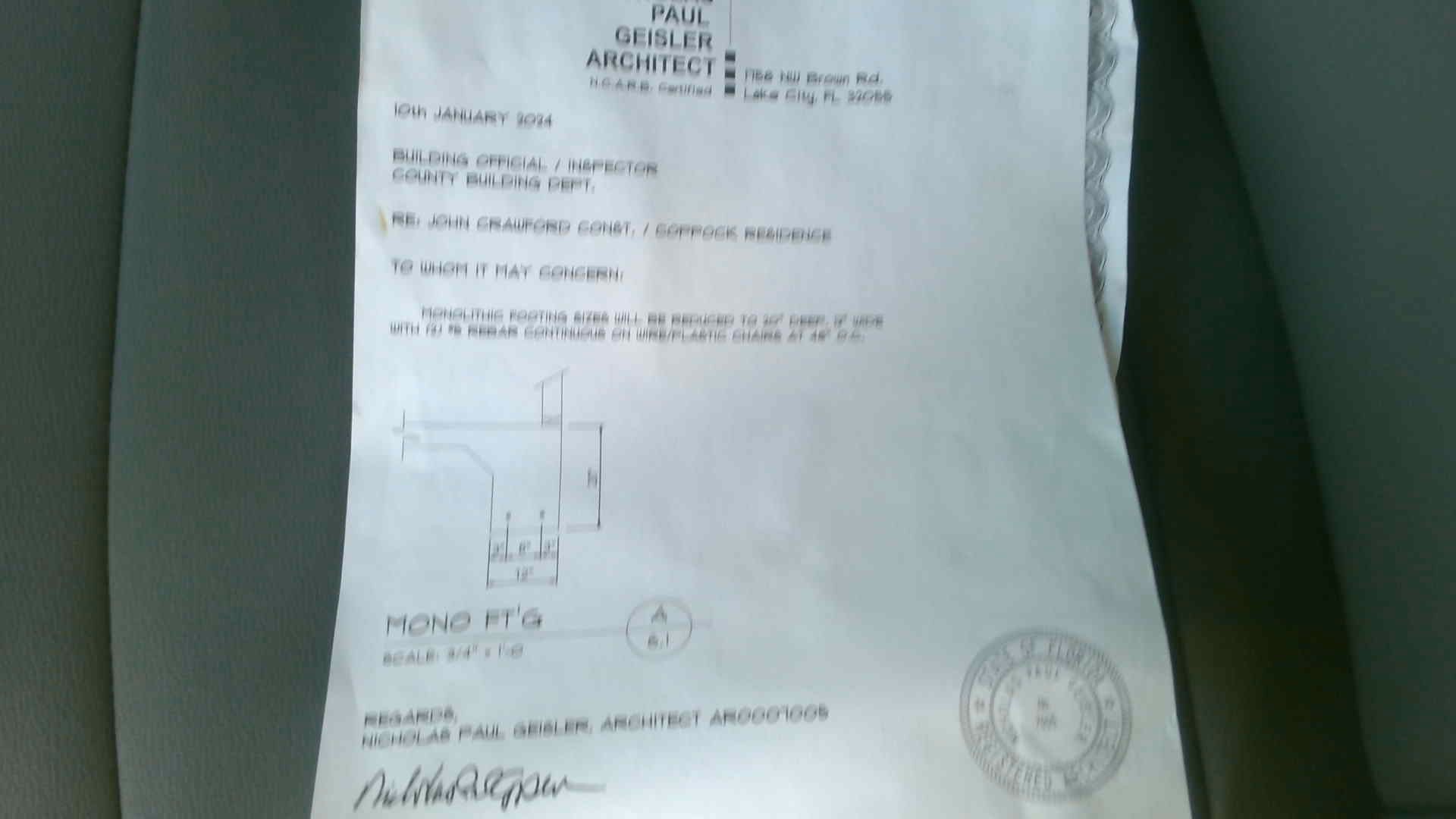

Need Compaction Test And Plumbing Inspection Satisfied Prior To Pour. |
Troy Crews |
2/5/2024 |
| Passed: Building - Slab |
|
Anthony Aslan |
2/6/2024 |
| Passed: Electrical - Temporary Service |
|
Anthony Aslan |
2/7/2024 |
| Release to power company |
|
Anthony Aslan |
2/7/2024 |
| Passed: Building - Roof Decking |
|
Anthony Aslan |
2/14/2024 |
| Passed: Building - Wall Sheathing |
|
Anthony Aslan |
2/14/2024 |
| Passed: Building - Framing |
|
Anthony Aslan |
2/28/2024 |
| Passed: Plumbing/Gas - Tub Set/Shower Pan |
Showers Have Water In Pan |
Anthony Aslan |
2/28/2024 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Anthony Aslan |
2/28/2024 |
| Passed: Mechanical - Rough In |
|
Anthony Aslan |
2/28/2024 |
| Passed: Electrical - 2nd Rough-In |
|
Anthony Aslan |
2/28/2024 |
| Passed: Building - Insulation |
Spray Foam Attic |
Anthony Aslan |
3/6/2024 |
| Passed: Electrical - Permanent Power |
Need Septic Release |
Anthony Aslan |
4/24/2024 |
| Release to power company |
Rec'd Septic |
Anthony Aslan |
5/14/2024 |
| Septic Release Inspection |
|
Health Dept |
5/14/2024 |
| Release to power company |
Releasing Power |
Neonta Anderson |
5/22/2024 |
| Passed: Building - Final |
Dryer Vent Missing Louvers |
Anthony Aslan |
7/23/2024 |
