| Inspection |
Notes |
Performed By |
Date |
| Septic Release Inspection |
|
Health Dept |
10/12/2023 |
| Passed: Engineering - Initial Driveway |
|
Smith, Blake |
11/6/2023 |
| Passed: Building - Footer |
|
Matt Forsyth |
11/14/2023 |
| Passed: Engineering - Setbacks |
|
Matt Forsyth |
11/14/2023 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Matt Forsyth |
1/3/2024 |
| Failed: Building - Slab |
Perimeter Bar Missing On Porches |
Matt Forsyth |
1/18/2024 |
| Passed: Building - Slab |
|
Matt Forsyth |
1/19/2024 |
| Passed: Building - Roof Decking |
|
Matt Forsyth |
4/10/2024 |
| Passed: Building - Wall Sheathing |
|
Matt Forsyth |
4/10/2024 |
| Failed: Building - Framing |
Threaded Rod Not Complete |
Matt Forsyth |
5/31/2024 |
| Passed: Electrical - 1st Underground Rough–In |
This Is A Second Rough Inspection |
Matt Forsyth |
5/31/2024 |
| Passed: Mechanical - Rough In |
|
Matt Forsyth |
5/31/2024 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
5/31/2024 |
| Passed: Building - Insulation |
|
Matt Forsyth |
7/1/2024 |
| Failed: Electrical - Temporary Service |
Please Call Inspection In With Explanation For Inspection For Temporary Service Job Almost Complete |
Matt Forsyth |
11/26/2024 |
| Release to power company |
|
Troy Crews |
12/5/2024 |
| Passed: Electrical - Temporary Service |
Had To Move Existing Service Will Call In Permanent Power For House When Ready |
Troy Crews |
12/5/2024 |
| Release to power company |
|
Troy Crews |
12/5/2024 |
| Failed: Engineering - Final Driveway |
Miter Ends Not Completed |
Smith, Blake |
1/28/2025 |
| Passed: Engineering - Final Driveway |
|
Smith, Blake |
1/29/2025 |
| Passed: Building - Final |

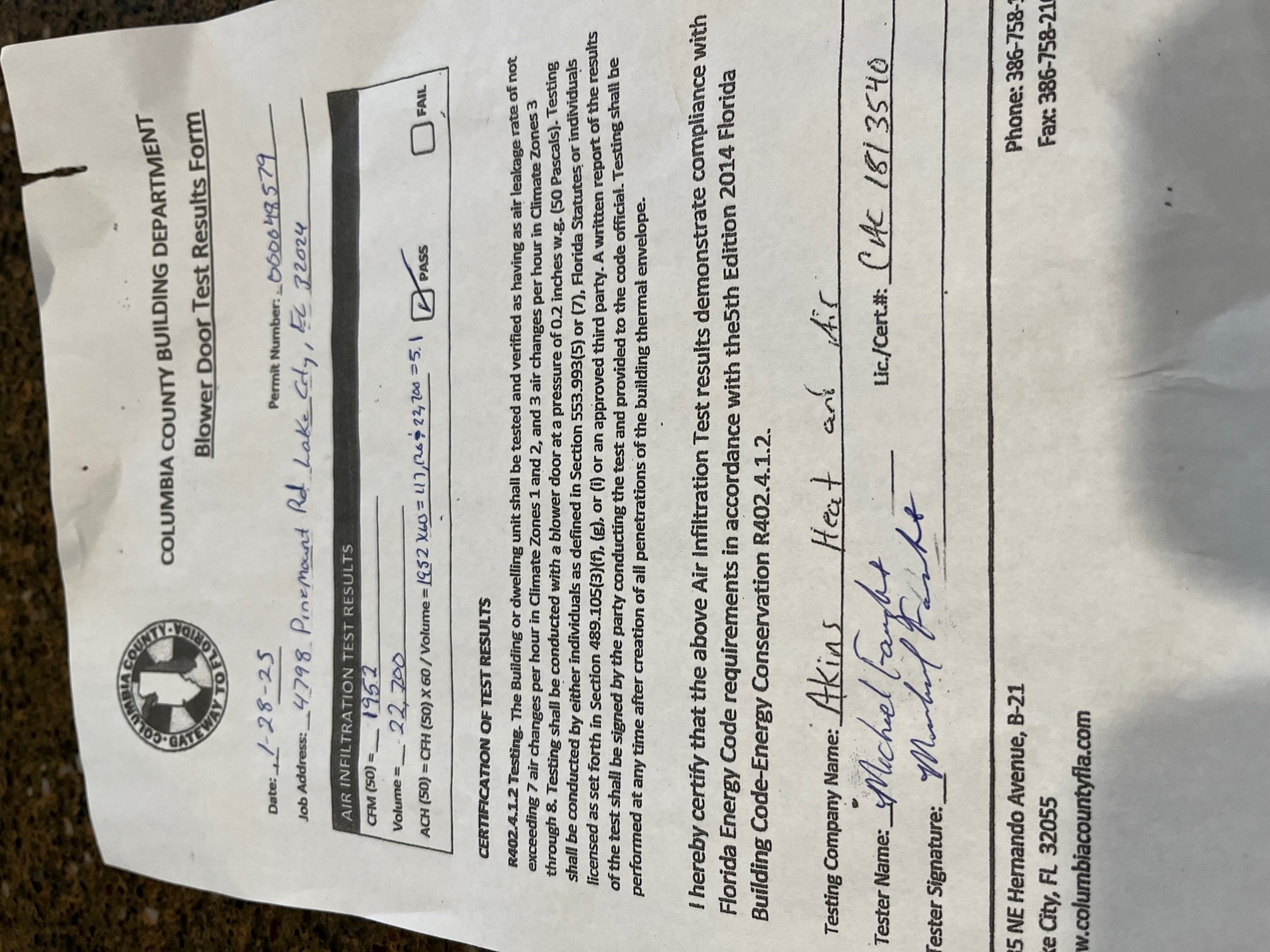

Driveway (drive Passed 1.29.25) Termite And Blower Door Test (bdt Rec'd 1.29.25) Documents Need To Be Received For Co |
Matt Forsyth |
1/29/2025 |
| Certificate-Release Certificate |
|
Matt Forsyth |
1/30/2025 |
