| Inspection |
Notes |
Performed By |
Date |
| Passed: Engineering - Initial Driveway |
|
Smith, Blake |
9/19/2023 |
| Failed: Building - Footer |
Please Have Engineer Verify That This Building Will Be Finish Floor 1 Ft Above Road. Unable To Determine This At Site |
Gary Pitzer |
9/25/2023 |
| Failed: Engineering - Setbacks |
I Did Not See Any Plot Plan Location On Site |
Gary Pitzer |
9/25/2023 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Gary Pitzer |
10/18/2023 |
| Passed: Engineering - Setbacks |
|
Gary Pitzer |
10/18/2023 |
| Passed: Building - Footer |
|
Gary Pitzer |
10/18/2023 |
| Passed: Engineering - Setbacks |
|
Gary Pitzer |
10/18/2023 |
| Passed: Building - Slab |

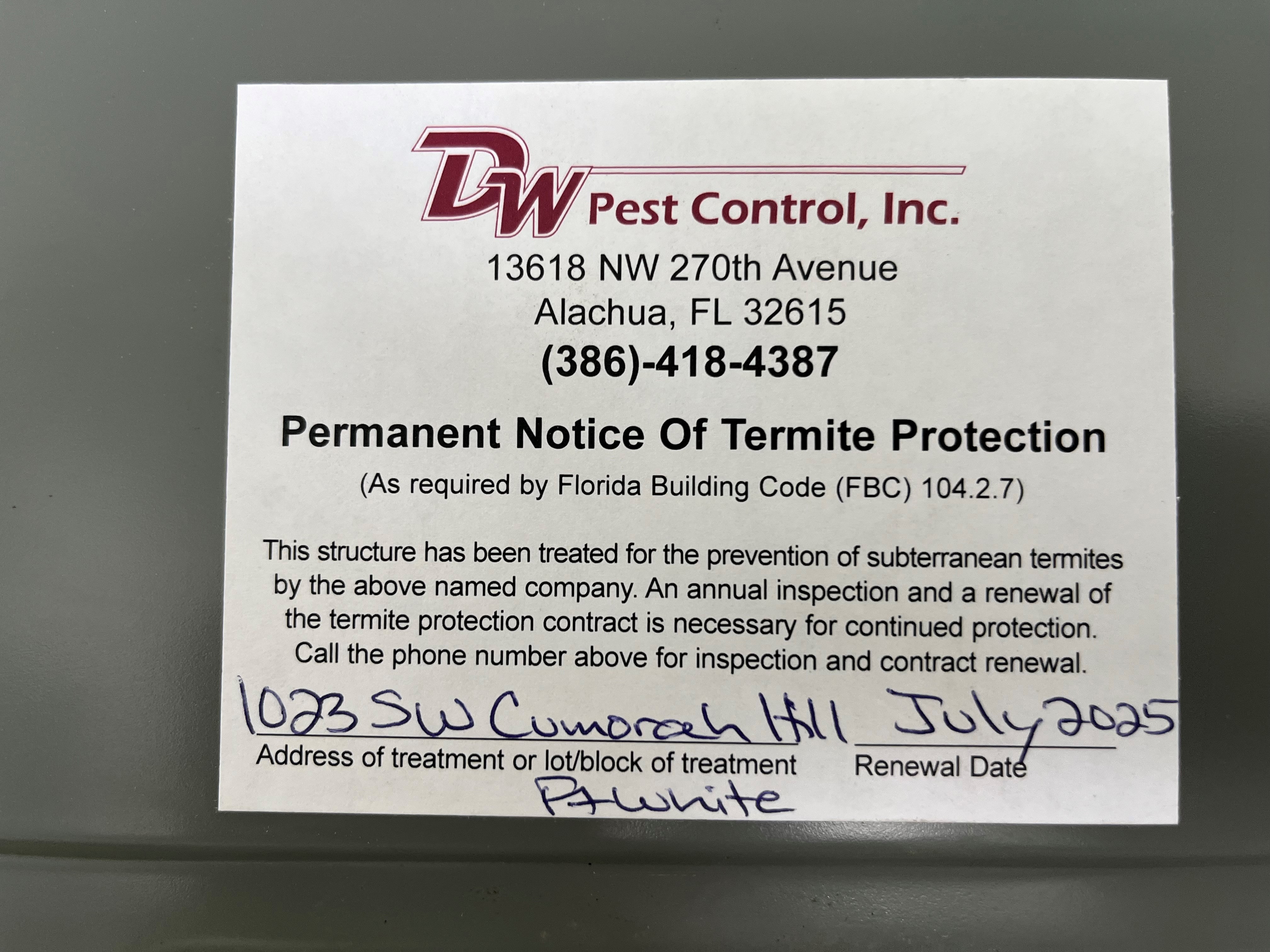

Rebar Wired, Wire, Plastic And Taped. Please Provide Termite For Underslab |
Gary Pitzer |
10/20/2023 |
| Passed: Building - Roof Decking |
|
Gary Pitzer |
12/18/2023 |
| Passed: Building - Wall Sheathing |
|
Gary Pitzer |
12/18/2023 |
| Passed: Electrical - Temporary Service |
Temp Pole |
Gary Pitzer |
1/23/2024 |
| Release to power company |
|
Gary Pitzer |
1/23/2024 |
| Passed: Building - Framing |
Partial For Porches |
Gary Pitzer |
2/1/2024 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Gary Pitzer |
3/15/2024 |
| Passed: Building - Framing |
|
Gary Pitzer |
3/15/2024 |
| Passed: Electrical - 2nd Rough-In |
|
Gary Pitzer |
3/15/2024 |
| Passed: Mechanical - Rough In |
|
Gary Pitzer |
3/15/2024 |
| Passed: Building - Insulation |
|
Gary Pitzer |
4/1/2024 |
| Passed: Electrical - Permanent Power |
400 Amp Service |
Gary Pitzer |
5/22/2024 |
| Release to power company |
|
Gary Pitzer |
5/22/2024 |
| Septic Release Inspection |
|
Health Dept |
6/18/2024 |
| Passed: Building - Final |
Need Engineer Letter For Finish Floor Elevation |
Gary Pitzer |
7/31/2024 |
