| Inspection |
Notes |
Performed By |
Date |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Anthony Aslan |
11/3/2023 |
| Cancelled: Building - Monolithic Slab |
|
Anthony Aslan |
11/13/2023 |
| Cancelled: Engineering - Setbacks |
|
Anthony Aslan |
11/13/2023 |

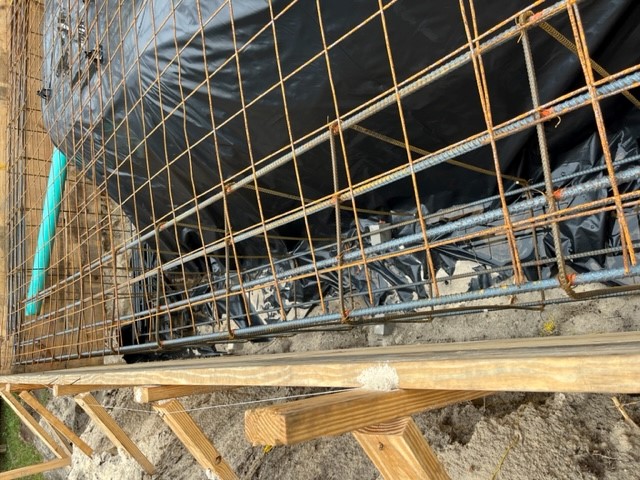

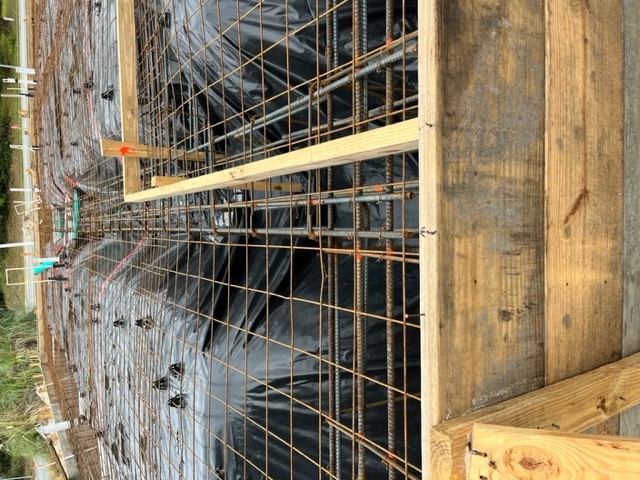

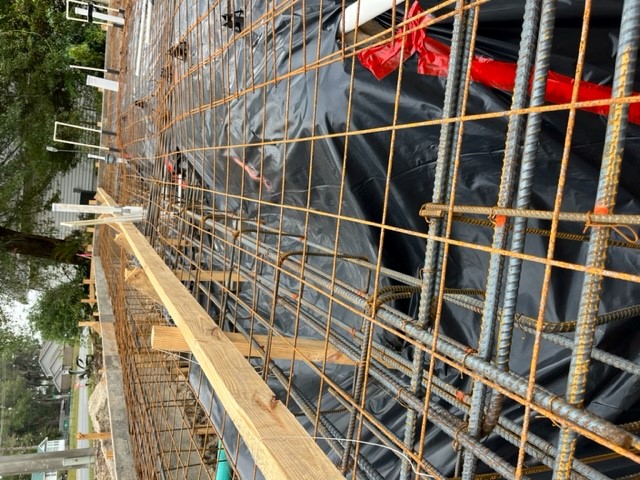

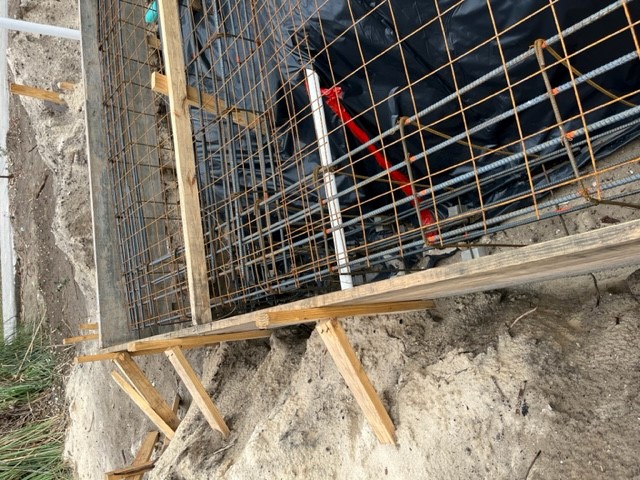

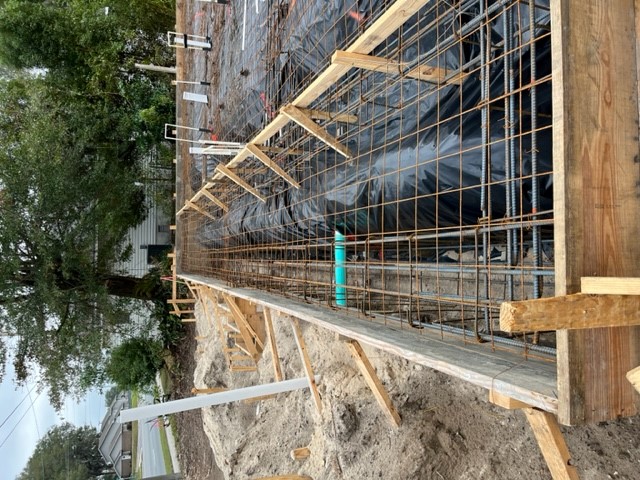

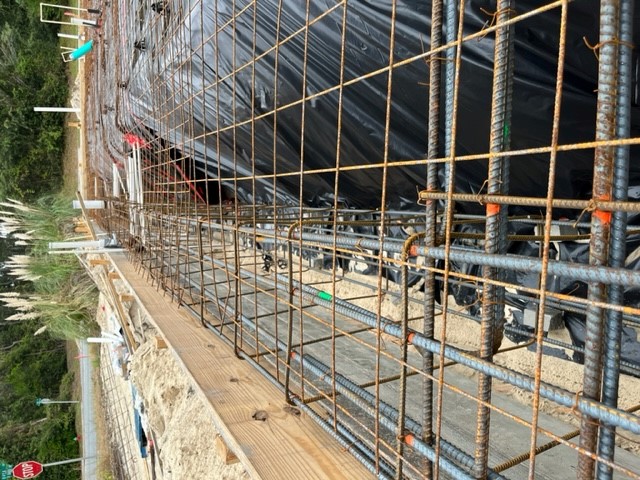

| Passed: Building - Monolithic Slab |
Rec'd Document
r318.1.8

if A Registered Termiticide Formulated And Registered As A Wood Treatment Is Used For Subterranean Termite Prevention, Sections R318.1.1 Through R318.1.6 Do Not Apply. Application Of The Wood Treatment Termiticide Shall Be As Required By Label Directions For Use, And Must Be Completed Prior To Final Building Approval. |
Anthony Aslan |
11/14/2023 |
| Passed: Engineering - Setbacks |
|
Anthony Aslan |
11/14/2023 |
| Passed: Building - Ext Strapping/Wall Sheathing |
|
Anthony Aslan |
11/27/2023 |
| Passed: Building - Roof Decking |
|
Anthony Aslan |
11/27/2023 |
| Cancelled: Building - Ext Strapping/Wall Sheathing |
|
Anthony Aslan |
11/28/2023 |
| Passed: Building - Framing |
Windows Appear To Be Not Caulked Behind Flange, Need To See Windows Taped Before Siding |
Anthony Aslan |
11/30/2023 |
| Cancelled: Mechanical - Rough In |
|
Emaleigh Williams |
12/5/2023 |
| Cancelled: Plumbing/Gas - 2nd Rough-In |
|
Emaleigh Williams |
12/5/2023 |
| Cancelled: Plumbing/Gas - Tub Set/Shower Pan |
|
Emaleigh Williams |
12/5/2023 |
| Passed: Plumbing/Gas - Tub Set/Shower Pan |
|
Anthony Aslan |
12/6/2023 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Anthony Aslan |
12/6/2023 |
| Failed: Mechanical - Rough In |
No Gaskets On Supply And Return Boots
exhaust Fan Venting Is Not Rated For Concealed Spaces
refresh Air Not Insulated |
Anthony Aslan |
12/6/2023 |
| Cancelled: Building - Insulation |
|
Neonta Anderson |
12/7/2023 |
| Passed: Electrical - 2nd Rough-In |
|
Anthony Aslan |
12/7/2023 |
| Passed: Mechanical - Rough In |
|
Anthony Aslan |
12/8/2023 |
| Passed: Building - Insulation |
Walls Only |
Anthony Aslan |
12/11/2023 |
| Failed: Electrical - Permanent Power |
Multiple Times Not Safety Off, Panel Not Made Up |
Anthony Aslan |
12/21/2023 |
| Passed: Electrical - Temporary Service |
|
Anthony Aslan |
12/26/2023 |
| Release to power company |
|
Anthony Aslan |
12/26/2023 |
| Passed: Electrical - Permanent Power |
|
Anthony Aslan |
12/27/2023 |
| Release to power company |
|
Anthony Aslan |
12/27/2023 |
| Failed: Building - Final |
No Power |
Anthony Aslan |
12/29/2023 |

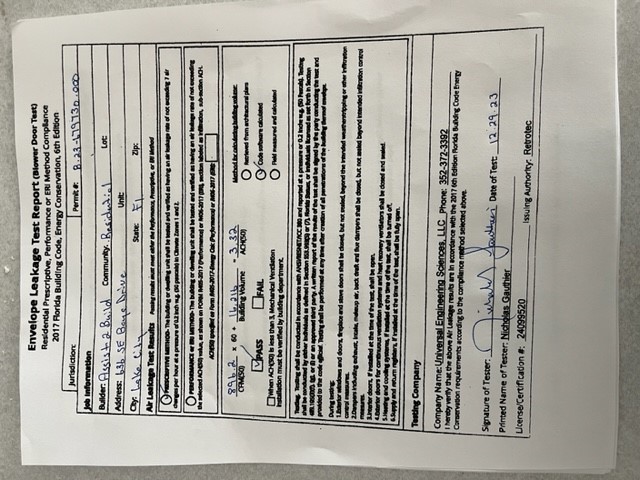

| Passed: Building - Final |
|
Anthony Aslan |
1/3/2024 |
