| Inspection |
Notes |
Performed By |
Date |
| Failed: Engineering - Final Driveway |
Needs Culvert Permit |
Smith, Blake |
11/17/2022 |
| Passed: Engineering - Initial Driveway |
|
Smith, Blake |
11/18/2022 |
| Passed: Building - Footer |
|
Troy Crews |
11/21/2022 |
| Passed: Engineering - Setbacks |
|
Troy Crews |
11/21/2022 |
| Failed: Plumbing/Gas - 1st Underground Rough–In |
Could Not Find Inspection Need Better Directions |
Matt Forsyth |
2/10/2023 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
Water Supply Under Slab Not Under Pressure |
Matt Forsyth |
2/13/2023 |
| Failed: Building - Slab |
All Block Cells To Be Filled Solid From Below Finish Floor |
Matt Forsyth |
2/28/2023 |
| Failed: Building - Masonry Wall Reinforcing |
Need Engineer Letter On Slab That Was Failed. Need Ffe Before Next Inspection |
Matt Forsyth |
3/29/2023 |
| Passed: Building - Vertical Cells/Columns |
Block Cells Not Filled Grout Below Ffe Will Need Letter From Engineer |
Matt Forsyth |
3/30/2023 |
| Passed: Building - Wall Sheathing |
|
Matt Forsyth |
4/12/2023 |
| Failed: Building - Framing |
To5 Missing Engineering |
Matt Forsyth |
6/12/2023 |
| Failed: Mechanical - Rough In |
Gasket Missing From Boots. Nail Plate Needed For Dryer Vent. Duct For Ventilation Fan Tied Up Above Ceiling |
Matt Forsyth |
6/12/2023 |
| Failed: Electrical - 2nd Rough-In |
Need Island Receptacles Roughed In , Nail Plate Needed Above Ele Panel |
Matt Forsyth |
6/14/2023 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
6/14/2023 |
| Passed: Building - Framing |
|
Matt Forsyth |
7/6/2023 |
| Passed: Electrical - 2nd Rough-In |
|
Matt Forsyth |
7/6/2023 |
| Passed: Mechanical - Rough In |
|
Matt Forsyth |
7/6/2023 |
| Passed: Building - Insulation |
|
Matt Forsyth |
7/17/2023 |
| Passed: Electrical - Temporary Service |
|
Matt Forsyth |
7/25/2023 |
| Release to power company |
|
Matt Forsyth |
7/25/2023 |
| Release to power company |
|
Melissa Garber |
8/4/2023 |
| Release to power company |
|
Melissa Garber |
8/7/2023 |
| Failed: Electrical - Permanent Power |
Ele. Panel Not Complete, Meter Can Install Not Started, Need Underground Conduit Run To Utility Connection Septic And Driveway Will Need To Be Released.to Release Power |
Matt Forsyth |
10/3/2023 |
| Passed: Electrical - Permanent Power |
Need Septic And Driveway To Release Power |
Matt Forsyth |
10/20/2023 |
| Septic Release Inspection |
Need Final Drive |
Health Dept |
11/1/2023 |
| Passed: Engineering - Final Driveway |
|
Beach, Garrett |
11/9/2023 |
| Release to power company |
|
Melissa Garber |
11/13/2023 |
| Failed: Building - Final |
Work Not Complete |
Matt Forsyth |
12/4/2023 |
| Failed: Building - Final |

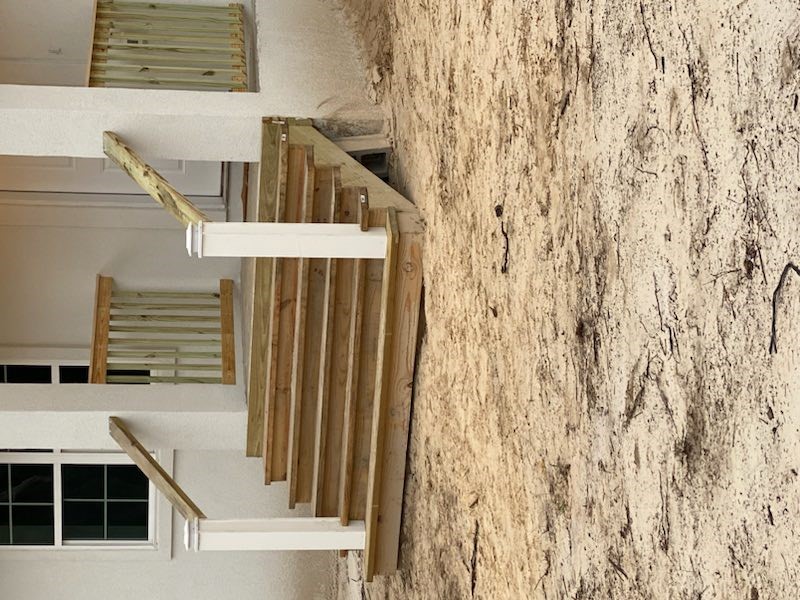

Front Porch Steps Need To Be Completed With Handrail |
Matt Forsyth |
12/7/2023 |
| Passed: Building - Final |
Item Addressed |
Matt Forsyth |
12/8/2023 |
