| Inspection |
Notes |
Performed By |
Date |
| Passed: Electrical - Temporary Service |
|
Matt Forsyth |
8/25/2022 |
| Release to power company |
|
Matt Forsyth |
8/25/2022 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |

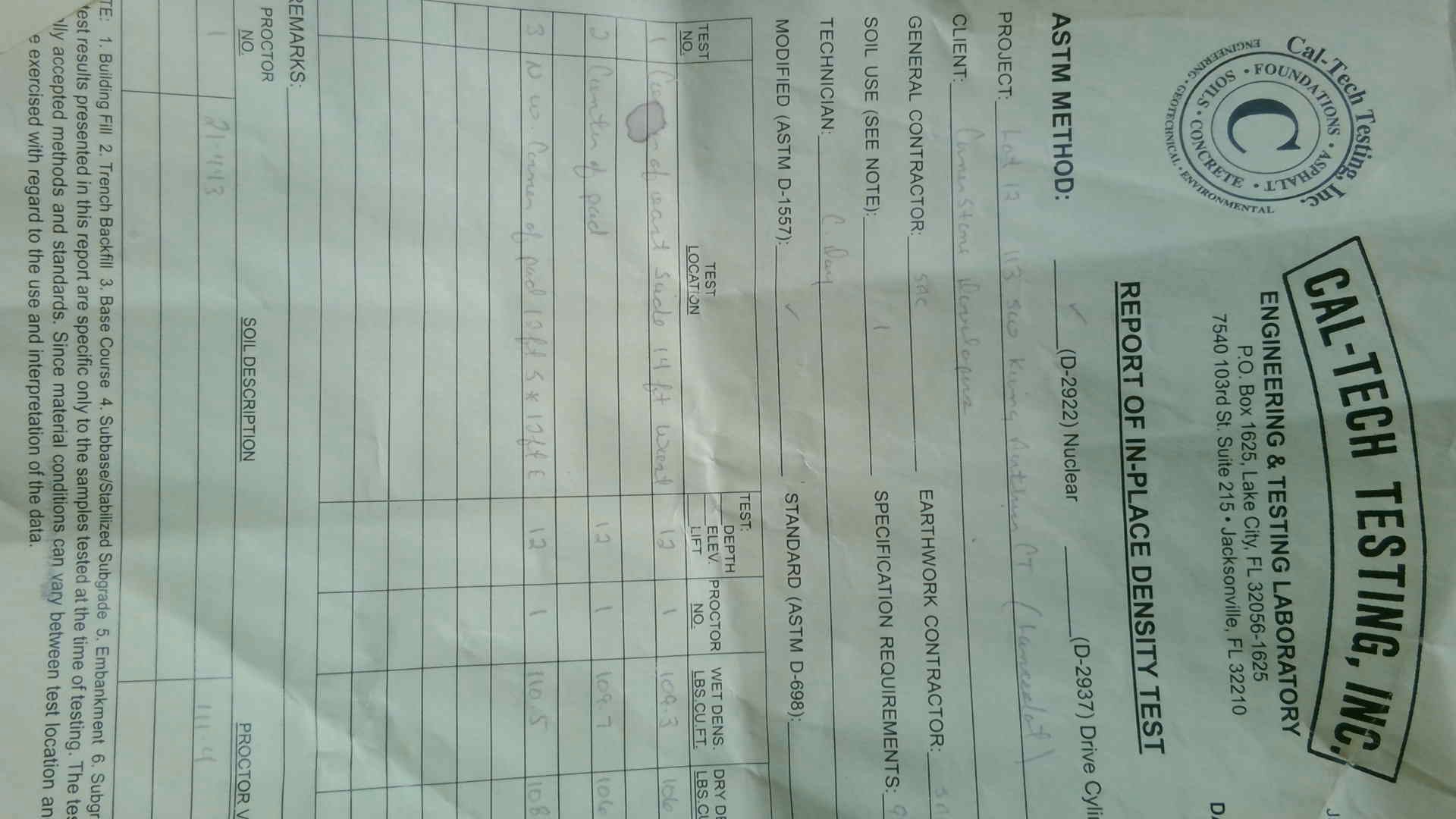

Will Need Compaction Test |
Matt Forsyth |
8/30/2022 |
| Passed: Building - Monolithic Slab |
|
Matt Forsyth |
9/21/2022 |
| Passed: Engineering - Setbacks |
|
Matt Forsyth |
9/21/2022 |
| Passed: Engineering - Initial Driveway |
|
Smith, Blake |
9/23/2022 |
| Passed: Building - Ext Strapping/Wall Sheathing |
|
Matt Forsyth |
10/6/2022 |
| Passed: Building - Roof Decking |
|
Matt Forsyth |
10/6/2022 |
| Passed: Building - Framing |
Attic Access Relocate |
Matt Forsyth |
10/14/2022 |
| Passed: Electrical - 2nd Rough-In |
|
Matt Forsyth |
10/14/2022 |
| Passed: Mechanical - Rough In |
|
Matt Forsyth |
10/14/2022 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
10/14/2022 |
| Passed: Plumbing/Gas - Tub Set/Shower Pan |
Both Tubs Water Tested |
Matt Forsyth |
10/14/2022 |
| Passed: Building - Insulation |
Walls Only |
Matt Forsyth |
10/17/2022 |
| Cancelled: Building - Insulation |
|
Matt Forsyth |
10/18/2022 |
| Passed: Electrical - Permanent Power |
Need Septic--the Final Is Waiting On Some Paperwork And A Permitting Fee That Needs To Be Completed With Regards To The Special Septic System That Was Installed. I Will Email The Agent To Notify Them-- Per Sallie Ford |
Matt Forsyth |
11/16/2022 |
| Passed: Engineering - Final Driveway |
|
Smith, Blake |
11/28/2022 |
| Release to power company |
|
Melissa Garber |
12/7/2022 |
| Septic Release Inspection |
|
Health Dept |
12/7/2022 |
| Failed: Building - Final |
Need Bdt And Final Termite Treatment Garage Recepticals On 20 Amp Breaker |
Matt Forsyth |
1/4/2023 |
| Passed: Building - Final |
|
Matt Forsyth |
1/12/2023 |
