| Inspection |
Notes |
Performed By |
Date |
| Passed: Engineering - Initial Driveway |
|
Smith, Blake |
4/5/2022 |
| Passed: Engineering - Setbacks |
|
Anthony Aslan |
4/22/2022 |
| Passed: Building - Footer |
Need Porta Potty, Permit Box |
Anthony Aslan |
4/22/2022 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Anthony Aslan |
5/25/2022 |
| Passed: Building - Slab |

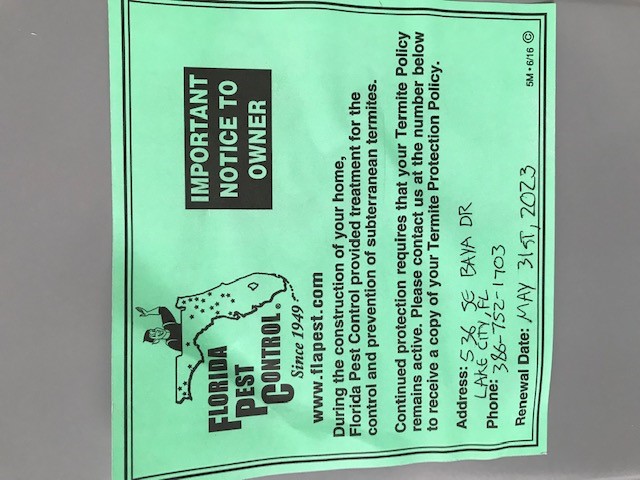

Need Termite Ticket |
Anthony Aslan |
6/1/2022 |
| Passed: Building - Roof Decking |
|
Anthony Aslan |
8/10/2022 |
| Passed: Building - Wall Sheathing |
|
Anthony Aslan |
8/10/2022 |
| Passed: Building - Ext Strapping/Wall Sheathing |
|
Anthony Aslan |
8/10/2022 |
| Passed: Building - Framing |
|
Anthony Aslan |
8/10/2022 |
| Passed: Mechanical - Rough In |
Missing Screws In Kitchen Exhaust Pipe Joints |
Anthony Aslan |
8/29/2022 |
| Passed: Plumbing/Gas - 2nd Rough-In |
Missing Nail Guards In Multiple Places |
Anthony Aslan |
8/29/2022 |
| Passed: Electrical - 2nd Rough-In |
Missing Smoke In Office And Outside Of Office |
Anthony Aslan |
8/29/2022 |
| Passed: Building - Insulation |
|
Anthony Aslan |
9/29/2022 |
| Passed: Electrical - Temporary Service |
|
Anthony Aslan |
10/21/2022 |
| Release to power company |
|
Anthony Aslan |
10/21/2022 |
| Passed: Electrical - Permanent Power |
Need Septic Release |
Anthony Aslan |
1/5/2023 |
| Septic Release Inspection |
Need Final Drive Release |
Health Dept |
1/19/2023 |
| Passed: Engineering - Final Driveway |
|
Smith, Blake |
1/26/2023 |
| Release to power company |
Received Driveway Final 1.26.23 |
Anthony Aslan |
1/30/2023 |
| Passed: Building - Final |
Blower Door Test

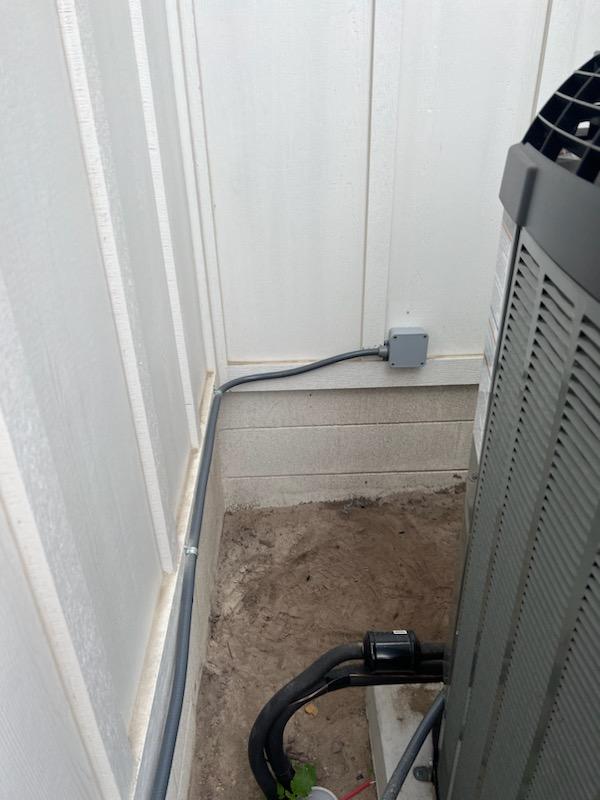

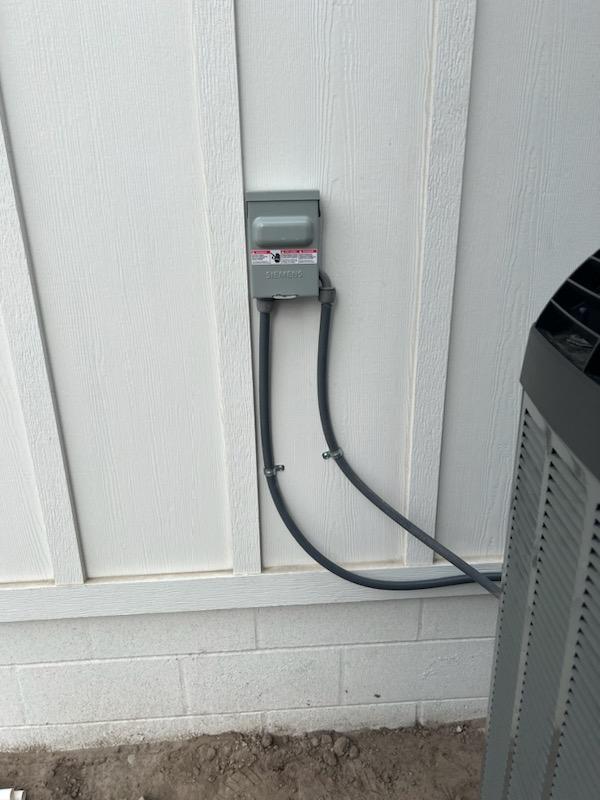

no Courtesy Outlet By Ac
|
Anthony Aslan |
2/10/2023 |
| Certificate-Release Certificate |
Recv'd Bdt |
Anthony Aslan |
2/24/2023 |
