Inspection |
Notes |
Performed By |
Date |
Passed: Engineering - Initial Driveway |
|
Smith, Blake |
2/4/2022 |
Passed: Building - Footer |
|
Matt Forsyth |
2/10/2022 |
Passed: Engineering - Setbacks |
|
Matt Forsyth |
2/10/2022 |
Passed: Electrical - Temporary Service |
|
Matt Forsyth |
2/10/2022 |
Release to power company |
|
Matt Forsyth |
2/10/2022 |
Passed: Plumbing/Gas - 1st Underground Rough–In |
Underground Waste Pipe Only |
Matt Forsyth |
2/28/2022 |
Passed: Building - Slab |
|
Matt Forsyth |
3/3/2022 |
Passed: Building - Masonry Wall Reinforcing |
|
Matt Forsyth |
4/21/2022 |
Passed: Building - Framing |
|
Matt Forsyth |
8/10/2022 |
Passed: Electrical - 1st Underground Rough–In |
2nd Rough |
Matt Forsyth |
8/10/2022 |
Failed: Mechanical - Rough In |
Need Gasket On All Boots |
Matt Forsyth |
8/10/2022 |
Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
8/10/2022 |
Passed: Plumbing/Gas - Tub Set/Shower Pan |
Below Floor Level (drain) |
Matt Forsyth |
8/10/2022 |
Passed: Building - Insulation |
|
Matt Forsyth |
9/2/2022 |
Passed: Mechanical - Rough In |
|
Matt Forsyth |
9/2/2022 |
Failed: Electrical - Permanent Power |
Conduit Not Run For Service Entrance Conductors Need Septic Release |
Matt Forsyth |
11/14/2022 |
Passed: Electrical - Permanent Power |
Need Septic Released |
Matt Forsyth |
11/28/2022 |
Release to power company |
Received Correct Septic Number From Eh 12.5.22
wrong Number Was Given On 12.2.22 |
Matt Forsyth |
12/5/2022 |
Septic Release Inspection |
|
Health Dept |
12/6/2022 |
Failed: Building - Final |

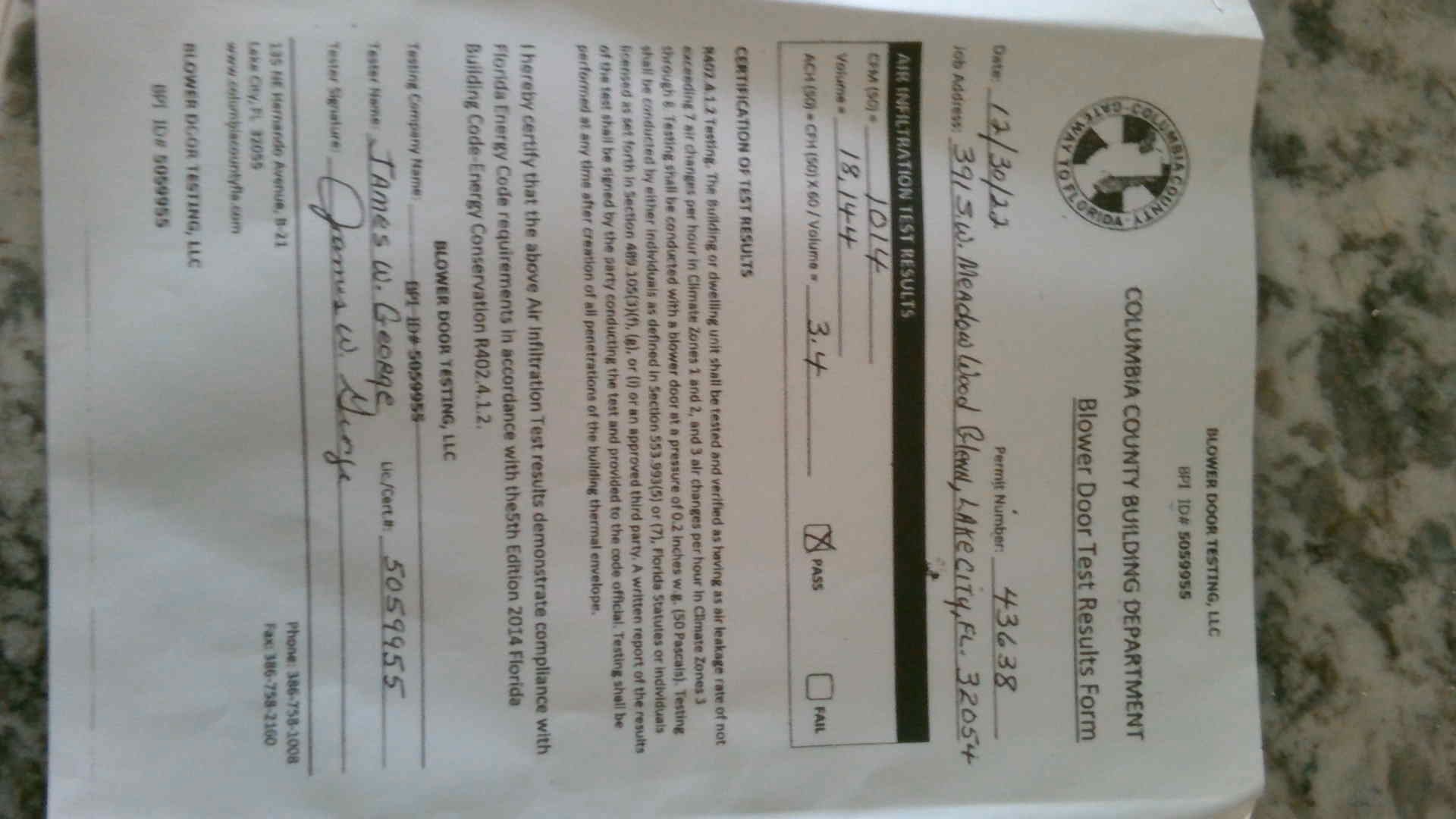

Project Not Complete No Blower Door Test No Final Termite Treatment Did Not Inspect Anything Else |
Matt Forsyth |
12/29/2022 |
Passed: Building - Final |
Need Driveway Release To Complete Permit |
Matt Forsyth |
1/3/2023 |
Certificate-Release Certificate |
|
Matt Forsyth |
1/4/2023 |
Passed: Engineering - Final Driveway |
|
Smith, Blake |
1/4/2023 |
