| Inspection |
Notes |
Performed By |
Date |
| Passed: Engineering - Initial Driveway |
|
Smith, Blake |
12/9/2021 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Matt Forsyth |
4/6/2022 |
| Failed: Building - Monolithic Slab |
Not Complete |
Matt Forsyth |
4/14/2022 |
| Passed: Engineering - Setbacks |
|
Matt Forsyth |
4/14/2022 |
| Passed: Electrical - 1st Underground Rough–In |
|
Matt Forsyth |
4/14/2022 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Matt Forsyth |
4/14/2022 |
| Passed: Building - Monolithic Slab |
|
Matt Forsyth |
4/18/2022 |
| Passed: Engineering - Setbacks |
|
Matt Forsyth |
4/18/2022 |
| Passed: Building - Roof Decking |
|
Matt Forsyth |
5/11/2022 |
| Passed: Building - Wall Sheathing |
|
Matt Forsyth |
5/11/2022 |
| Passed: Electrical - 2nd Rough-In |
|
Matt Forsyth |
5/11/2022 |
| Passed: Mechanical - Rough In |
|
Matt Forsyth |
5/11/2022 |
| Passed: Plumbing/Gas - Tub Set/Shower Pan |
|
Matt Forsyth |
5/11/2022 |
| Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
5/11/2022 |
| Passed: Building - Framing |
|
Matt Forsyth |
5/12/2022 |
| Passed: Electrical - Temporary Service |
|
Matt Forsyth |
5/13/2022 |
| Release to power company |
|
Matt Forsyth |
5/13/2022 |
| Passed: Building - Insulation |
Need Exterior Doors Installed Before Drywall |
Matt Forsyth |
5/17/2022 |
| Cancelled: Engineering - Initial Driveway |
|
Melissa Garber |
6/10/2022 |
| Passed: Engineering - Final Driveway |
|
Smith, Blake |
6/13/2022 |
| Passed: Electrical - Permanent Power |
Need Septic |
Matt Forsyth |
6/29/2022 |
| Release to power company |
|
Melissa Garber |
7/1/2022 |
| Septic Release Inspection |
|
Health Dept |
7/1/2022 |

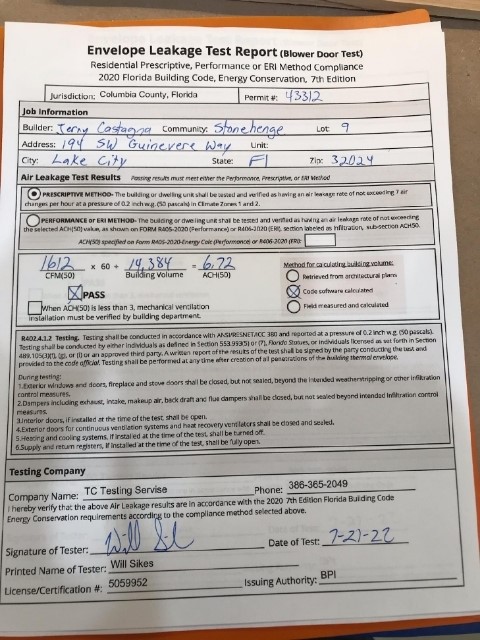

| Failed: Building - Final |
Kitchen Gfci's Not Working, Bath Gfci's Not Working, Need Blower Door, No Water On Fixtures. |
Anthony Aslan |
7/20/2022 |
| Passed: Building - Final |
|
Matt Forsyth |
7/25/2022 |
