8/26/2021
|
Application pending.
|
8/26/2021
|
Point Review - Printed-Online Application
CORRECTIONS NEEDED:
*APPLICANT INFO MUST BE INSTALLER OR WHOMEVER THE INSTALLER HAS AUTHORIZED TO PULL PERMITS ON THEIR BEHALF
*CORPORATION DETAILS
*LANDOWNER AFFIDAVIT ALLOWING PRESHER TO PUT MH ON PROPERTY
*SITE PLAN NEEDS AT LEAST ONE SIDE SETBACK DISTANCE TO THE PROPERTY LINE SHOWING WHERE THE ACRE IS CUT OUT
*ENV HEALTH SIGNED SITE PLAN APPROVAL
|
8/26/2021
|
Point Review - Email Sent
CORRECTIONS NEEDED:
*APPLICANT INFO MUST BE INSTALLER OR WHOMEVER THE INSTALLER HAS AUTHORIZED TO PULL PERMITS ON THEIR BEHALF
*CORPORATION DETAILS
*LANDOWNER AFFIDAVIT ALLOWING PRESHER TO PUT MH ON PROPERTY
*SITE PLAN NEEDS AT LEAST ONE SIDE SETBACK DISTANCE TO THE PROPERTY LINE SHOWING WHERE THE ACRE IS CUT OUT
*ENV HEALTH SIGNED SITE PLAN APPROVAL
|
8/26/2021
|
Point Review - Reviewed
CORRECTIONS NEEDED:
*APPLICANT INFO MUST BE INSTALLER OR WHOMEVER THE INSTALLER HAS AUTHORIZED TO PULL PERMITS ON THEIR BEHALF
*CORPORATION DETAILS
*LANDOWNER AFFIDAVIT ALLOWING PRESHER TO PUT MH ON PROPERTY
*SITE PLAN NEEDS AT LEAST ONE SIDE SETBACK DISTANCE TO THE PROPERTY LINE SHOWING WHERE THE ACRE IS CUT OUT
*ENV HEALTH SIGNED SITE PLAN APPROVAL
|
8/26/2021
|
Point Review - Reviewed
NEEDED:
*SITE PLAN NEEDS AT LEAST ONE SIDE SETBACK DISTANCE TO THE PROPERTY LINE SHOWING WHERE THE ACRE IS CUT OUT
*ENV HEALTH SIGNED SITE PLAN APPROVAL
|
8/30/2021
|
Plan Review - Reviewed
*ENV HEALTH SIGNED SITE PLAN APPROVAL
|
9/13/2021
|
Zoning Review - Corrections Needed
*ENV HEALTH SIGNED SITE PLAN APPROVAL
*NEED AT LEAST ONE MEASUREMENT TO DETERMINE WHERE EXACTLY THE ONE ACRE WAS TAKEN OUT OF PARCEL FOR SITE PLAN.
|
9/21/2021
|
Point Review - Reviewed
*NEED AT LEAST ONE MEASUREMENT TO DETERMINE WHERE EXACTLY THE ONE ACRE WAS TAKEN OUT OF PARCEL FOR SITE PLAN.
|
9/21/2021
|
Point Review - Reviewed
*NEED AT LEAST ONE MEASUREMENT TO DETERMINE WHERE EXACTLY THE ONE ACRE WAS TAKEN OUT OF PARCEL FOR SITE PLAN.
|
9/21/2021
|
Zoning Review - Reviewed
THERE IS A SIGNIFICANT DIFFERENCE IN THE ELEVATION AT THE ROAD AND THE ELEVATION AT THE SITE FOR THE HOME. IF THE MINIMUM FLOOR ELEVATION REQUIREMENT CANNOT BE MET THEN AN ENGINEER LETTER WILL BE REQUIRED.
|
9/21/2021
|
Final Review - Reviewed
THERE IS A SIGNIFICANT DIFFERENCE IN THE ELEVATION AT THE ROAD AND THE ELEVATION AT THE SITE FOR THE HOME. IF THE MINIMUM FLOOR ELEVATION REQUIREMENT CANNOT BE MET THEN AN ENGINEER LETTER WILL BE REQUIRED.
|
9/21/2021
|
Final Review - Payment Needed
THERE IS A SIGNIFICANT DIFFERENCE IN THE ELEVATION AT THE ROAD AND THE ELEVATION AT THE SITE FOR THE HOME. IF THE MINIMUM FLOOR ELEVATION REQUIREMENT CANNOT BE MET THEN AN ENGINEER LETTER WILL BE REQUIRED.
|
9/21/2021
|

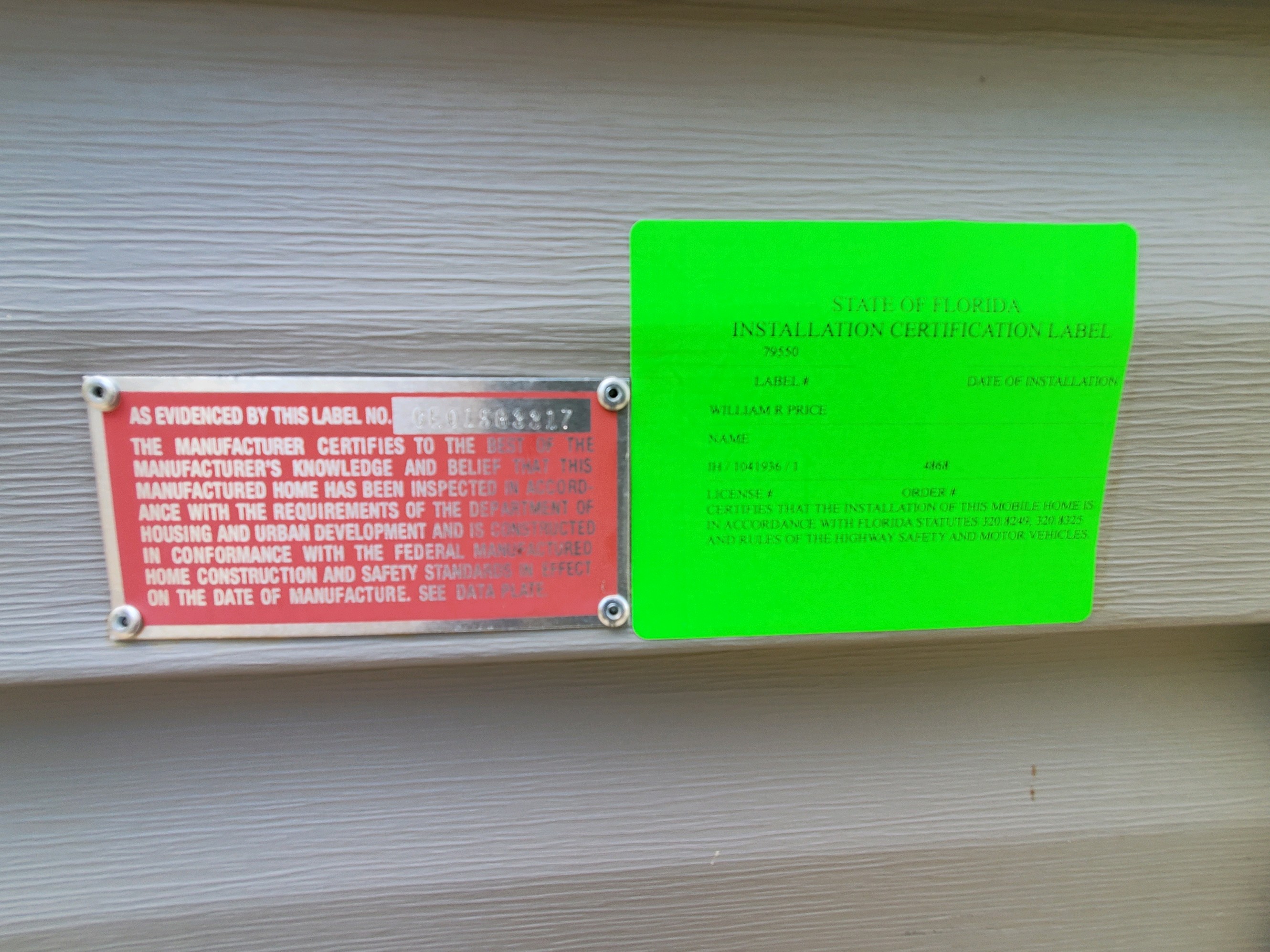

Permit Issued
Permit #000042798 created and approved.
|
12/8/2021
|
Permit reissued to reflect updated information.
|
