Inspection |
Notes |
Performed By |
Date |
Passed: Engineering - Initial Driveway |
|
Mccormick, David |
5/21/2021 |
Passed: Electrical - Temporary Service |
|
Matt Forsyth |
5/24/2021 |
Release to power company |
|
Matt Forsyth |
5/24/2021 |
Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Troy Crews |
6/25/2021 |
Failed: Building - Footer |
Plumbing Vent Stacks Need To Have Clearance From Form Boards For Concrete Cover. |
Matt Forsyth |
7/8/2021 |
Passed: Engineering - Setbacks |
|
Matt Forsyth |
7/8/2021 |
Passed: Building - Monolithic Slab |
Pictures Sent By Plumber |
Troy Crews |
7/8/2021 |
Passed: Engineering - Setbacks |
|
Troy Crews |
7/8/2021 |
Passed: Building - Roof Decking |
|
Matt Forsyth |
8/10/2021 |
Passed: Building - Wall Sheathing |
|
Matt Forsyth |
8/10/2021 |
Passed: Building - Framing |
|
Matt Forsyth |
9/13/2021 |
Passed: Electrical - 2nd Rough-In |
|
Matt Forsyth |
9/13/2021 |
Passed: Plumbing/Gas - 2nd Rough-In |
|
Matt Forsyth |
9/13/2021 |
Passed: Plumbing/Gas - Tub Set/Shower Pan |
|
Matt Forsyth |
9/13/2021 |
Failed: Mechanical - Rough In |
Need More Clearance Around Plenum |
Matt Forsyth |
9/13/2021 |
Passed: Building - Insulation |
|
Matt Forsyth |
9/21/2021 |
Cancelled: Electrical - 2nd Rough-In |
|
Troy Crews |
2/1/2022 |
Cancelled: Electrical - 1st Underground Rough–In |
|
Troy Crews |
2/1/2022 |
Failed: Electrical - Permanent Power |
House Locked, Need Septic And Driveway Releases |
Anthony Aslan |
2/2/2022 |
Passed: Engineering - Final Driveway |
|
Smith, Blake |
2/7/2022 |
Septic Release Inspection |
|
Health Dept |
2/22/2022 |
Passed: Electrical - Permanent Power |
|
Matt Forsyth |
2/24/2022 |
Release to power company |
|
Matt Forsyth |
2/24/2022 |
Failed: Building - Final |

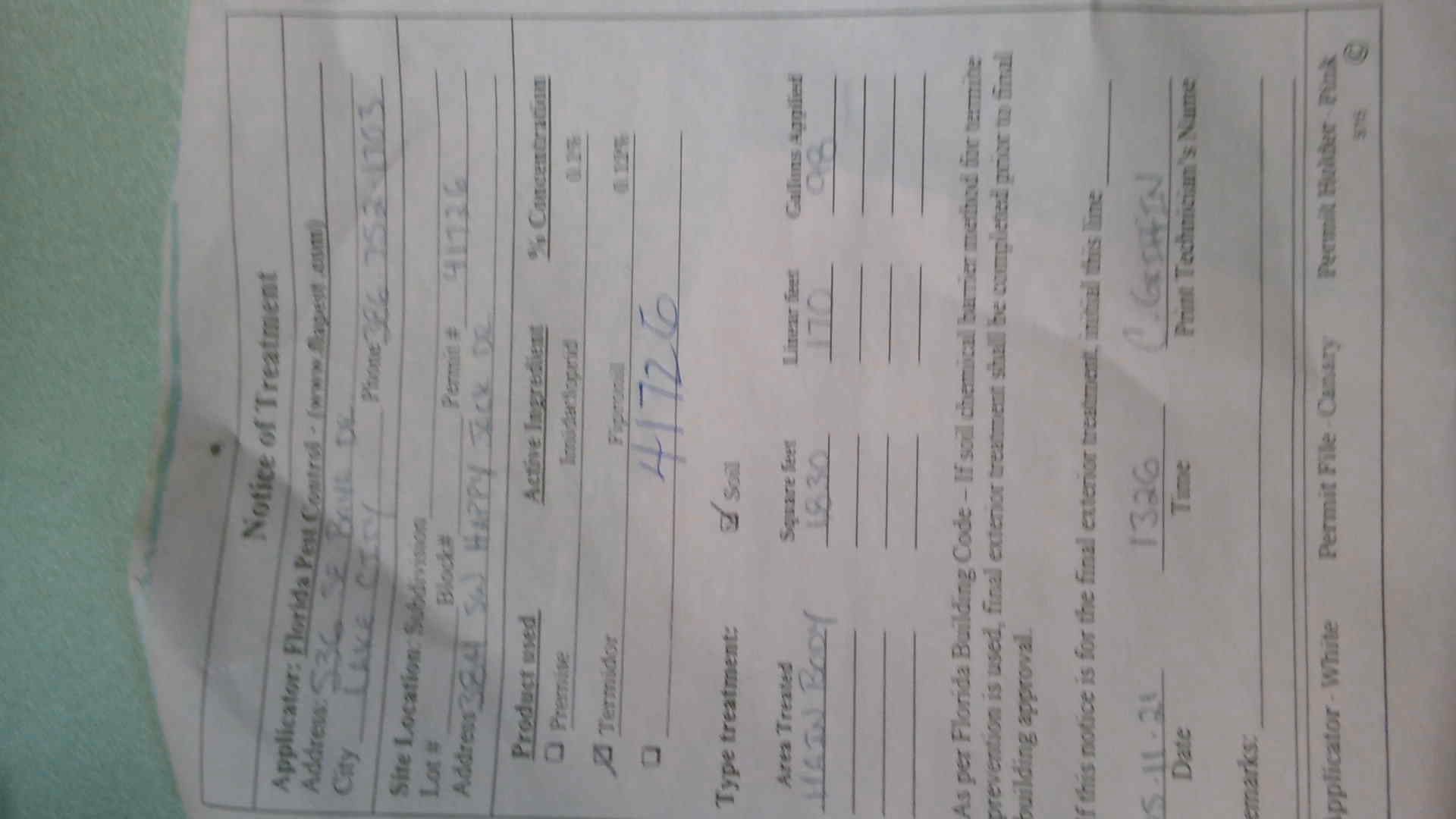

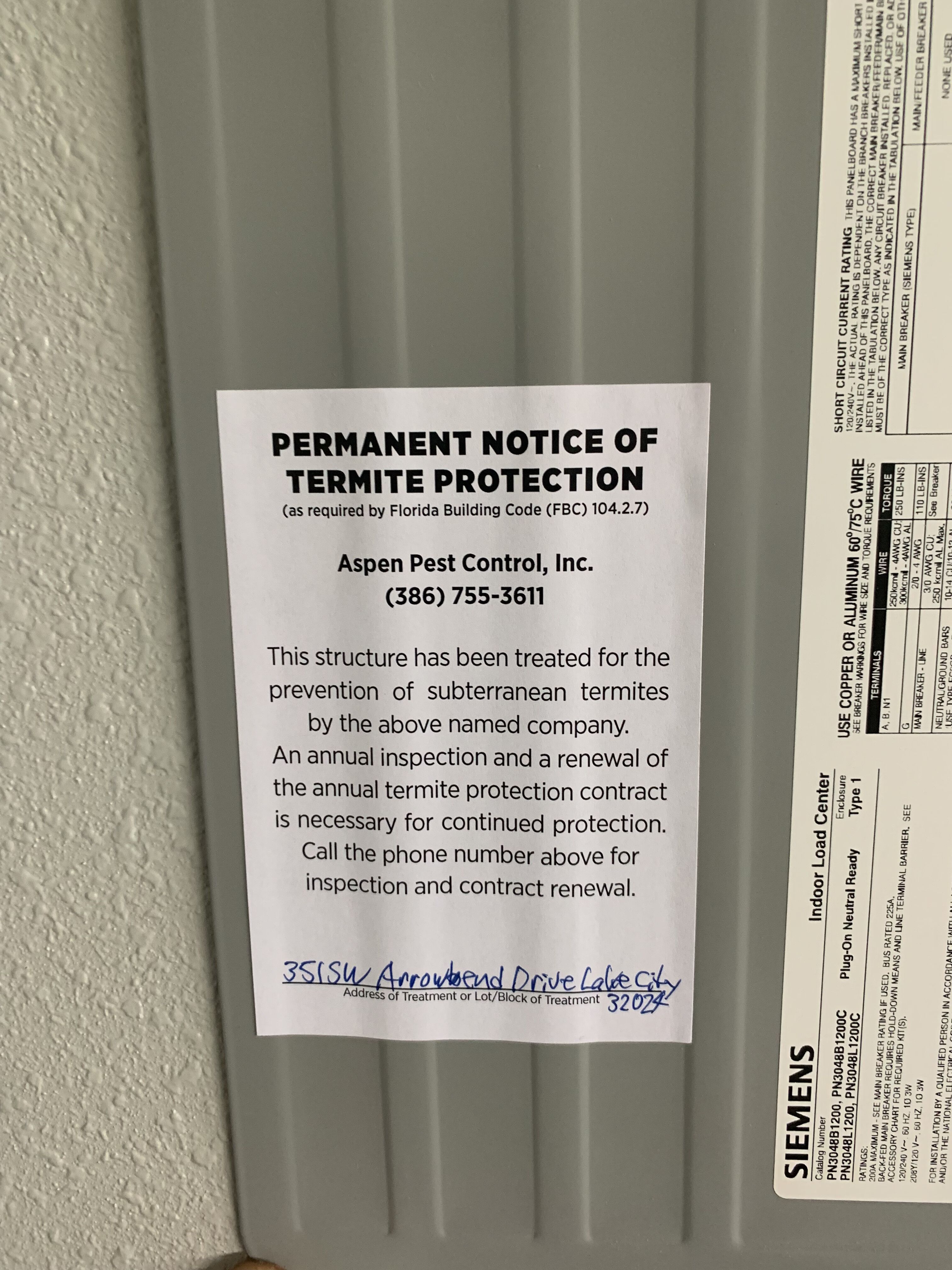

Need Blower Door Test And Final Termite Treatment To Complete Permit |
Matt Forsyth |
3/25/2022 |
Passed: Building - Final |
Items Rec |
Matt Forsyth |
4/1/2022 |
