Permit Details

Permit Search

Permit

New Residential Construction

980 SW CHARLES TER
LAKE CITY, FL 32024

Permit #
000049387
Application #
64242
Status Completed
  1. Submitted Feb 16, 2024
  2. Issued Mar 7, 2024
  3. Expires Feb 11, 2025
  4. Completed Sep 3, 2024

Property

Parcel #
00391-004
Owner
Norris Alexis,
Acres
4.99
Subdivision
—
Zoning
A-3
Flood zone
X
District
2

Permit

Status
Completed
Septic release
Released
Related permit
—

Job Details

Elevation regulation
Engineers Elevation Letter
Finished floor requirement
12 INCHES ABOVE GRADE ENTIRE PERIMITER
Document receieved
Yes
Fema map number
12023C0360C
This is the construction of a
Single Family Dwelling
Setbacks Front
30'
Setback Side 1
25'
Setback Side 2
25'
Setbacks Rear
25'
Stories
1
Heated Area (Sqft)
2880
Total Area (Sqft)
2880
Building Height
18
Building Code Construction Type
V
Building Code Element
B
Building Code Occupancy Types
Residential
Occupancy Use Title
single family dwelling
Building Code Edition
2023 Florida Building Code 8th Edition and 2020 National Electrical Code
Septic# (00-0000) or (X00-000)
24-0131
If Other, explain the use of the structure.
existing home will be lived in and removed once construction of site built is complete
Sealed roof decking options. (Must select one option per FBC 2023 8th Edition)
two layers of felt underlayment comply ASTM 0226 Type II or ASTM D4869 Type Ill or IV, or two layers of a synthetic underlayment meeting the performance requirements specified, lapped and fastened as specified.
Service Amps
200

Status & Review History

  1. Application pending.
  2. Application submitted by applicant.
  3. Plan Review - Building Approved
  4. Plan Review - Electrical Approved
  5. Plan Review - Mechanical Approved
  6. Plan Review - Plumbing Approved
  7. Plan Review - Fuel/Gas Approved
  8. Plan Review - Reviewed
  9. Point Review - Processing
  10. Zoning Review - Documents Required
  11. Zoning Review - Documents Required
  12. Zoning Review - Documents Required
  13. Zoning Review - Documents Required
  14. Zoning Review - Reviewed
  15. Final Review - Processing
  16. Final Review - Reviewed
  17. Final Review - Payment Needed
  18. Permit Issued
  19. Final Review - Payment Needed

Contractors

This is an owner-builder project.

Inspections

  1. Apr 1, 2024

    Passed: Building - Footer

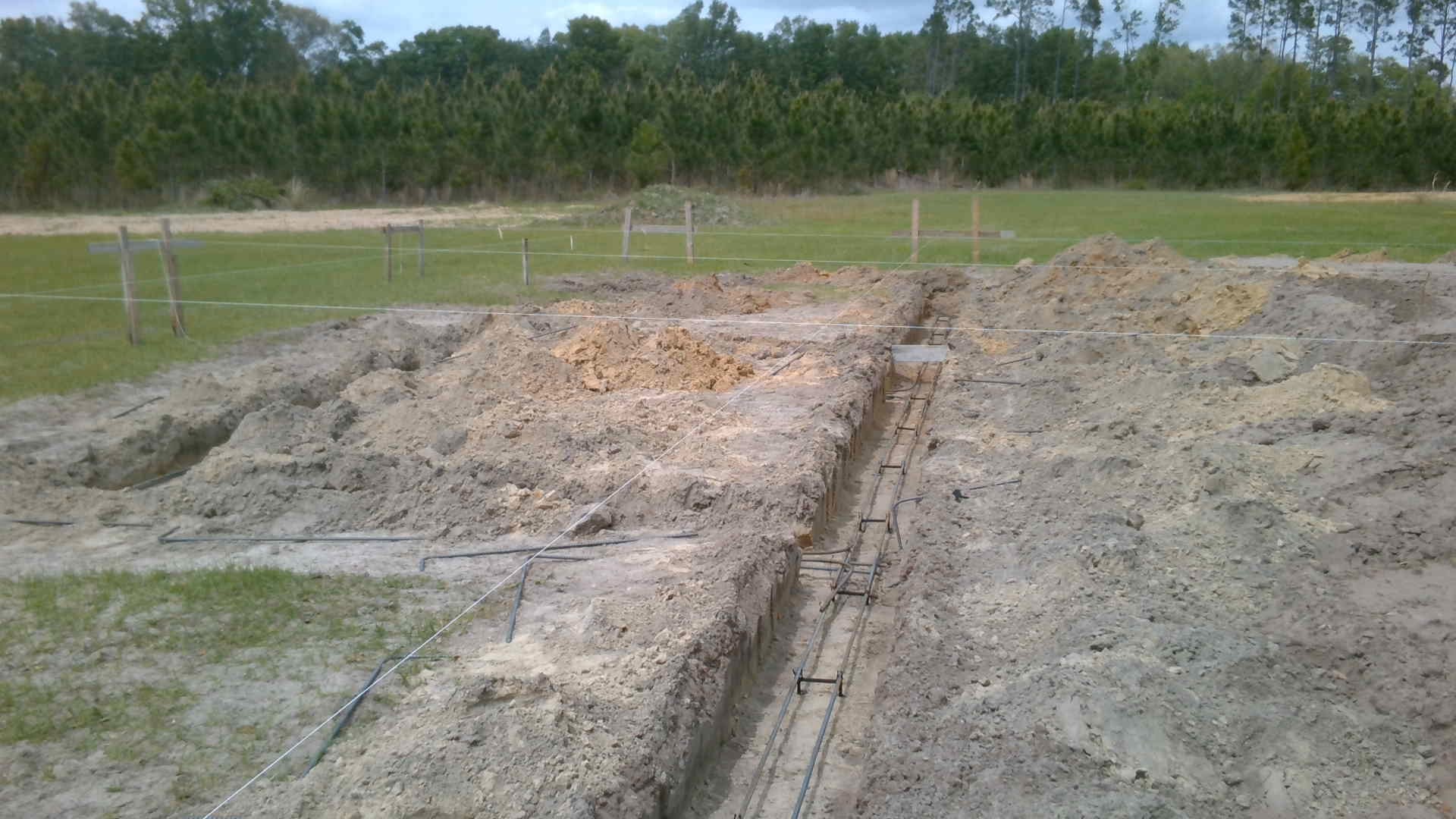

    This Will Be A Stem Wall Foundation Footing Will Be Passed Off Picture Of Grade In File

    Inspected by Matt Forsyth

  2. Apr 1, 2024

    Passed: Engineering - Setbacks

    Inspected by Matt Forsyth

  3. Apr 17, 2024

    Passed: Plumbing/Gas - 1st Underground Rough–In

    Inspected by Matt Forsyth

  4. Apr 23, 2024

    Passed: Building - Slab

    Inspected by Troy Crews

  5. May 15, 2024

    Passed: Building - Ext Strapping/Wall Sheathing

    Inspected by Matt Forsyth

  6. May 15, 2024

    Passed: Building - Roof Decking

    Inspected by Matt Forsyth

  7. May 15, 2024

    Passed: Building - Framing

    Inspected by Matt Forsyth

  8. May 23, 2024

    Passed: Electrical - 2nd Rough-In

    Nail Plate Missing Behind Electrical Panel Box Top Plate Will Check On Insulation Inspection

    Inspected by Matt Forsyth

  9. May 23, 2024

    Passed: Mechanical - Rough In

    Inspected by Matt Forsyth

  10. May 23, 2024

    Passed: Plumbing/Gas - 2nd Rough-In

    Tub Water Tested For Leaks

    Inspected by Matt Forsyth

  11. Jun 3, 2024

    Passed: Building - Rated Assembly Fastening

    Make Up Air

    Inspected by Matt Forsyth

  12. Jun 3, 2024

    Passed: Building - Roof Decking

    Master Rib Metal Panels

    Inspected by Matt Forsyth

  13. Jun 5, 2024

    Cancelled: Building - Insulation

    Inspected by Neonta Anderson

  14. Jun 10, 2024

    Passed: Building - Insulation

    Inspected by Matt Forsyth

  15. Aug 15, 2024

    Passed: Electrical - Permanent Power

    Need Septic Release For Permanent Power Release

    Inspected by Matt Forsyth

  16. Aug 20, 2024

    Release to power company

    Rec'd Septic

    Inspected by Emaleigh Williams

  17. Aug 20, 2024

    Septic Release Inspection

    Inspected by Health Dept

  18. Aug 26, 2024

    Cancelled: Electrical - Permanent Power

    Inspected by Troy Crews

  19. Aug 27, 2024

    Failed: Building - Final

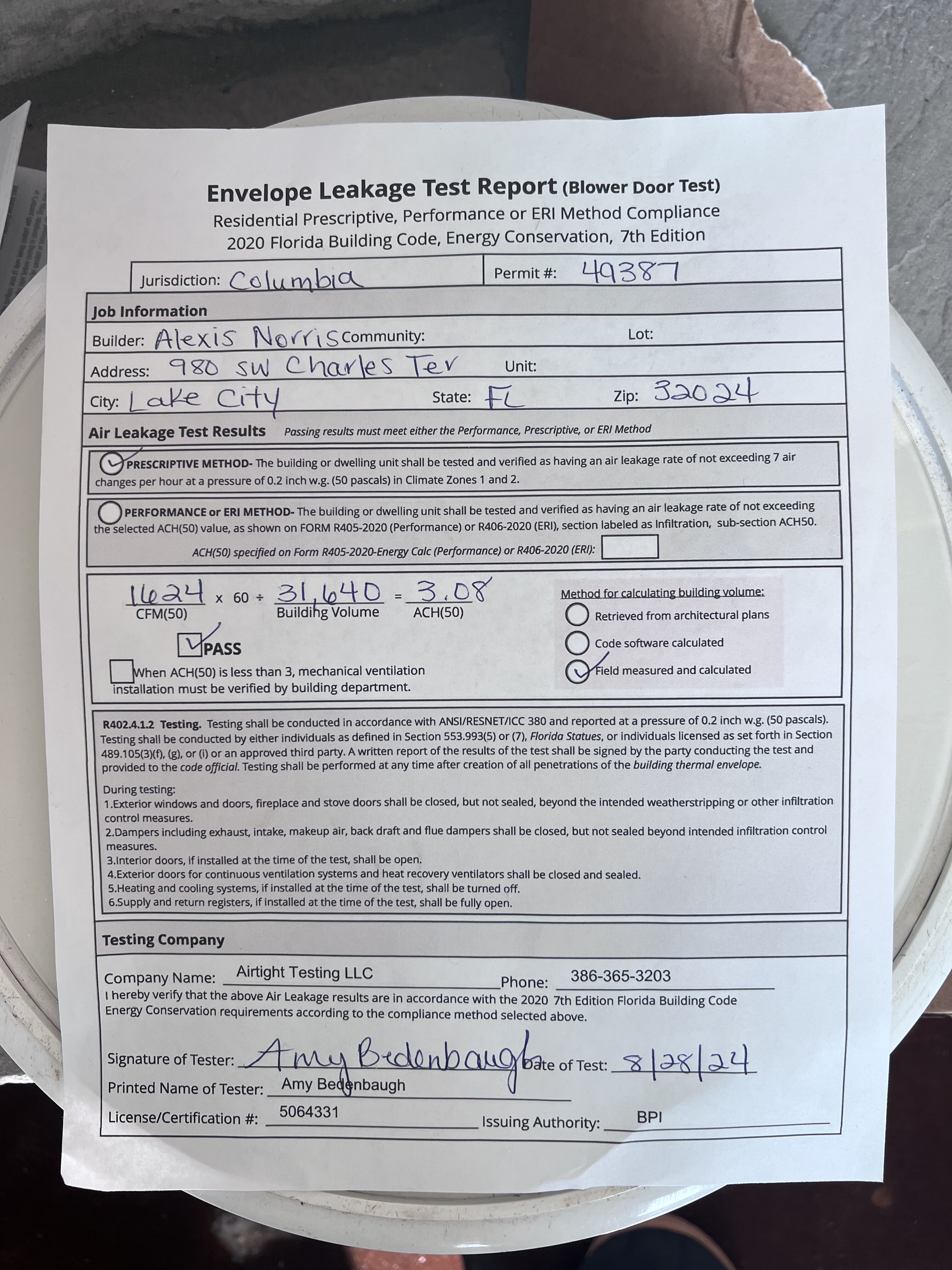

    #1 Seal Floor.#2 Provide Landing At Back Door Or Step.#3 Receive And Review Blower Door Test.#4 Final Termite Treatment

    Inspected by Matt Forsyth

  20. Sep 3, 2024

    Building-Final

    Inspected by Matt Forsyth

Documents
