| Passed: Building - Footer |
|
Matt Forsyth |
10/20/2021 |
| Passed: Engineering - Setbacks |
|
Matt Forsyth |
10/20/2021 |
| Passed: Plumbing/Gas - 1st Underground Rough–In |
|
Anthony Aslan |
11/17/2021 |
| Passed: Building - Slab |

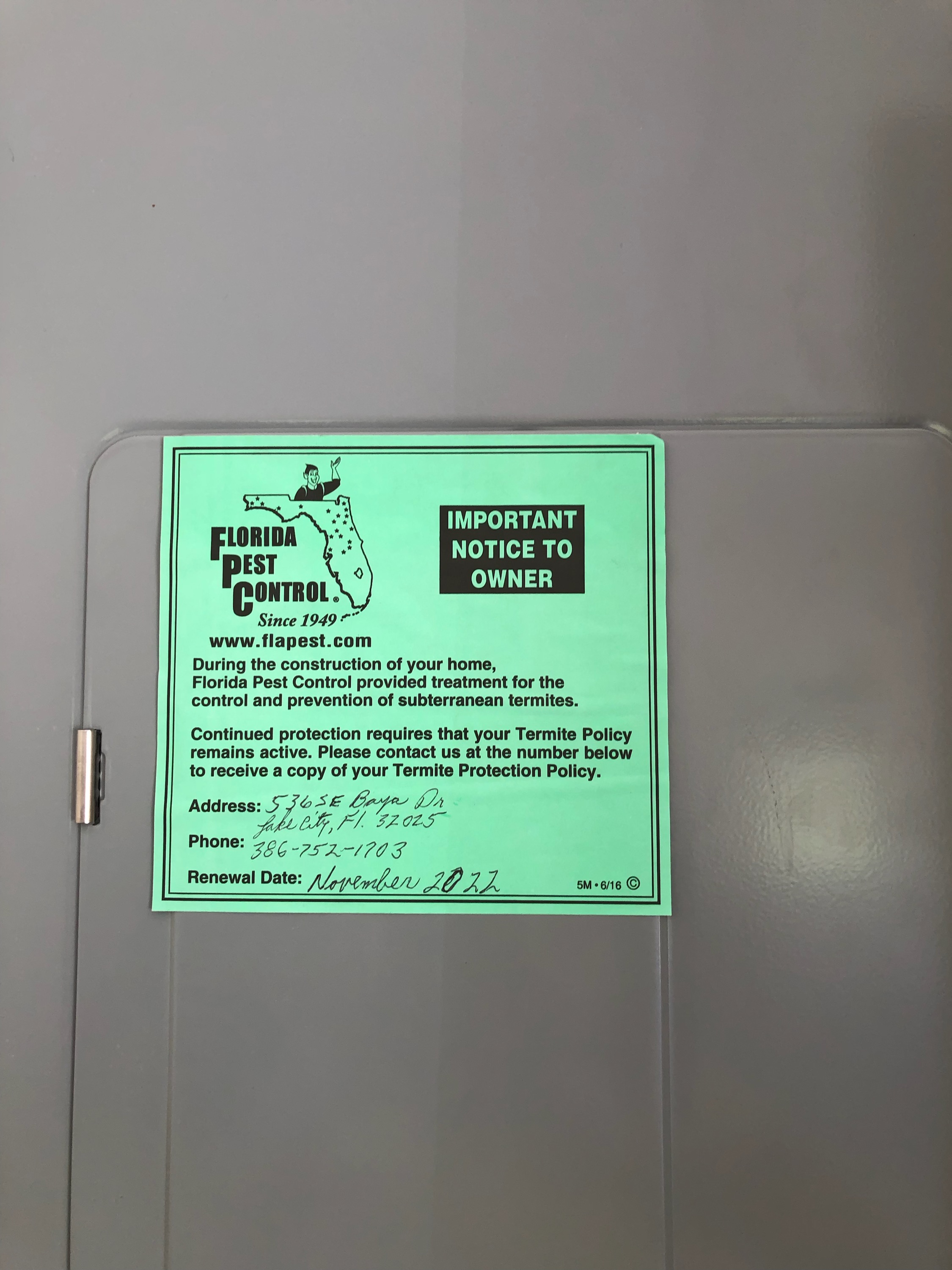

Termite Uploaded |
Anthony Aslan |
11/29/2021 |
| Passed: Electrical - Temporary Service |
|
Anthony Aslan |
1/12/2022 |
| Release to power company |
|
Anthony Aslan |
1/12/2022 |
| Failed: Building - Lintel/Tie Beam |
Block Cells Were Pumped Without Being Inspected Need Letter From Engineer On Blockwork |
Matt Forsyth |
1/21/2022 |
| Failed: Building - Roof Decking |
Not Complete Schedule For Wed |
Matt Forsyth |
2/21/2022 |
| Passed: Building - Lintel/Tie Beam |
|
Matt Forsyth |
2/22/2022 |
| Passed: Building - Roof Decking |
|
Matt Forsyth |
2/23/2022 |
| Passed: Building - Framing |
|
Matt Forsyth |
3/3/2022 |
| Passed: Plumbing/Gas - 2nd Rough-In |
Tub Was Water Tested |
Matt Forsyth |
3/3/2022 |
| Passed: Electrical - 2nd Rough-In |
|
Matt Forsyth |
3/3/2022 |
| Failed: Mechanical - Rough In |
Not Complete |
Matt Forsyth |
3/7/2022 |
| Passed: Building - Insulation |
|
Matt Forsyth |
3/10/2022 |
| Passed: Mechanical - Rough In |
|
Matt Forsyth |
3/10/2022 |
| Passed: Electrical - Permanent Power |
Need Septic Release For Power - Rec'd 4.25.22 |
Matt Forsyth |
4/7/2022 |
| Release to power company |
Rec'd Eh 4.25.22 |
Matt Forsyth |
4/25/2022 |
| Septic Release Inspection |
|
Health Dept |
4/25/2022 |
| Failed: Building - Final |
Few Items Need To Be Addressed |
Matt Forsyth |
5/12/2022 |
| Passed: Building - Final |
|
Matt Forsyth |
5/18/2022 |
