Right-of-Way Access/Driveway
Permit
| Application #: | 76245 |
| Permit #: |
000055831 |
| Related Permit: |
New Residential Construction: |
| Submitted: | Friday, May 22, 2026 |
| Issued: | Thursday, June 4, 2026 |
| Expires: | Sunday, June 3, 2029 |
| Completed: | |
| Status: |
Permit Issued |
| Septic Release? |
N/A |
Job Details
| Finished floor requirement |
|
| Fema map number |
12023C0289D |
| Standards |

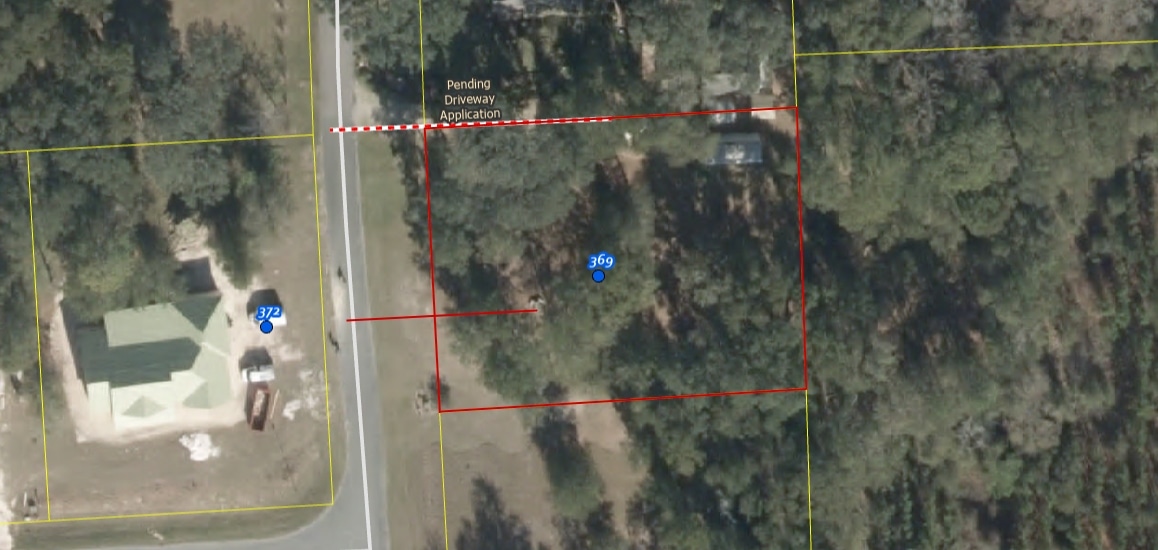

Driveway construction shall conform to the approved plan |
| Status |
Permanent |
| Type of connection for access road |
Rural Driveway |
| Type of construction of property |
Site Built Home |
| Normal vehicle usage: |
Automobiles;Trucks |
| Side Drain required |
No |
| Study Required |
No |
| Estimated Number of Vehicle trips per day |
2 |
| Is the access for commercial or residential use? |
Residential |
| County Road Type |
Paved |
Review Notes
| 5/15/2026 |
Email confirmation reminder sent. |
| 5/22/2026 |
Application submitted by applicant. |
| 5/22/2026 |
Pending Public Works Application Approval |
| 5/22/2026 |
Application submitted by applicant. |
| 5/22/2026 |
Pending Public Works Application Approval |
| 5/22/2026 |
Application submitted by applicant. |
| 5/22/2026 |
Pending Public Works Application Approval |
| 5/22/2026 |
Application submitted by applicant. |
| 5/22/2026 |
Pending Public Works Application Approval |
| 6/2/2026 |
Application Approved by Public Works |
| 6/2/2026 |
Application Approved by Public Works |
| 6/3/2026 |
Pending initial driveway inspection |
| 6/3/2026 |
Application Status Update Notification |
| 6/4/2026 |
Permit Issued |
Contractors
| Name / Business |
License |
Title |
Role |
Inspections
| Inspection |
Notes |
Performed By |
Date |
| Failed: Engineering - Verify Easement Requirements |
As Drawn, The New Construction Will Require An Easement To Use The Existing Driveway On Lot 6. Please Provide And Easement Across Lot 6 To Access Lot 33, Or Permit A New Driveway Directly Accessing Lot 33. |
Chad Williams |
5/22/2026 |
| Passed: Engineering - ROW Access/Driveway connects to county maintained road |
|
Chad Williams |
5/25/2026 |
| Passed: Engineering - ROW Access/Driveway connects to county maintained road |
|
Chad Williams |
6/2/2026 |
| Passed: Engineering - Initial Driveway |
|
Smith, Blake |
6/4/2026 |
